01

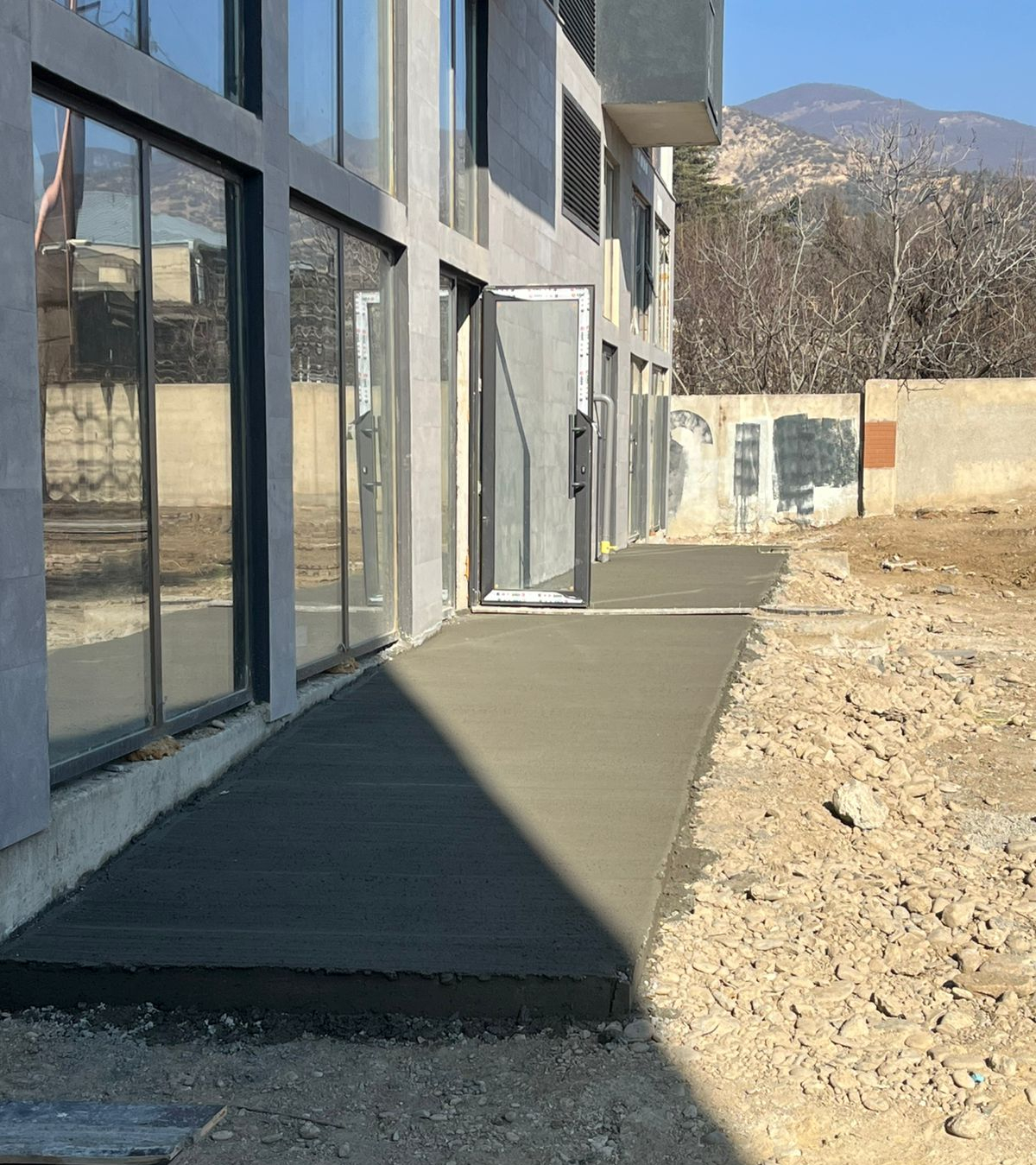

06 February -2025

Yard work

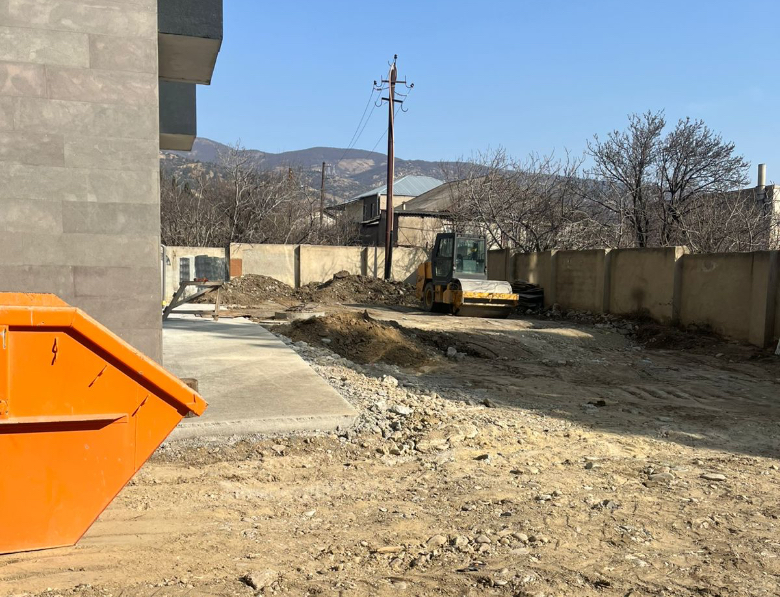

Yard paving works are underway.

Yard work

timeline 1 timeline 1
02
24 January -2025

Ramp

A ramp has been installed and railings are being installed. Yard landscaping work is actively underway.

Ramp
timeline 2 timeline 2 timeline 2 timeline 2

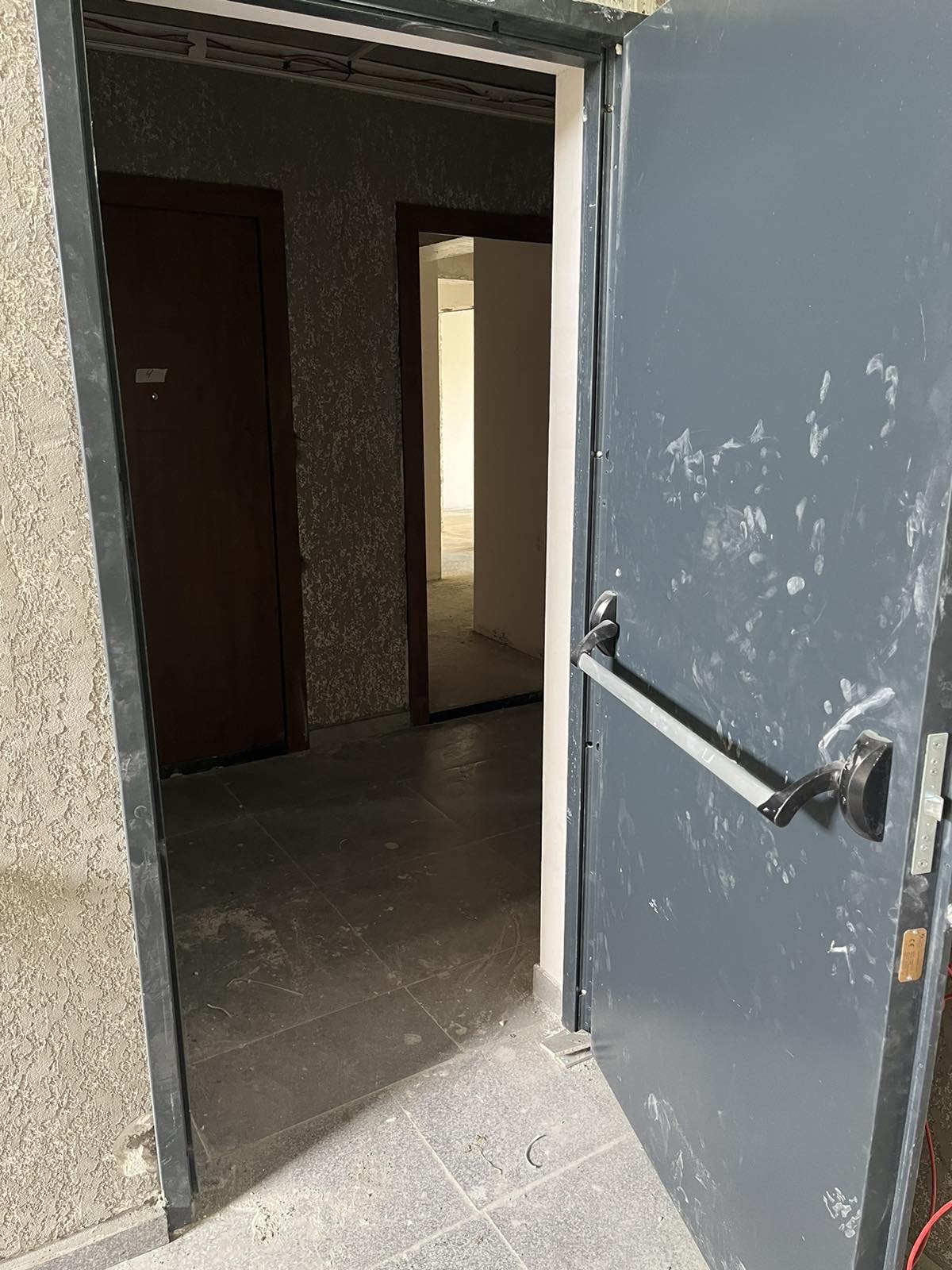

03
20 December -2024

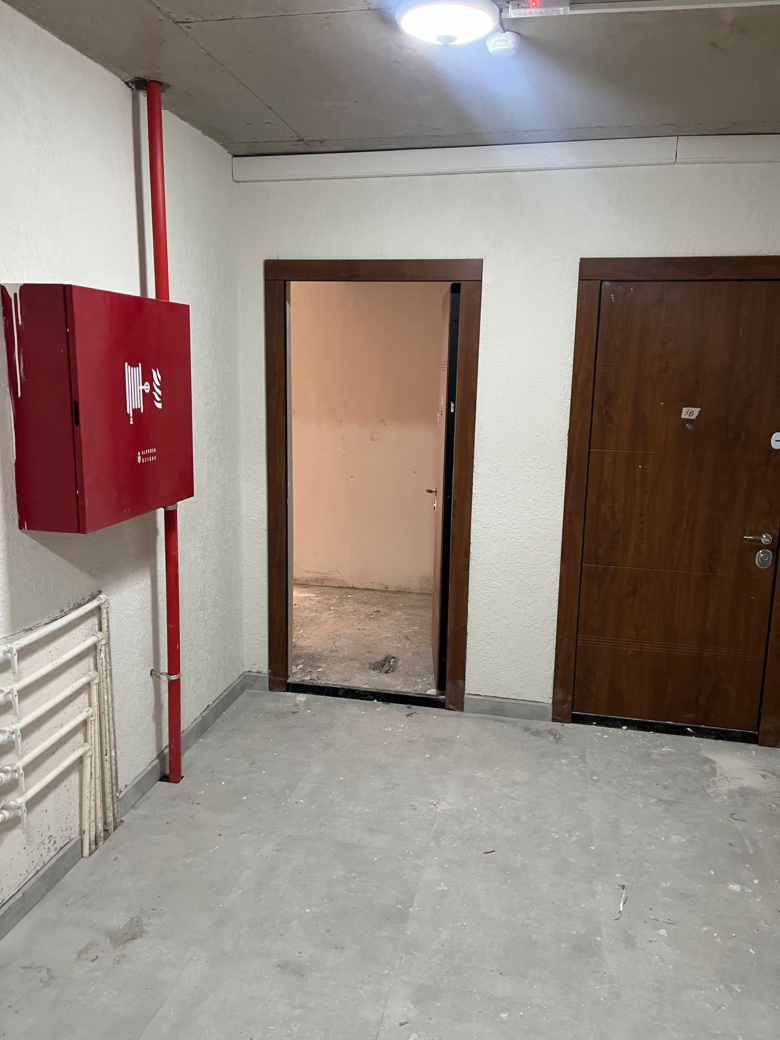

Fire doors

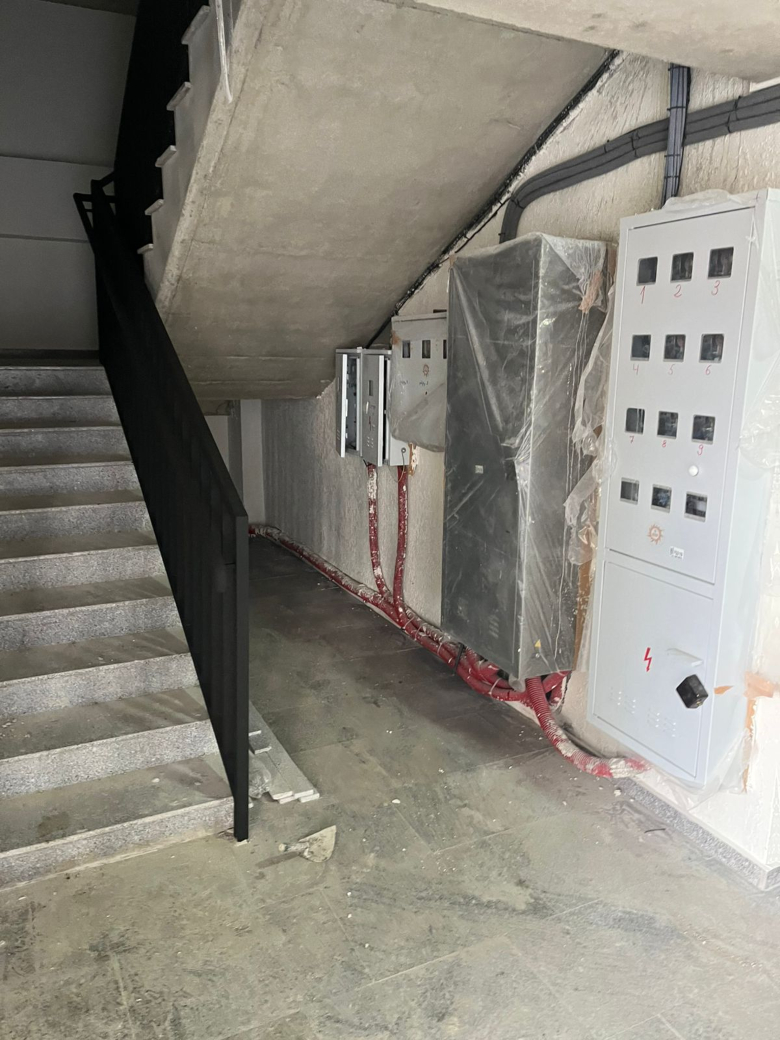

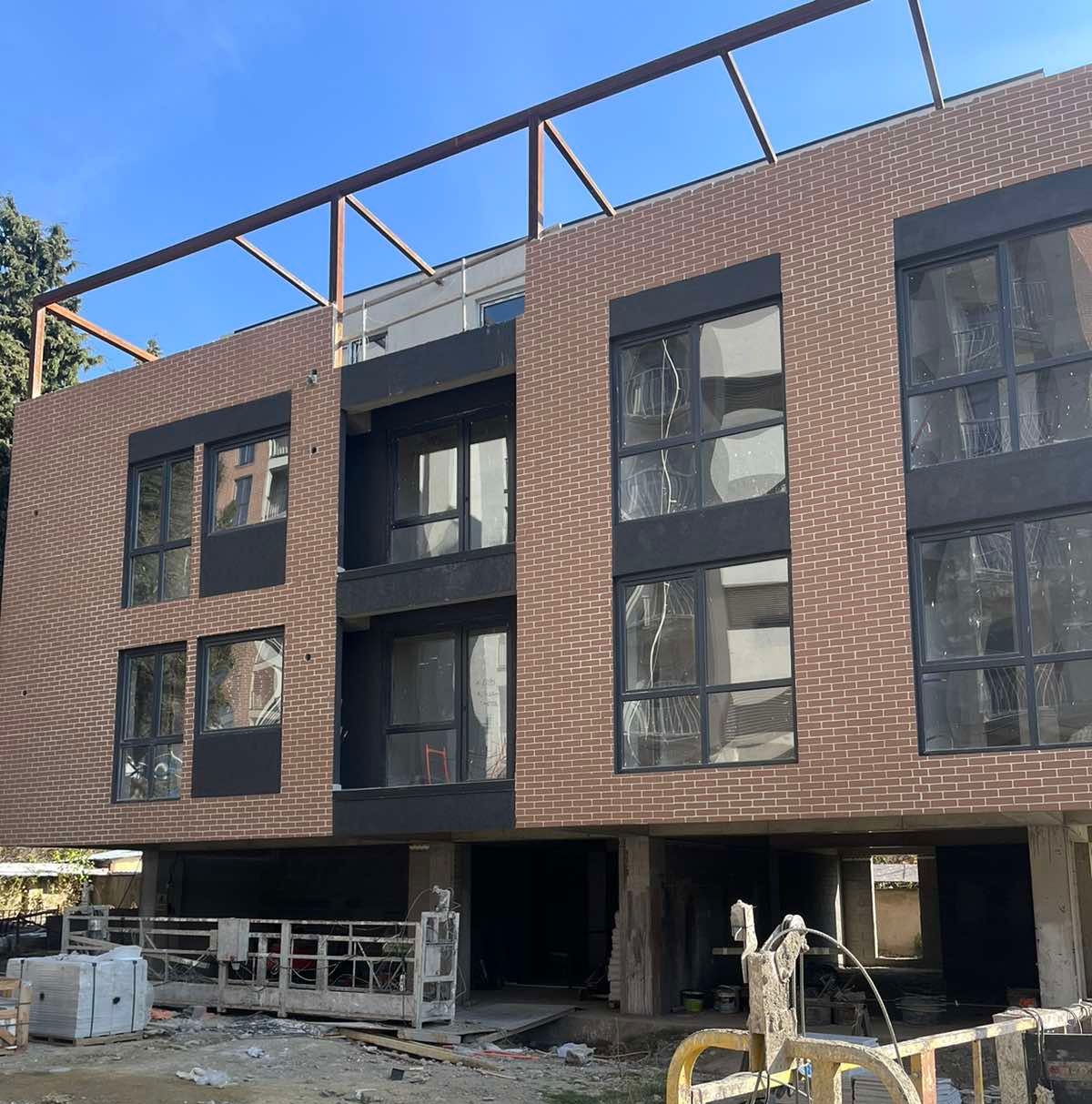

Block B - Installation of fire doors has been completed, communications (electricity, water and gas) have been installed and gas shafts are being constructed. Stained glass windows have also been installed and glazing work is underway;

Block C - Installation of the fire system and apartment entrance doors has been completed, gas shafts are being constructed.

Fire doors
timeline 3 timeline 3
04
20 November -2024

B and C block

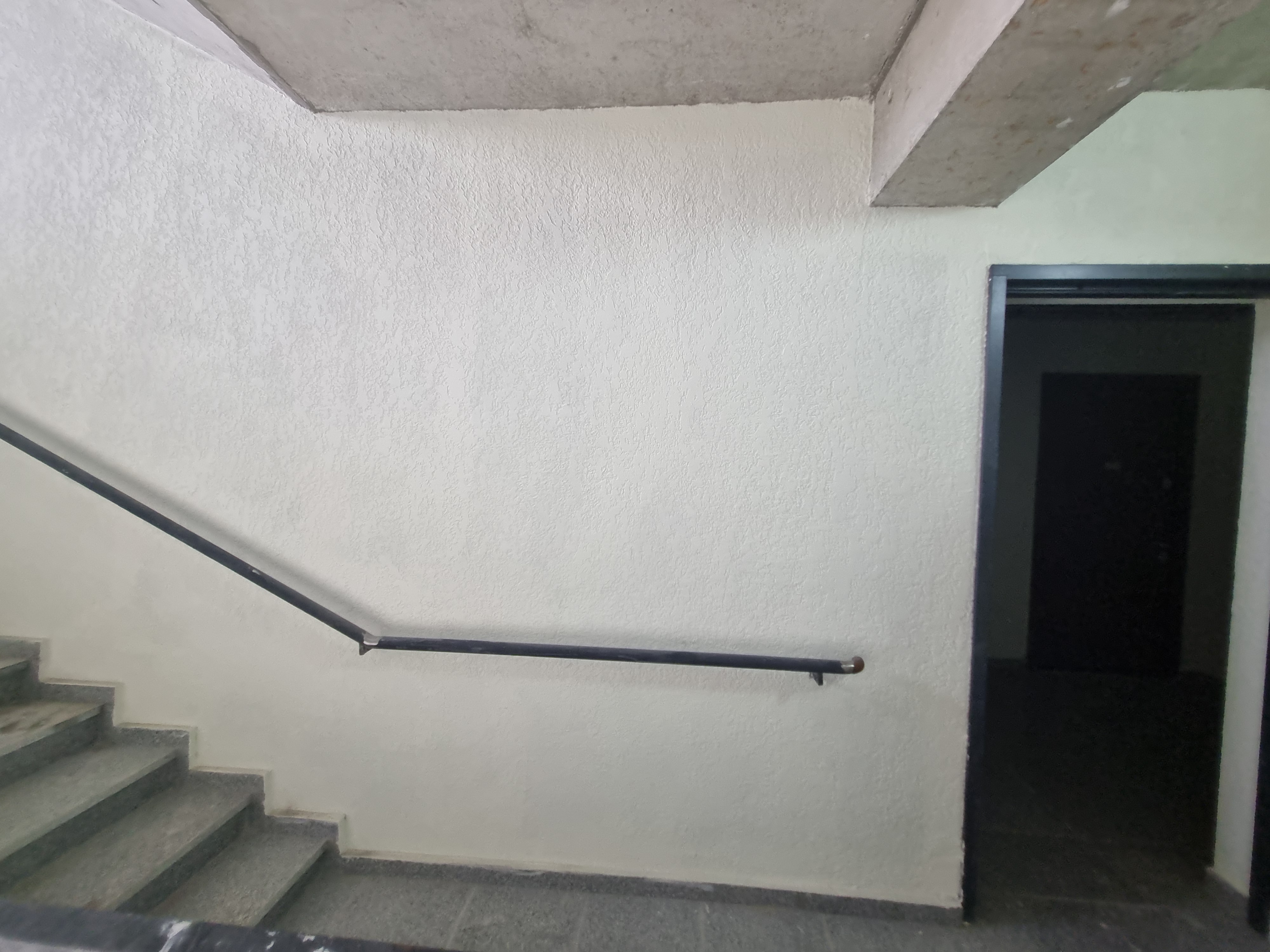

Block B - The installation of the stairs has been completed, the installation of the apartment's entrance doors and windows, the fire system and balcony railings have been installed.

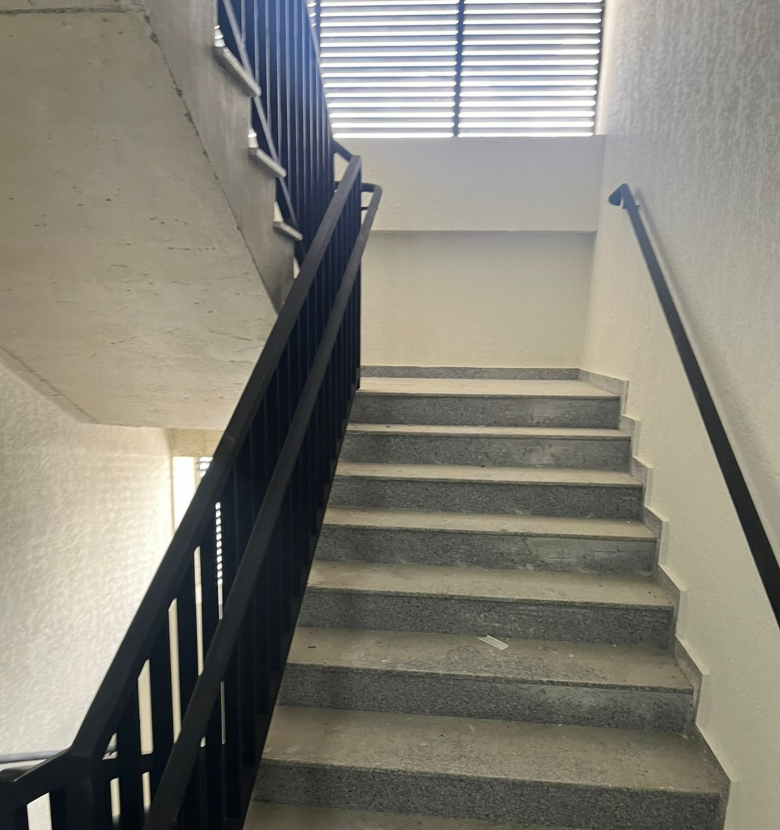

Block C - The facade works and the installation of the stair railings have been completed, ceramic granite has been laid on the balconies. Preparatory work is underway for the installation of the fire system and the apartment's entrance doors.

B and C block
timeline 4
05
23 October -2024

B and C block

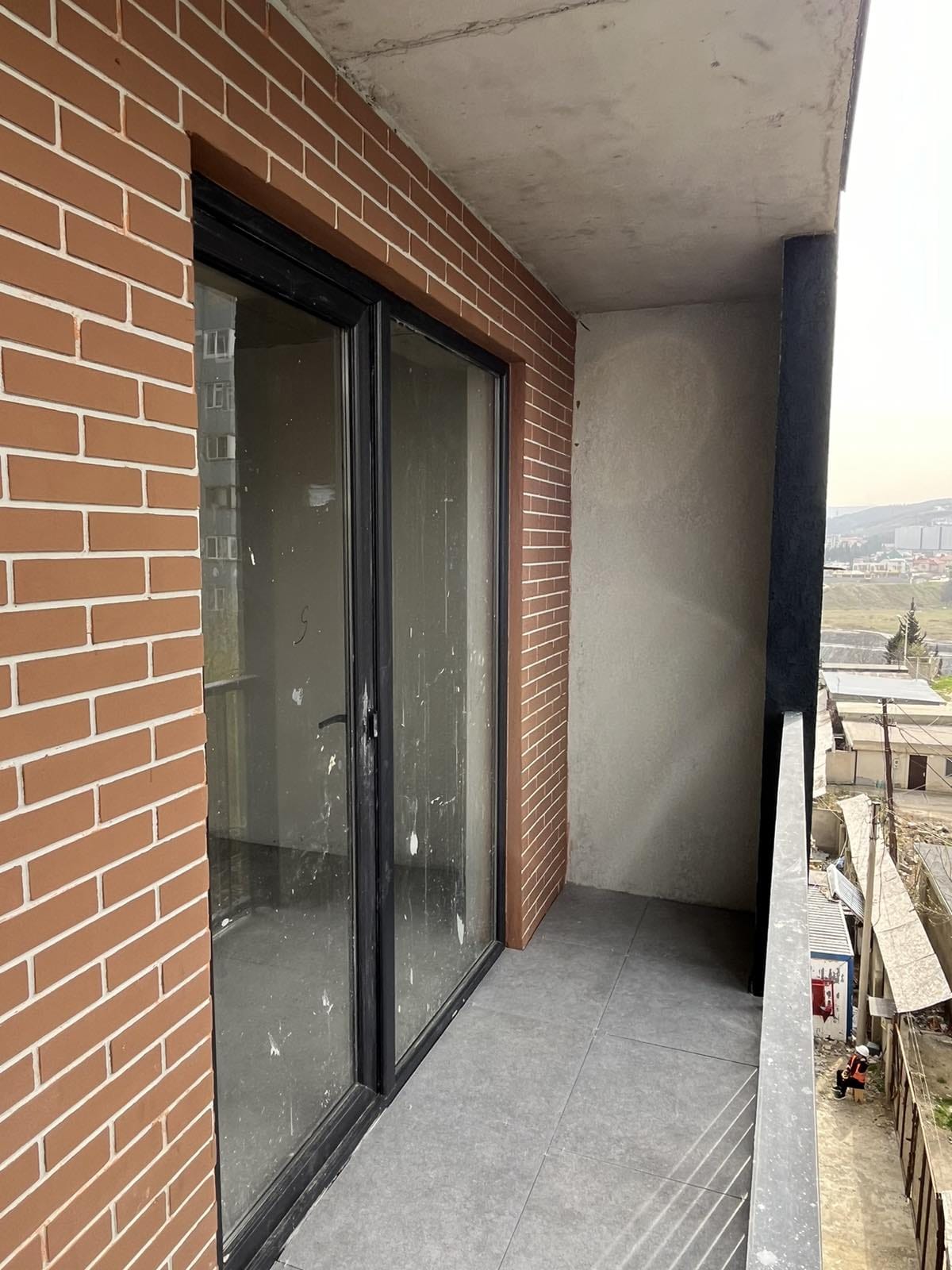

Block B - gas meters were installed, ceramic granite was laid on the entrance hall and balcony, a fire system was made, the entrance doors of the apartment are being installed;

Block C - facade finishing works are being completed, roof covering is finished. The stretch floor is being laid.

B and C block
timeline 5 timeline 5 timeline 5 timeline 5

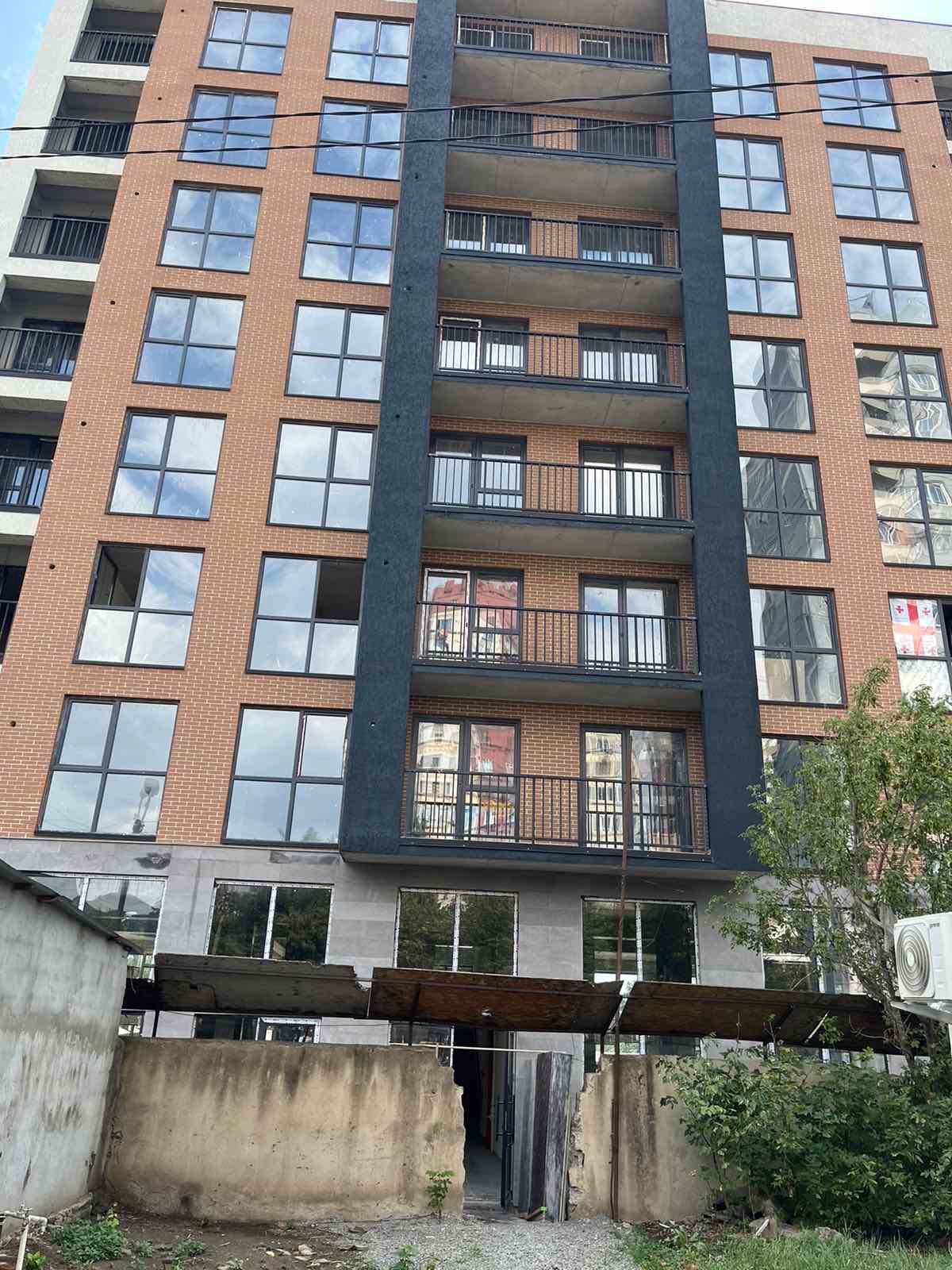

06
09 September -2024

Internal works

Block A - completed;

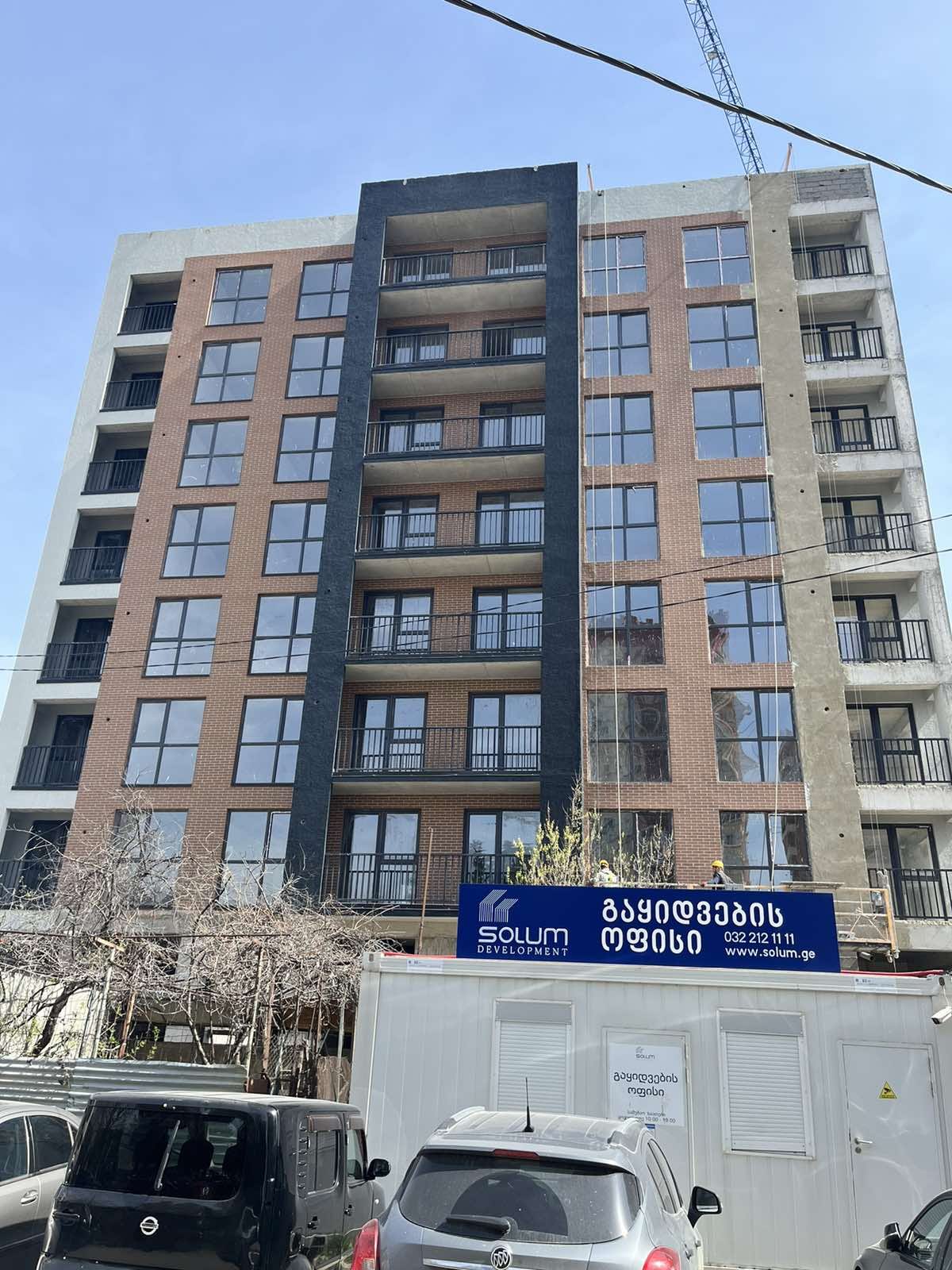

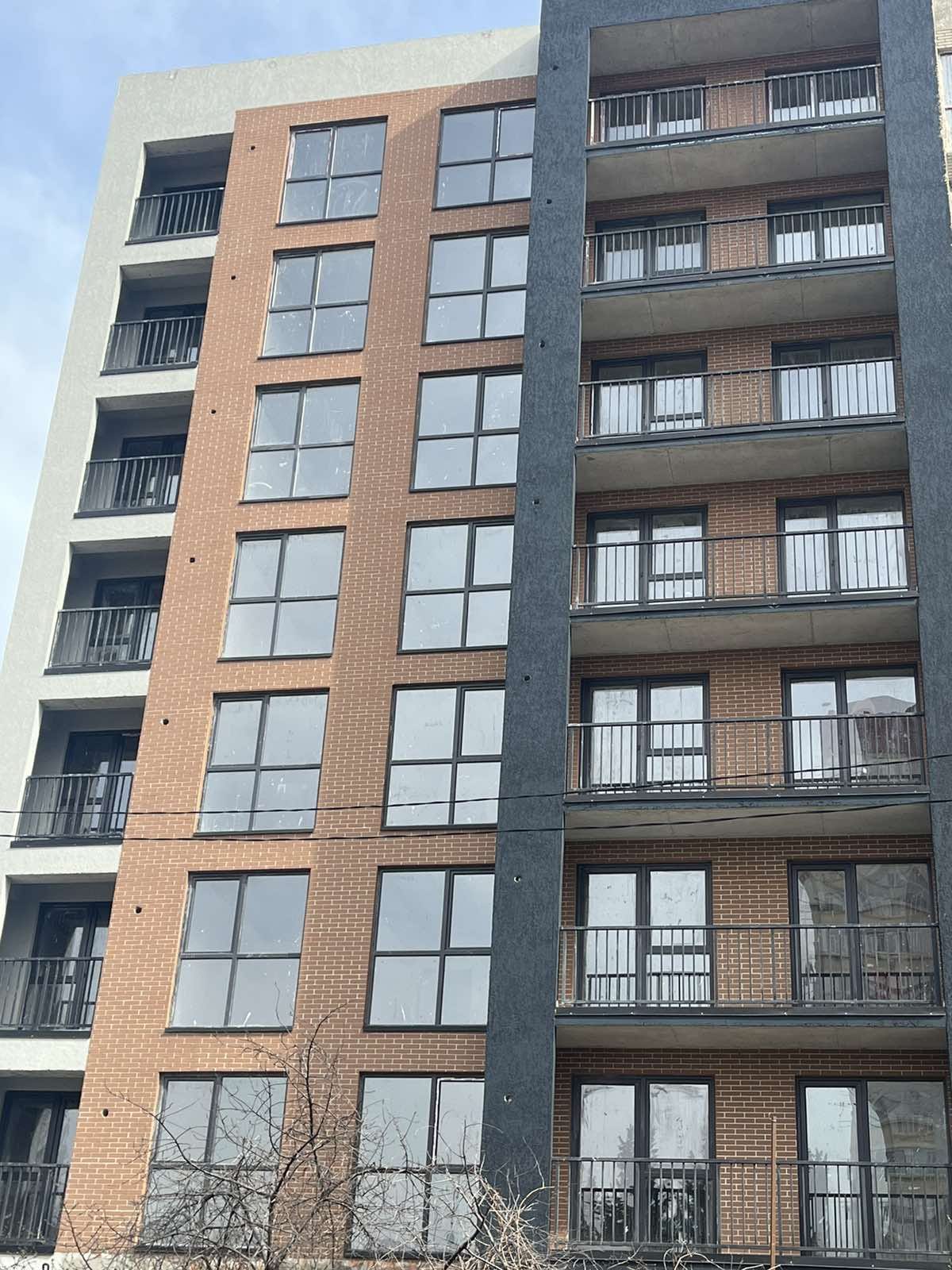

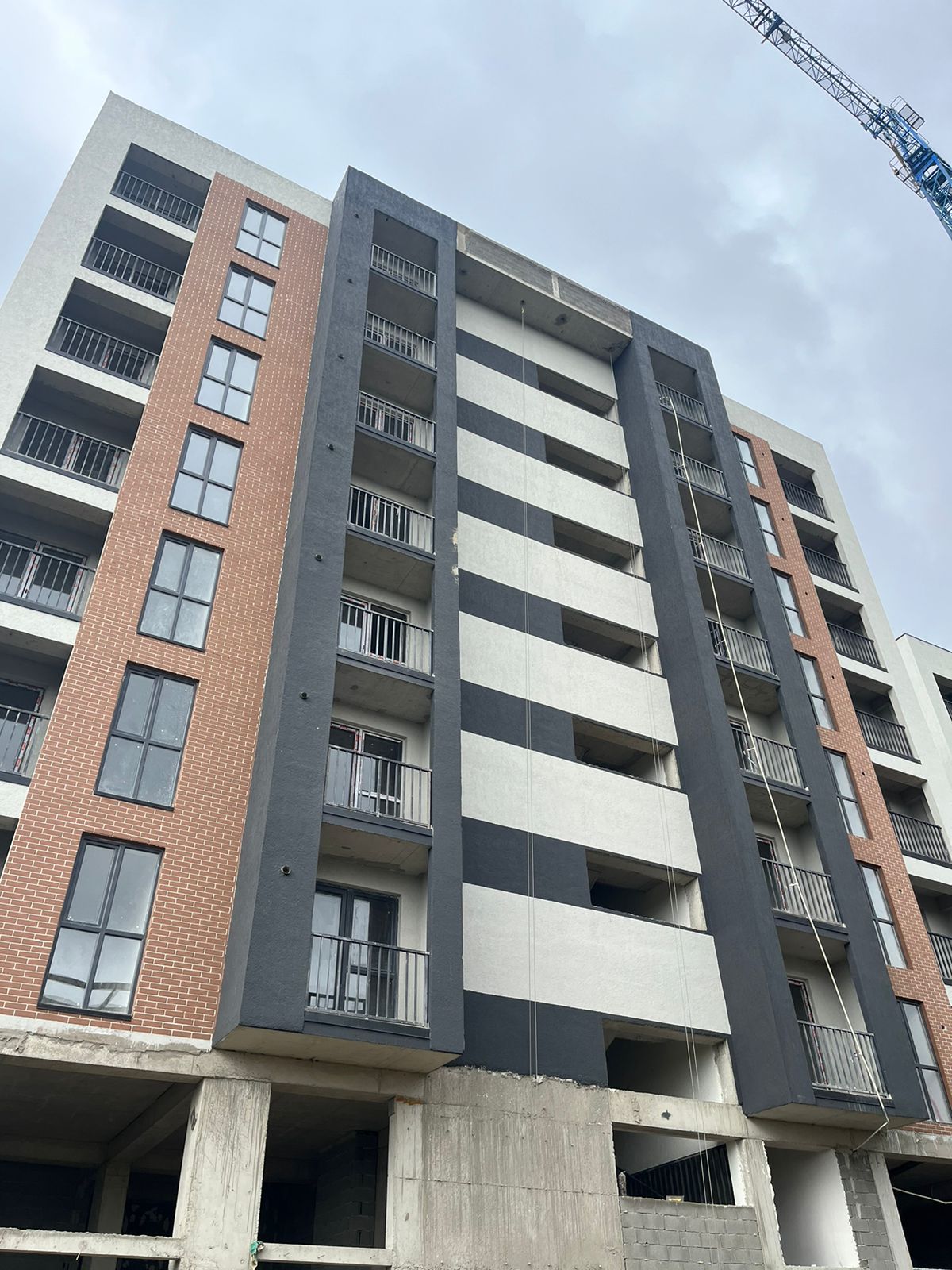

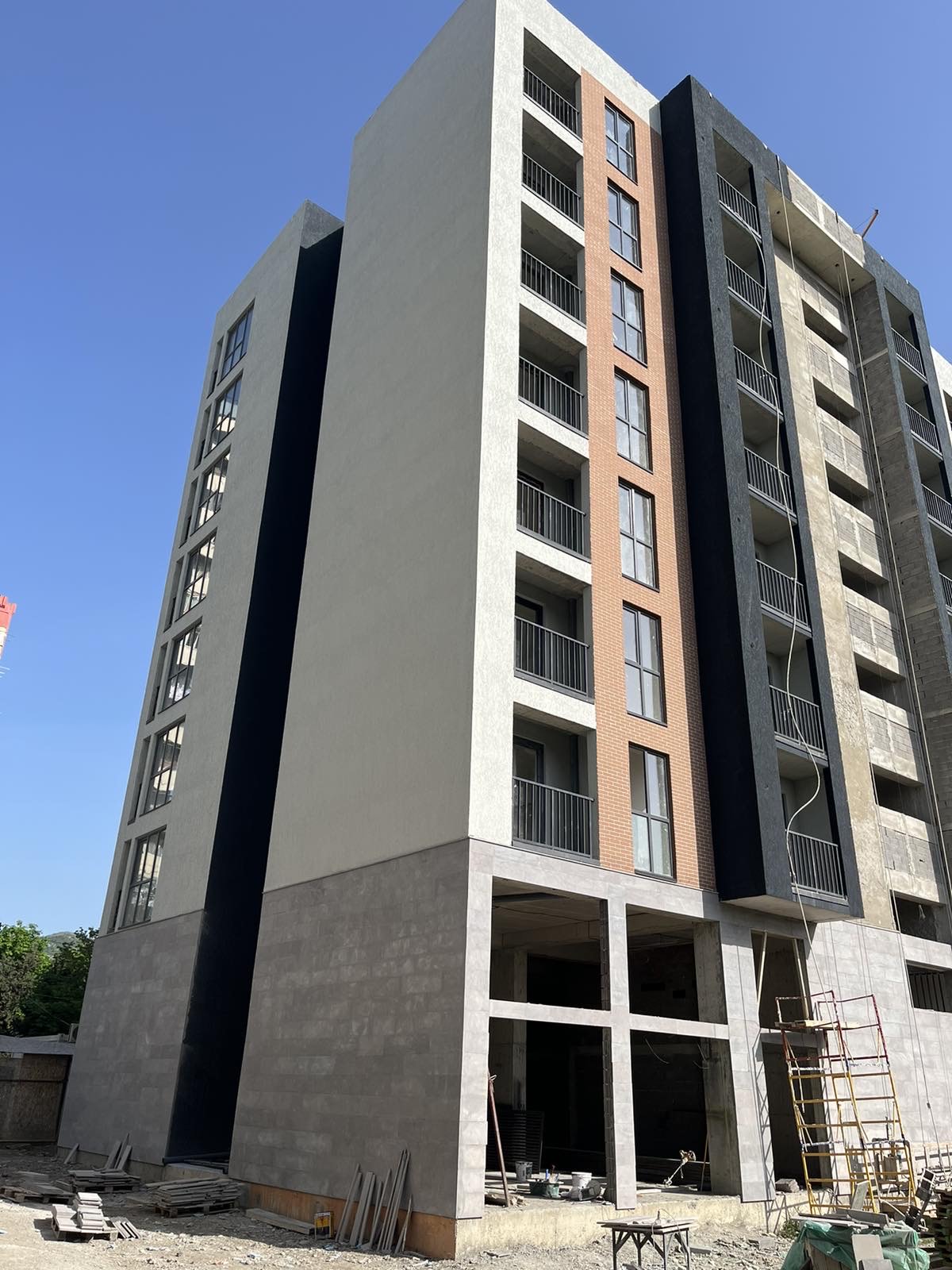

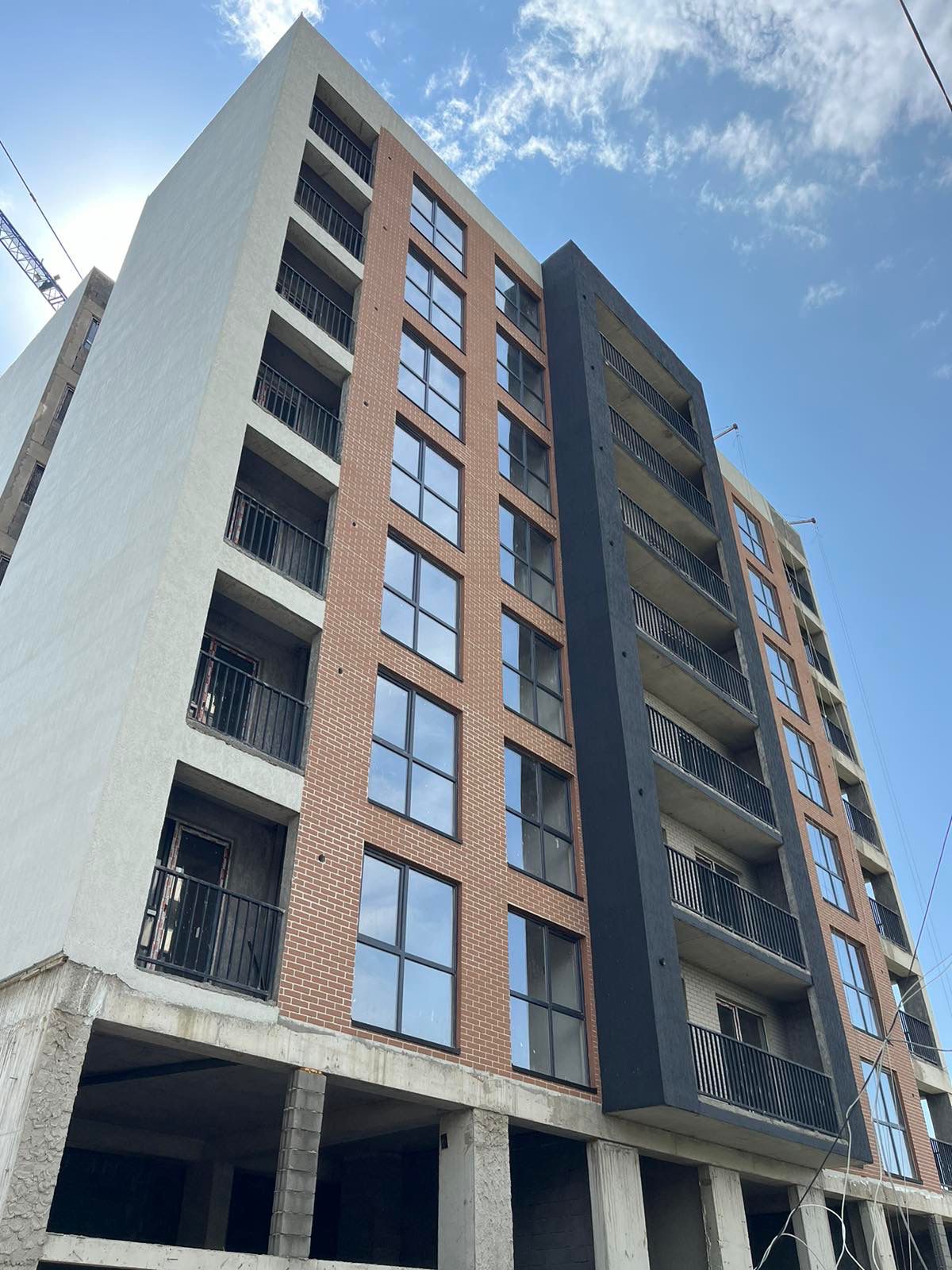

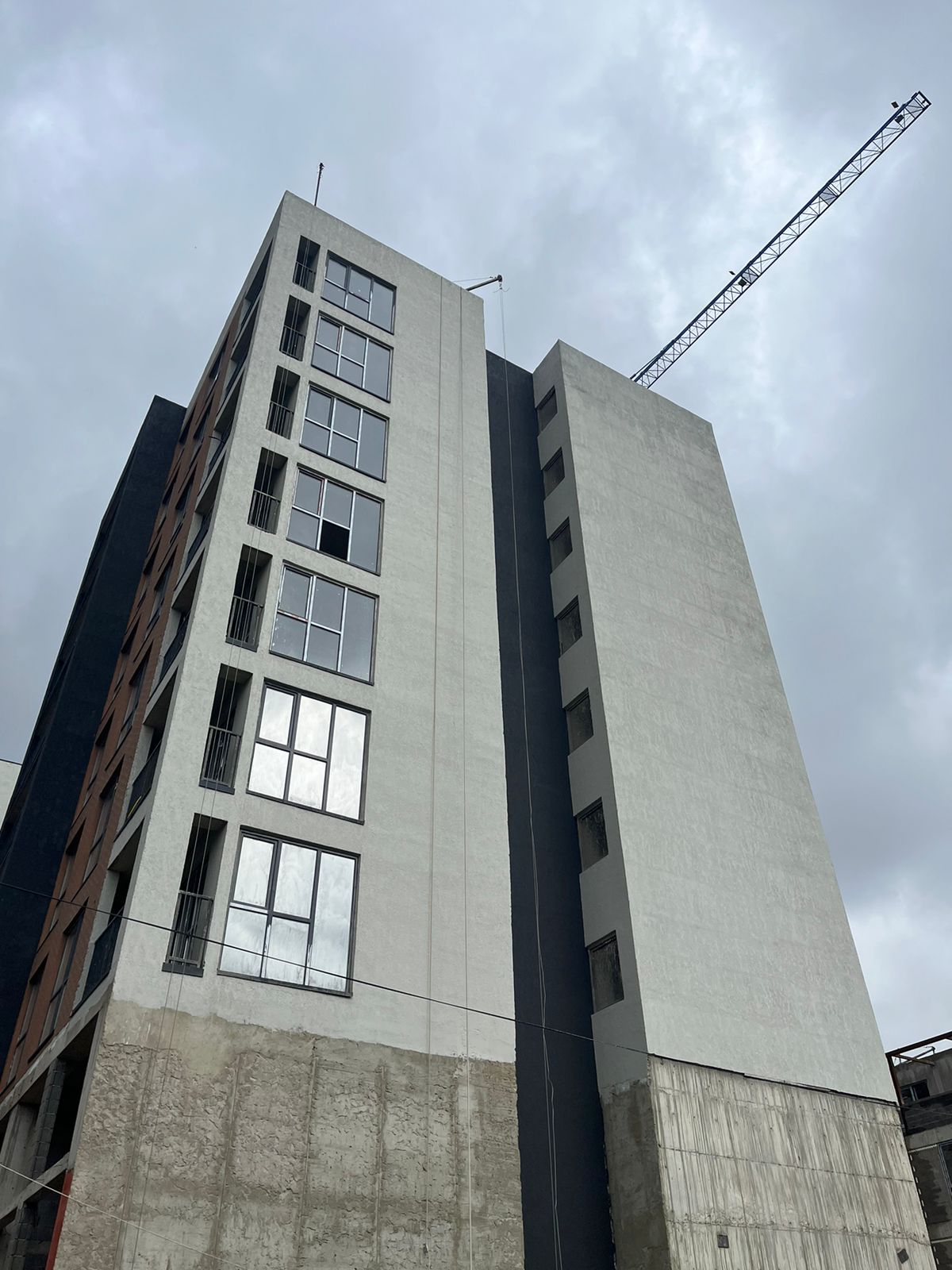

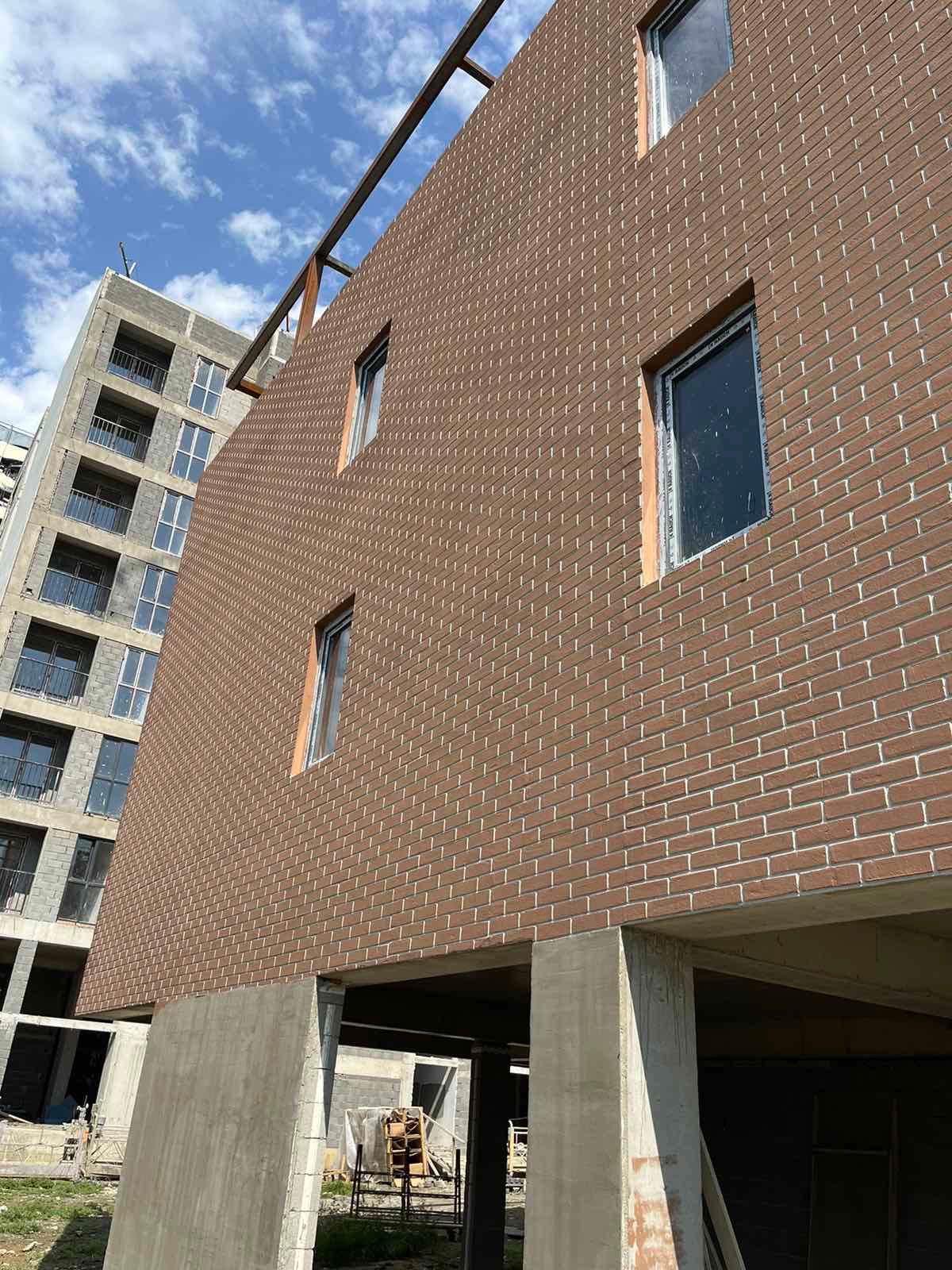

Block B - finishing of the facade and decoration of the entrance was completed, an elevator was installed;

Block C - interior partitions are being plastered and the exterior facade is being finished, an elevator has been installed.

Internal works
timeline 6 timeline 6

07

15 July -2024

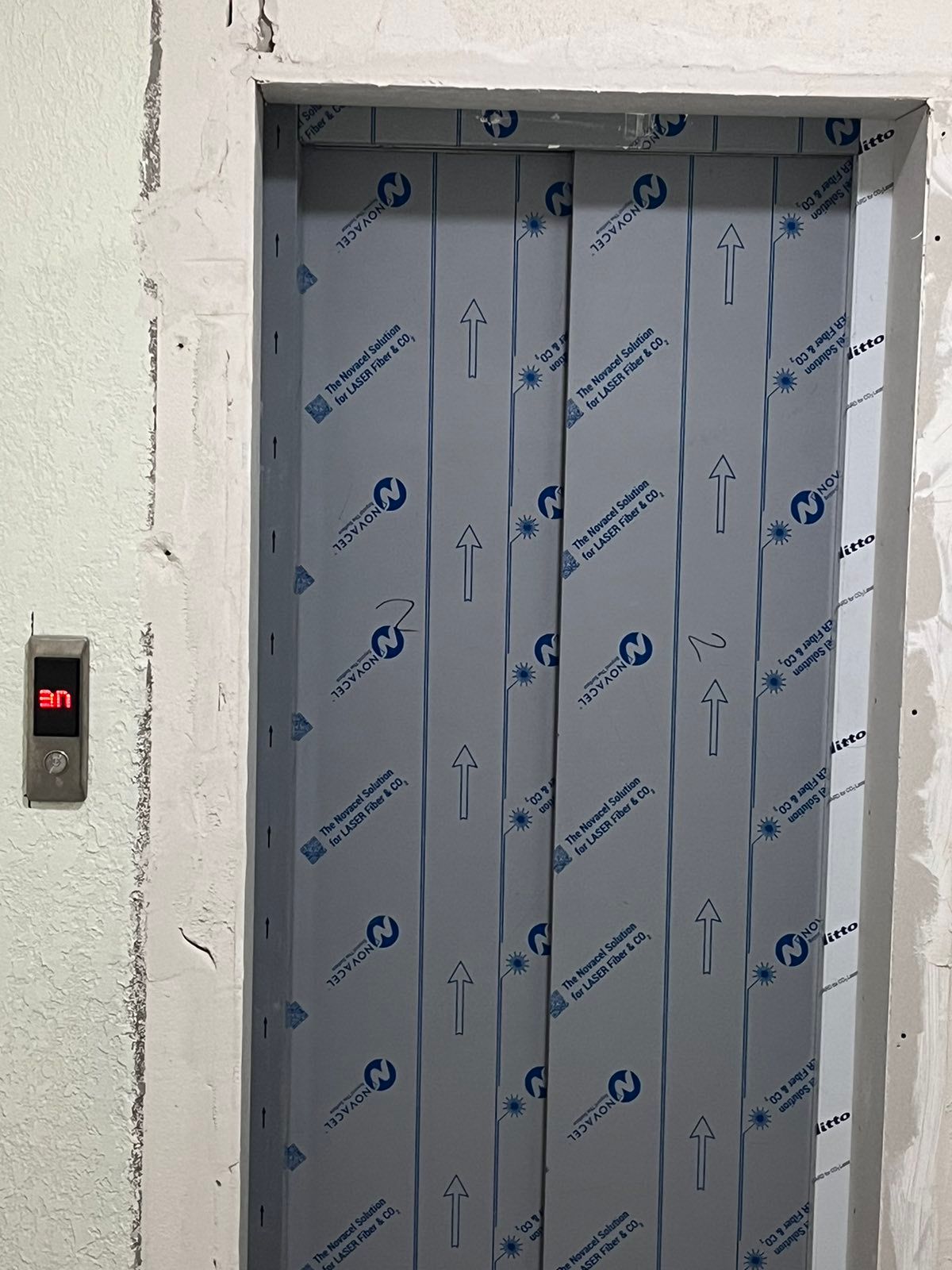

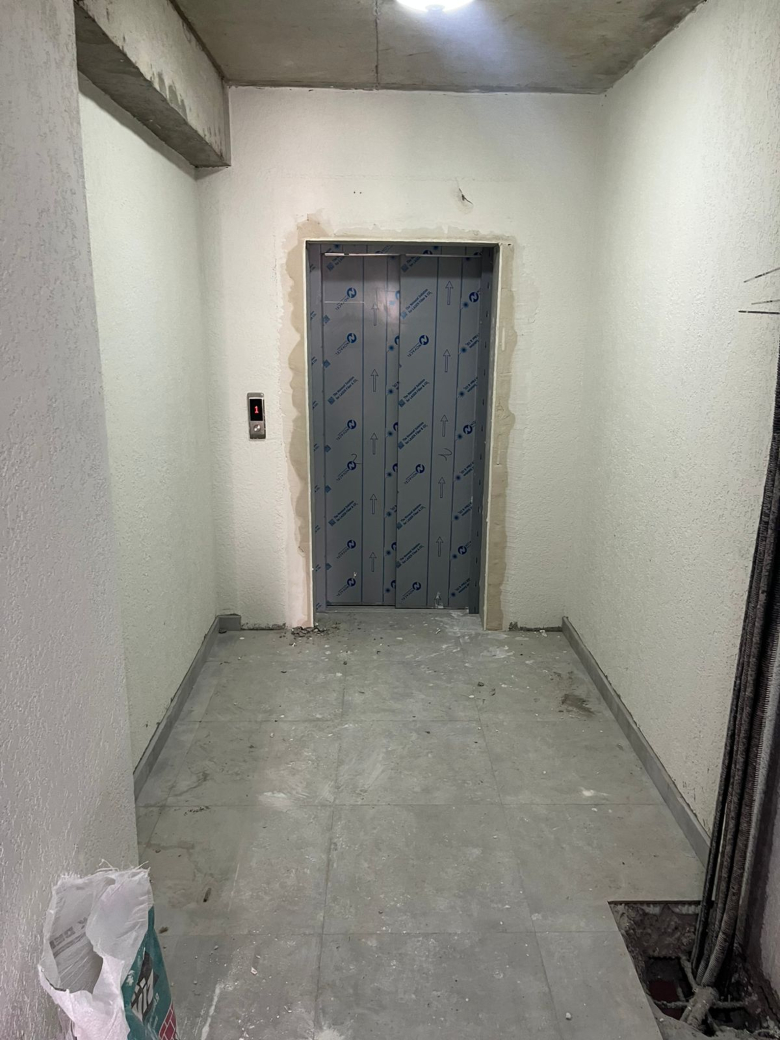

Elevator Installation

Elevator installation works are underway in Avchala.

Elevator Installation
timeline 7 timeline 7 timeline 7
08
27 June -2024

Repair Works

Residents of Block A of Avchala have started internal repair work.

Repair Works
timeline 8 timeline 8 timeline 8 timeline 8 timeline 8 timeline 8
09
30 April -2024

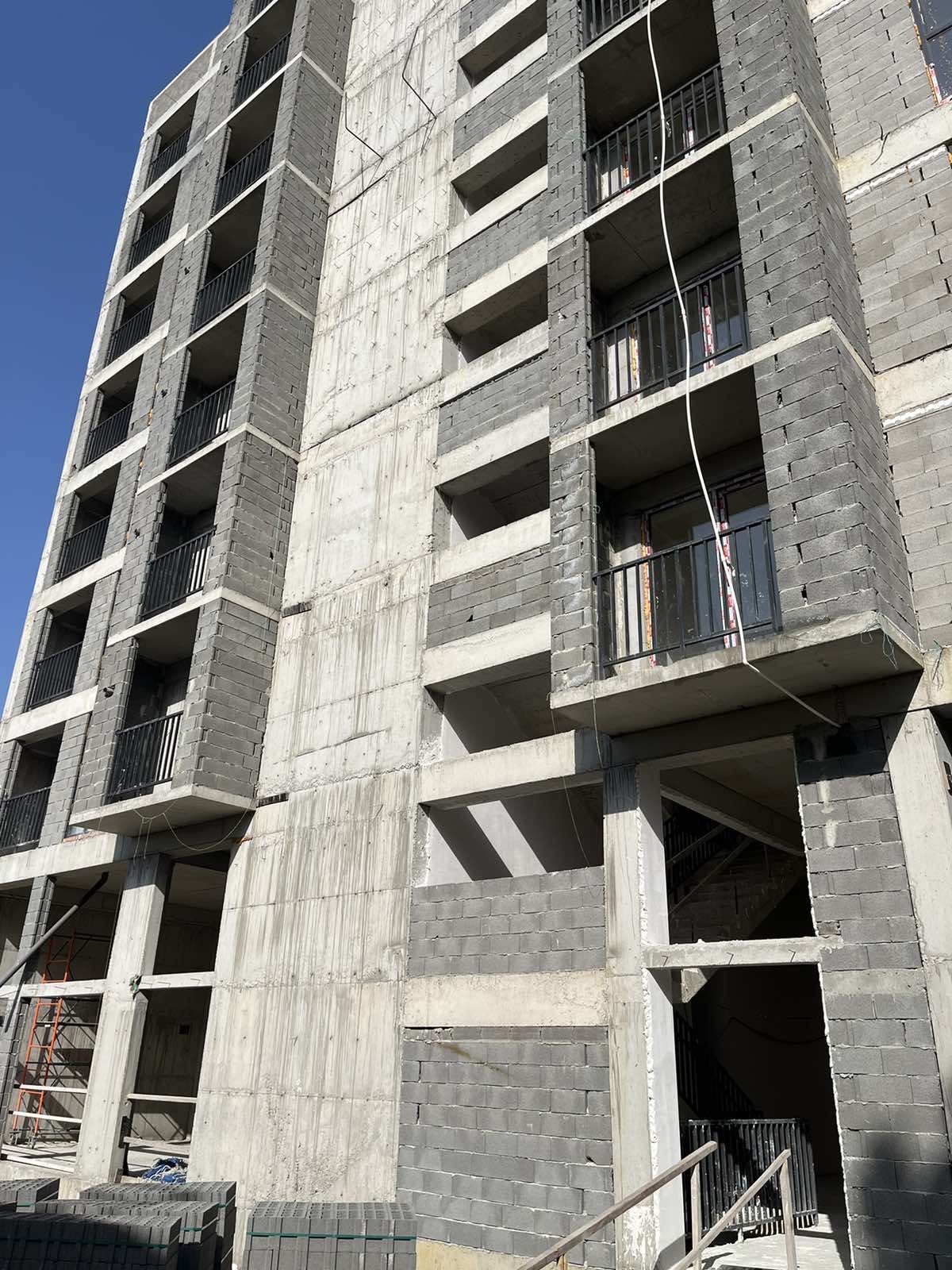

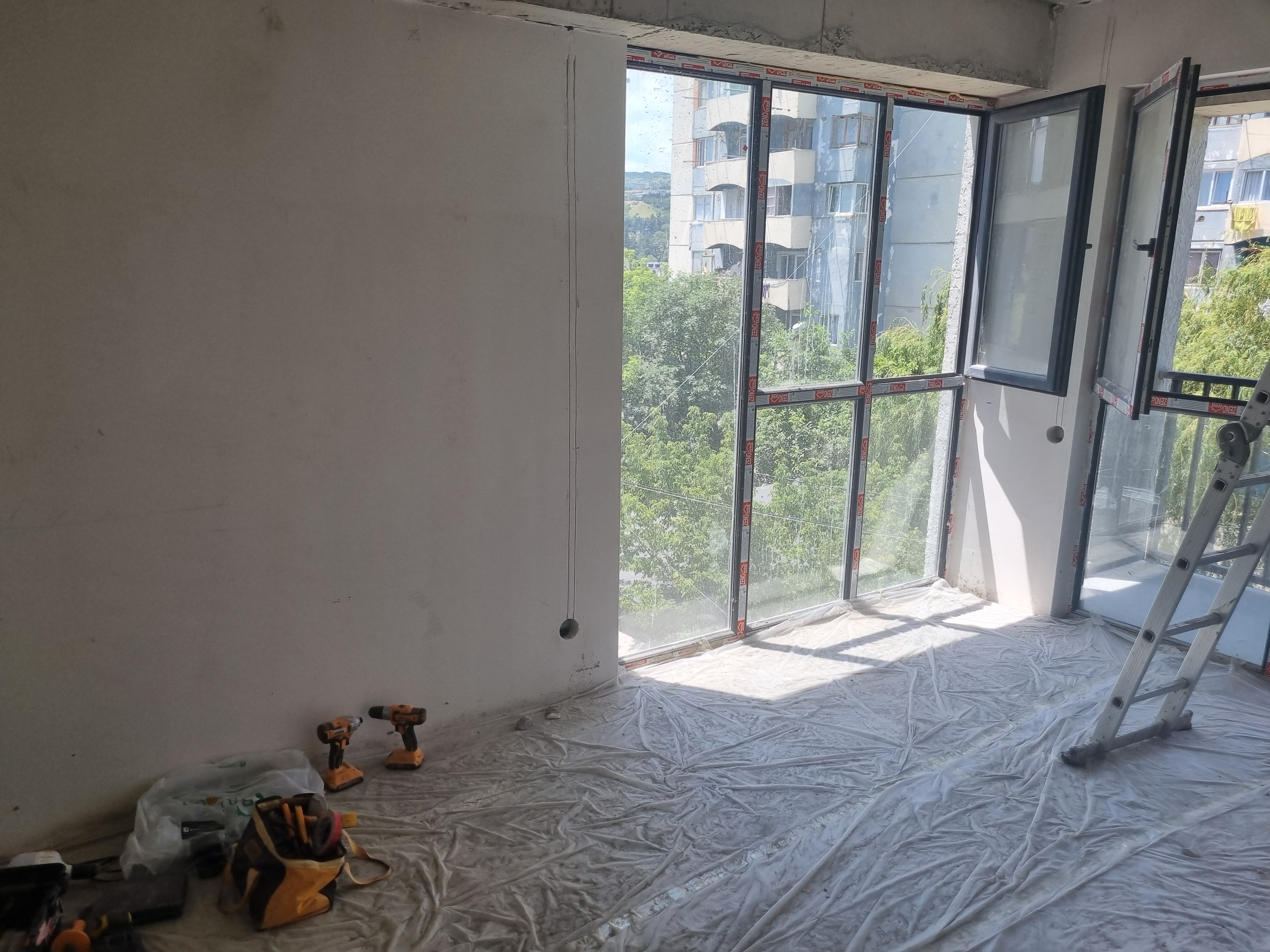

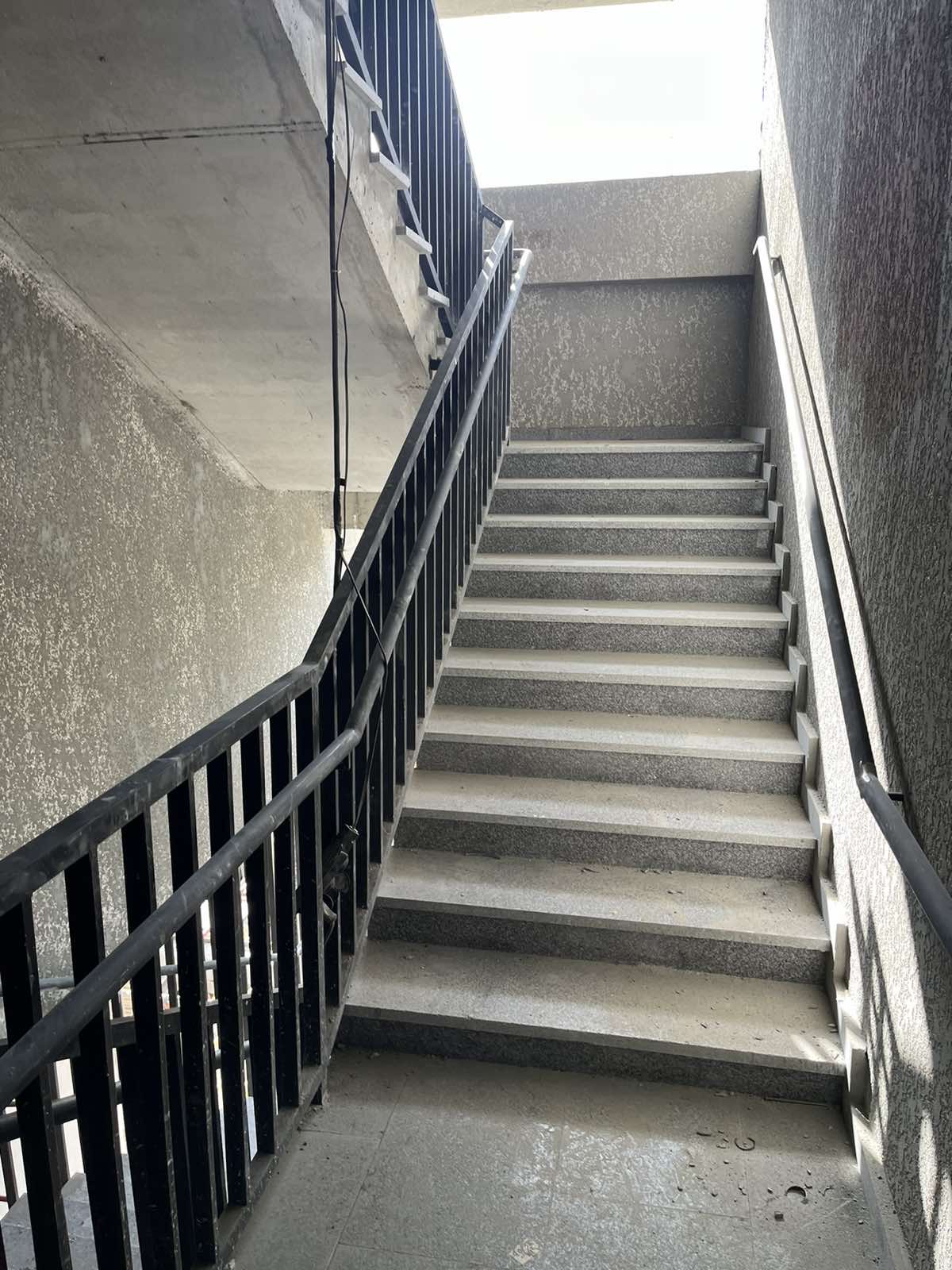

Internal work

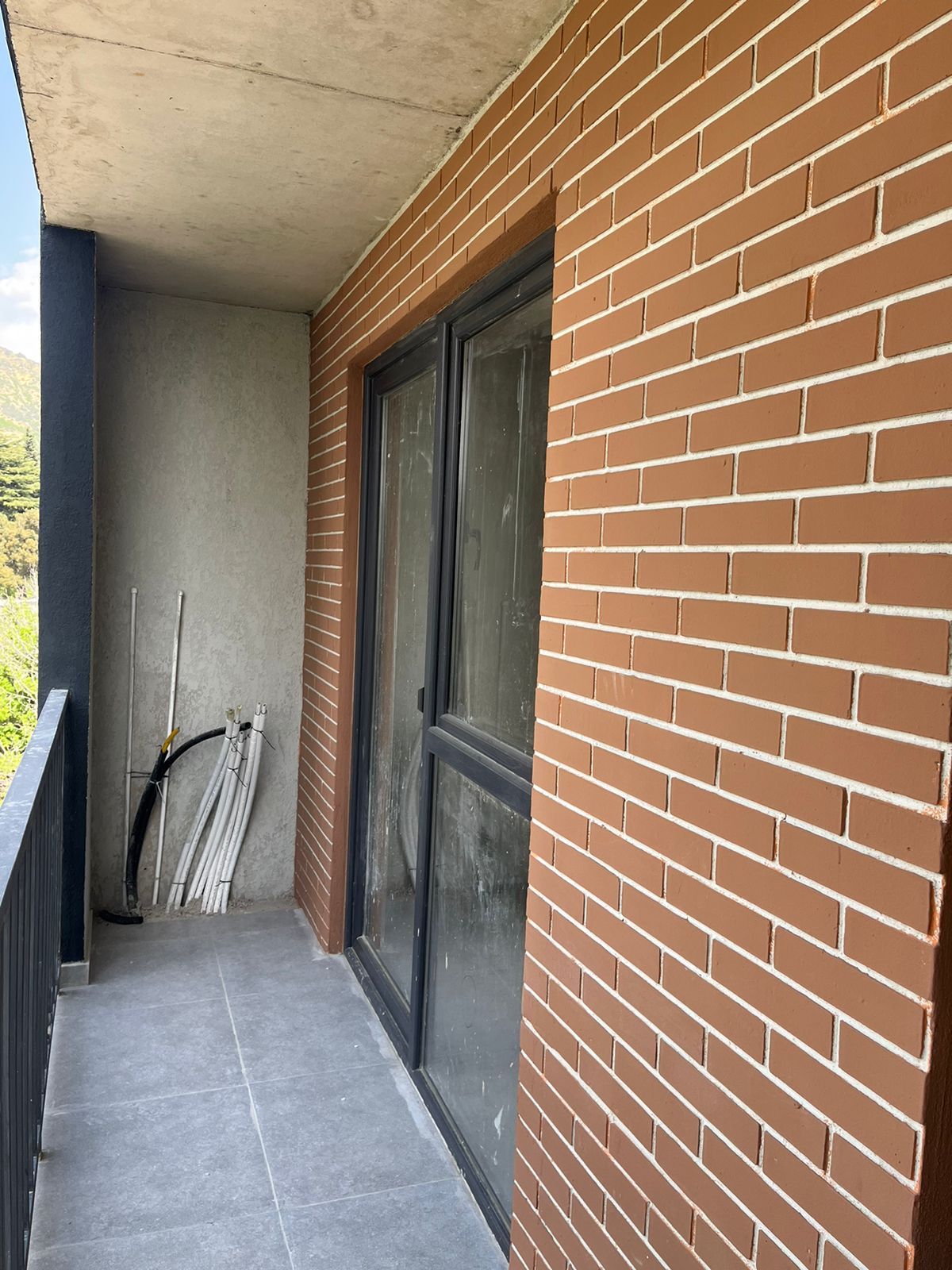

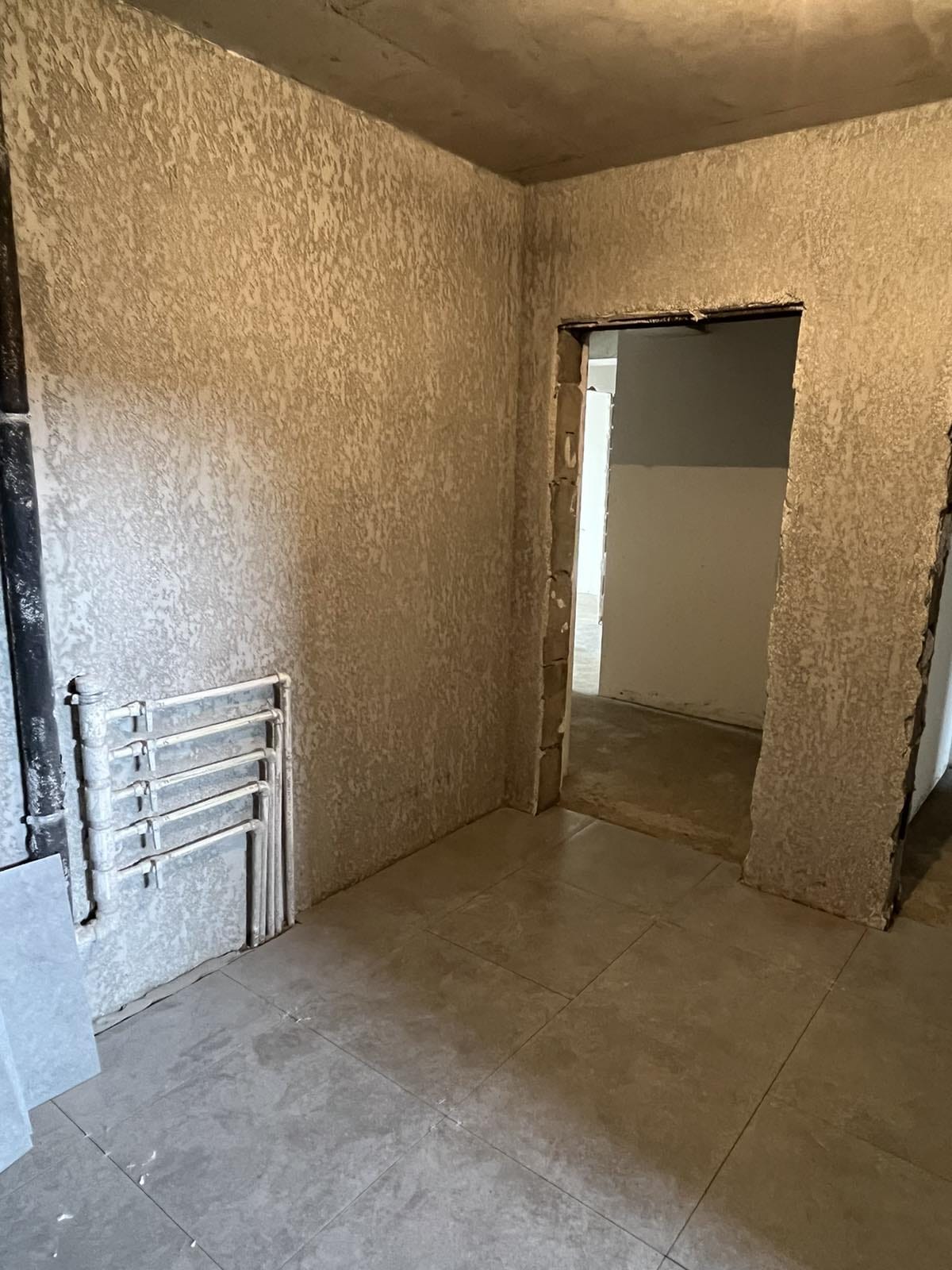

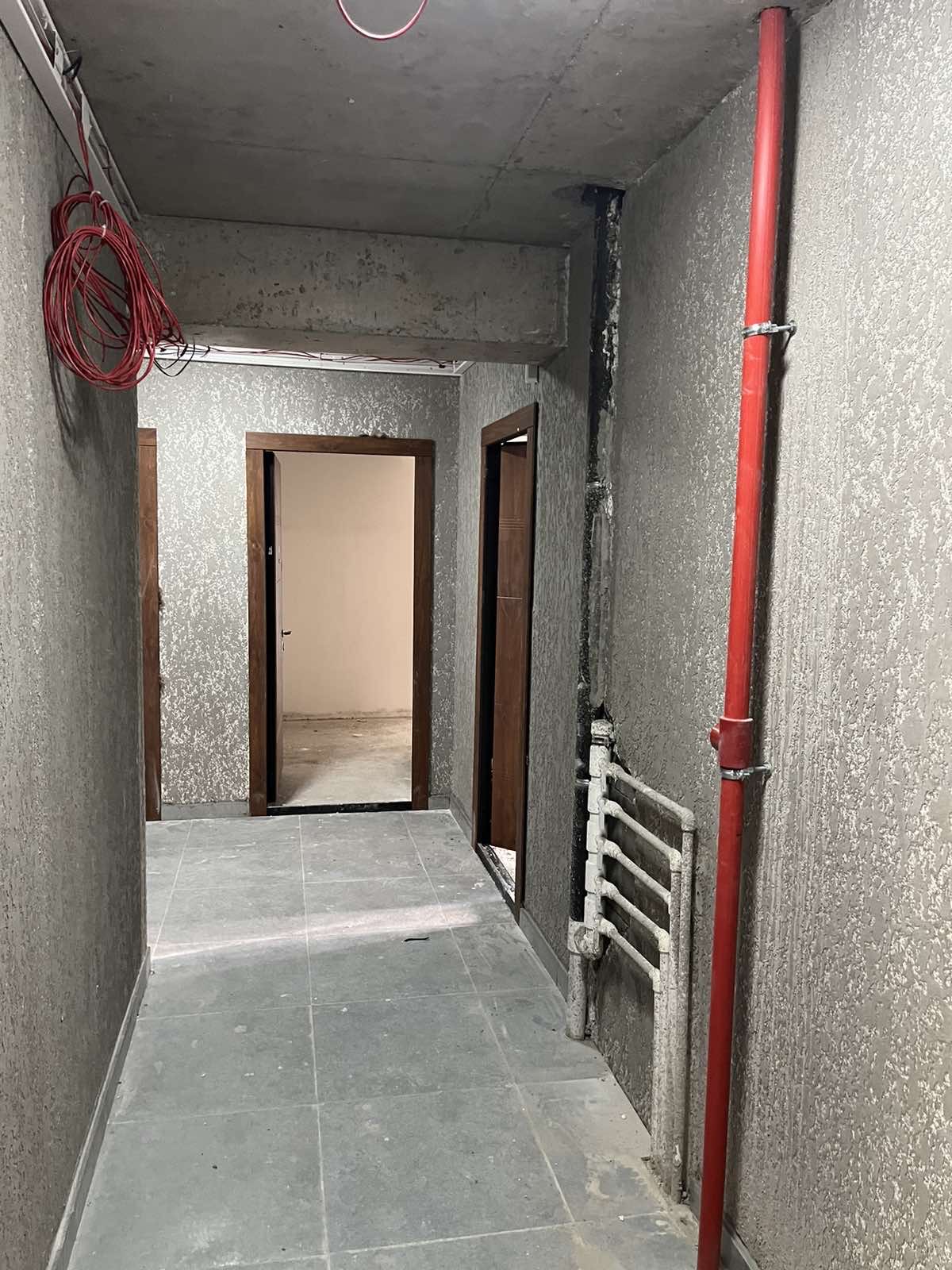

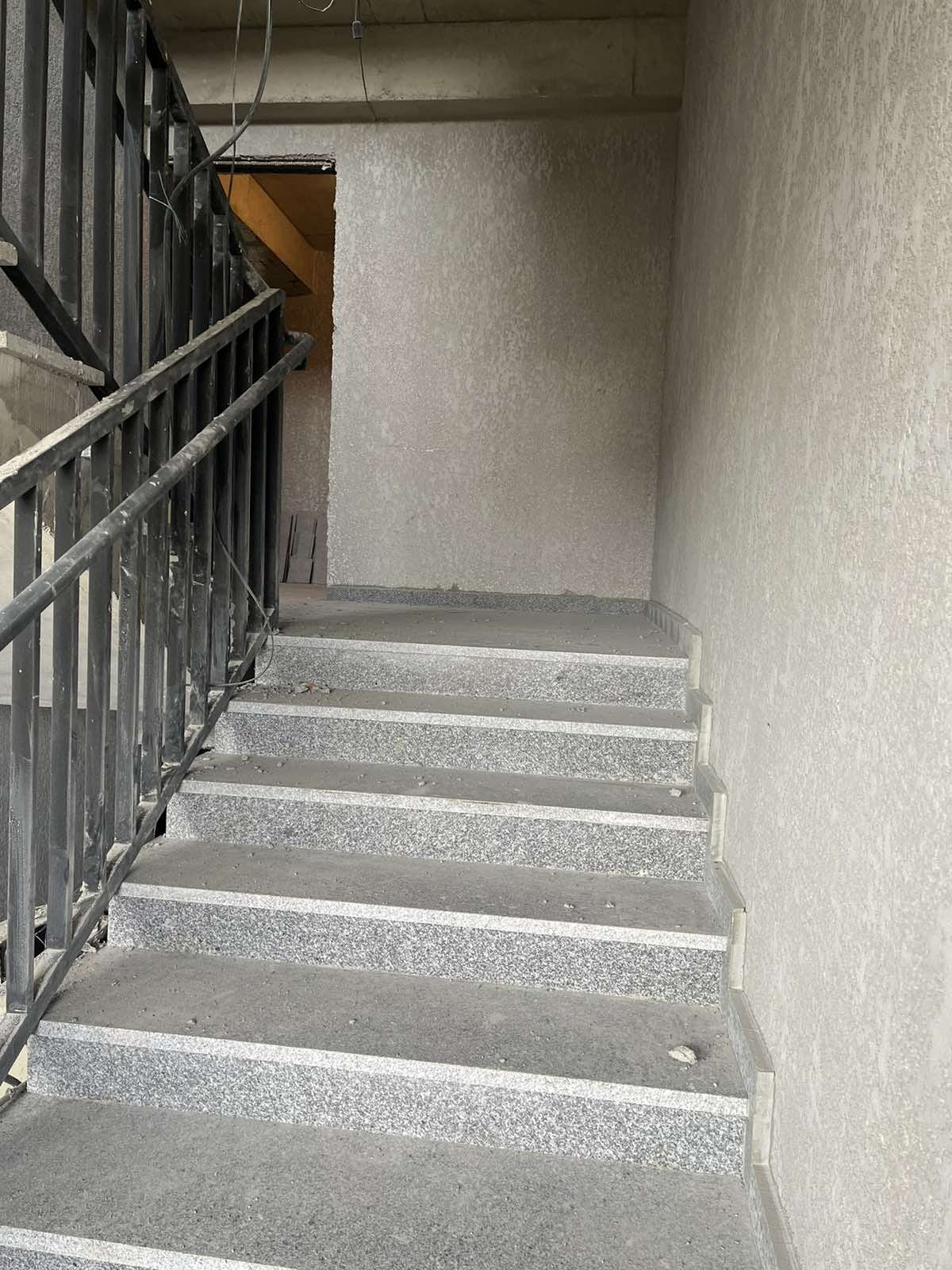

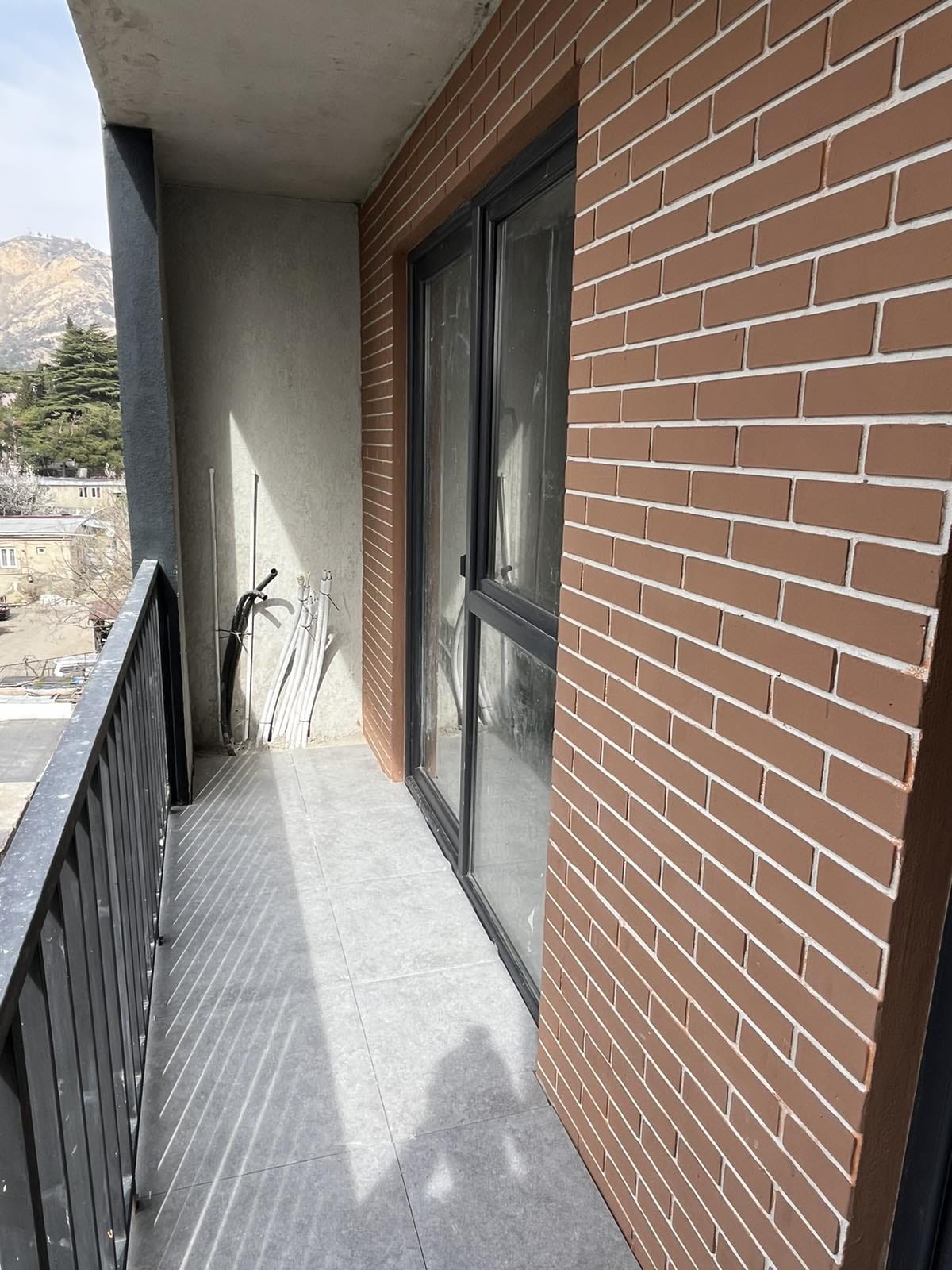

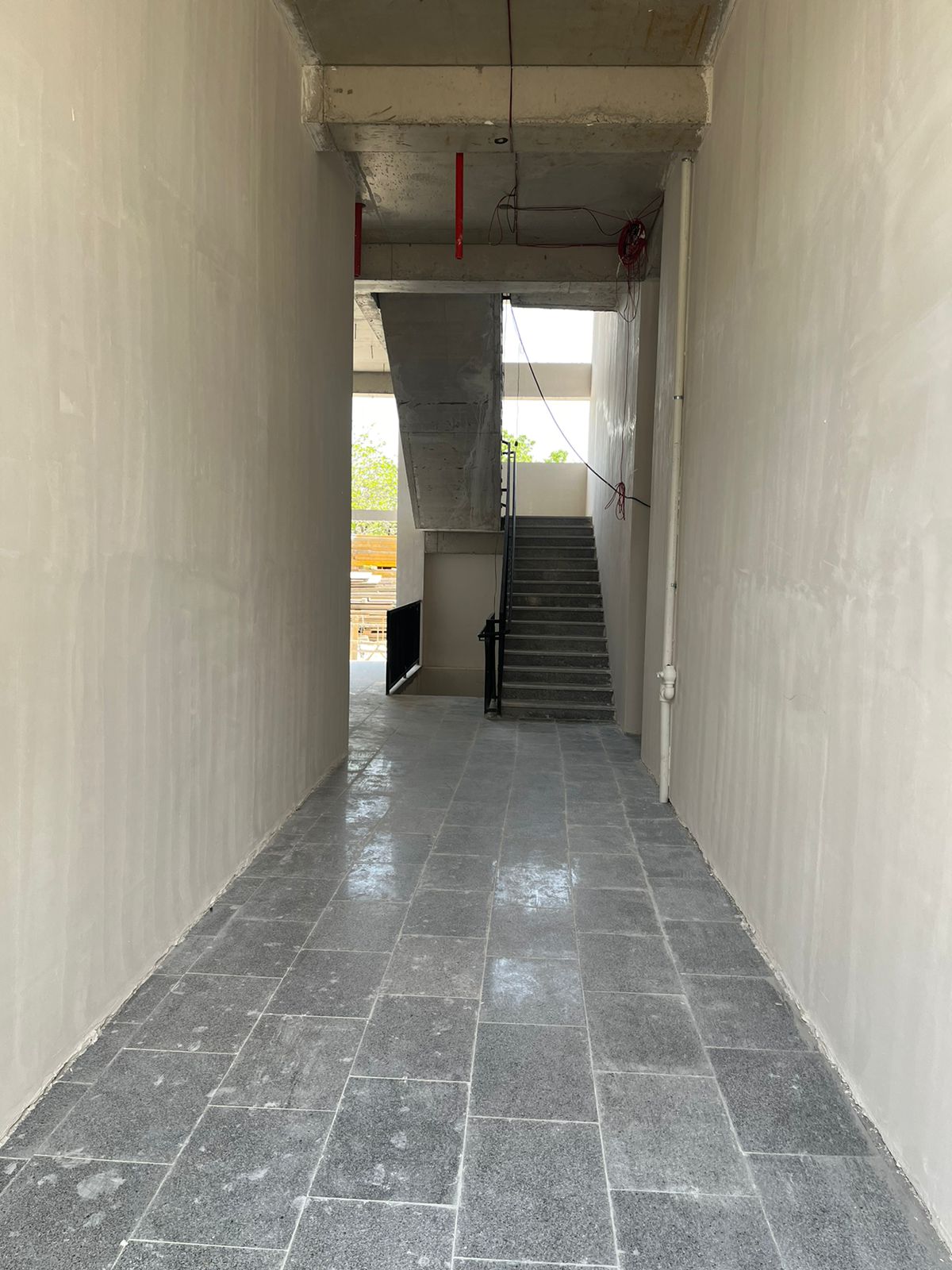

In block A - the installation of railings, and doors, and the work of removing the internal partitions has been completed. Balconies and hallways are finished with ceramic granite;

In block B - in the apartments, the removal of internal partitions, and the installation of railings on balconies and stairwells was completed;

In block C - the monolith work is completed and the internal partitions are in progress.

Internal work
timeline 9 timeline 9 timeline 9 timeline 9 timeline 9 timeline 9 timeline 9
10
22 April -2024

Accommodation

In Avchala, the internal and external works have been completed, the tenants who have been covered for the full cost of the apartment are starting the repair work.

Accommodation
timeline 10 timeline 10 timeline 10 timeline 10 timeline 10 timeline 10 timeline 10

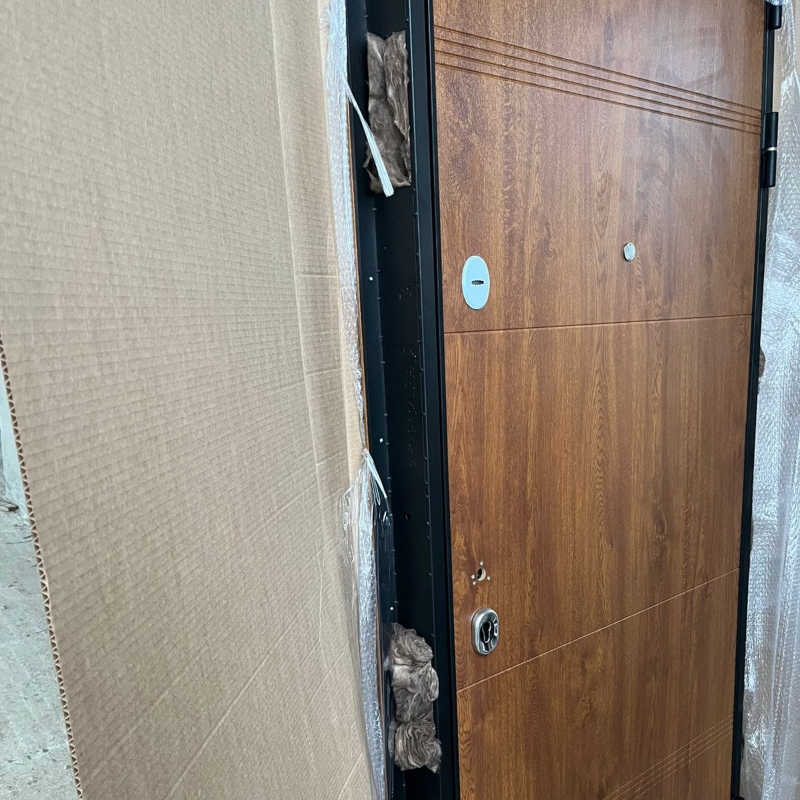

11
03 April -2024

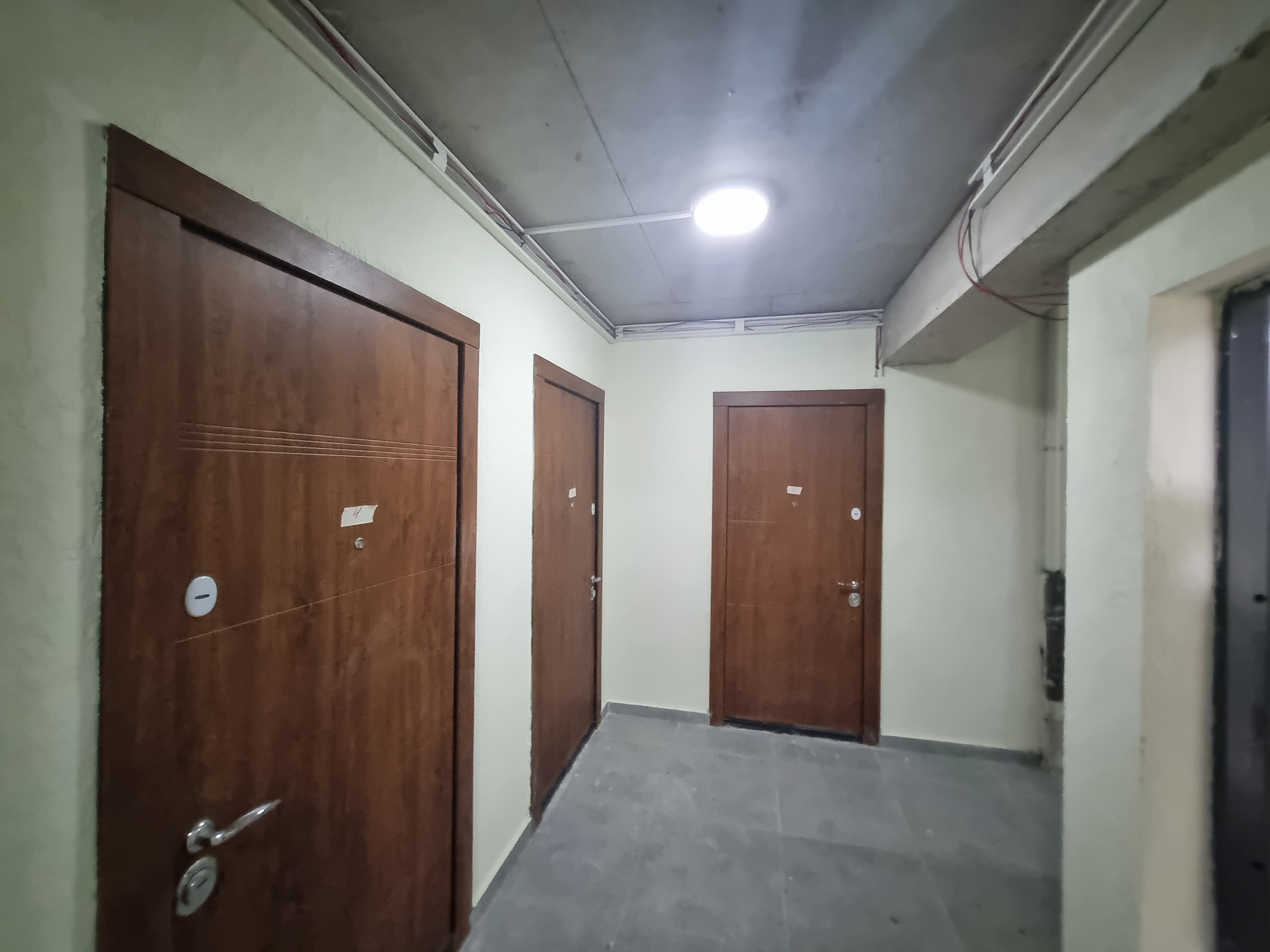

Installation of doors

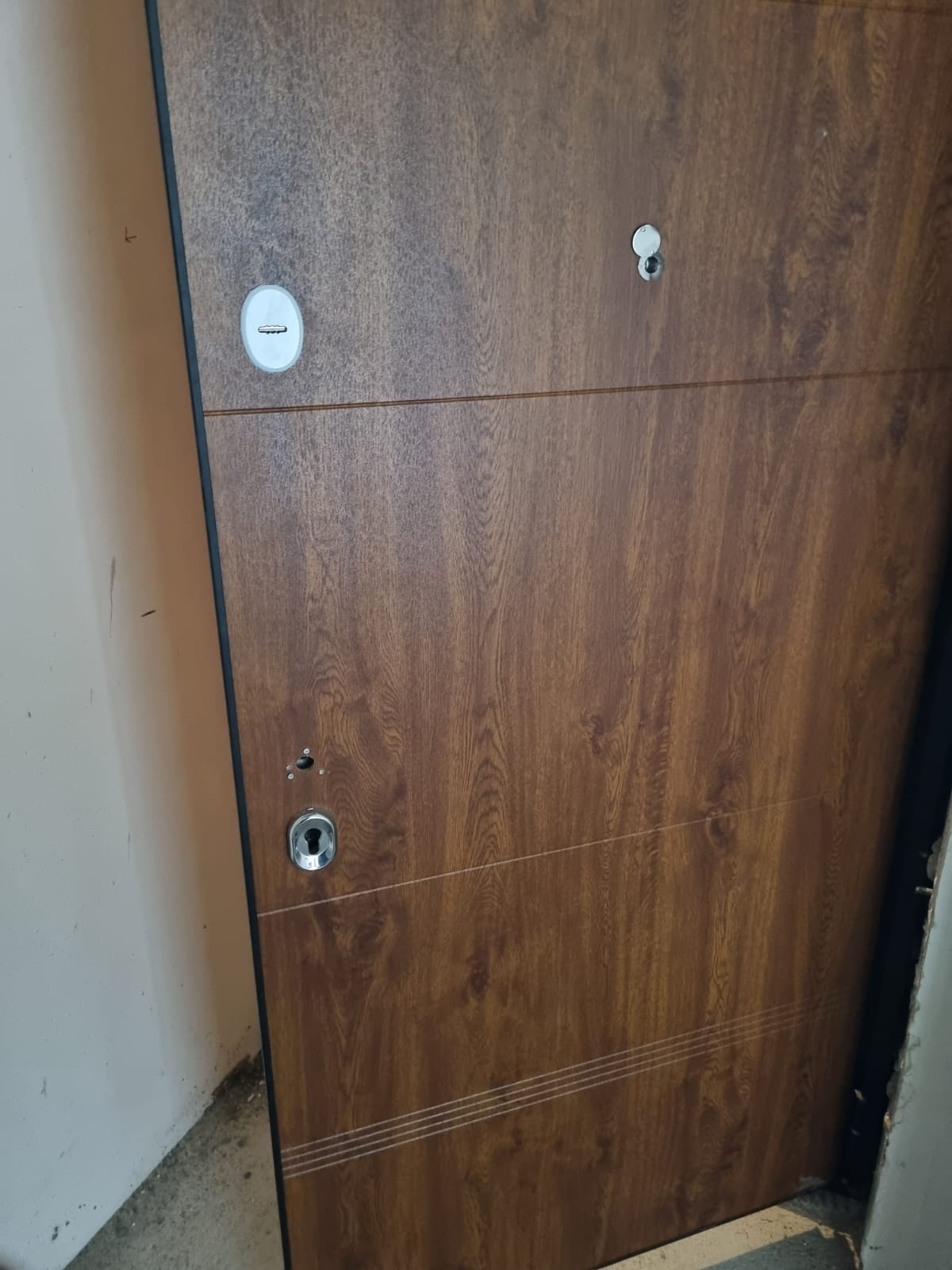

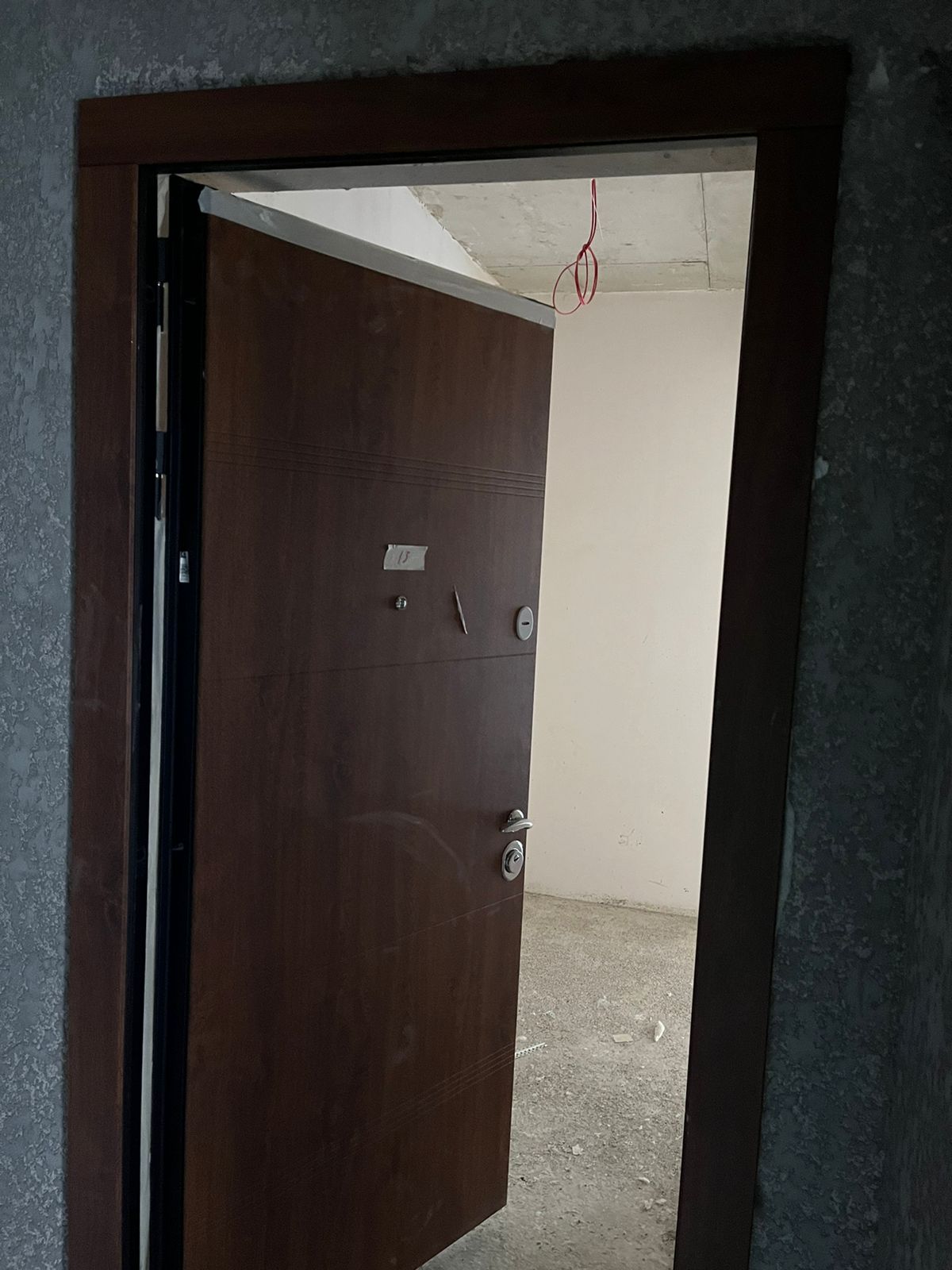

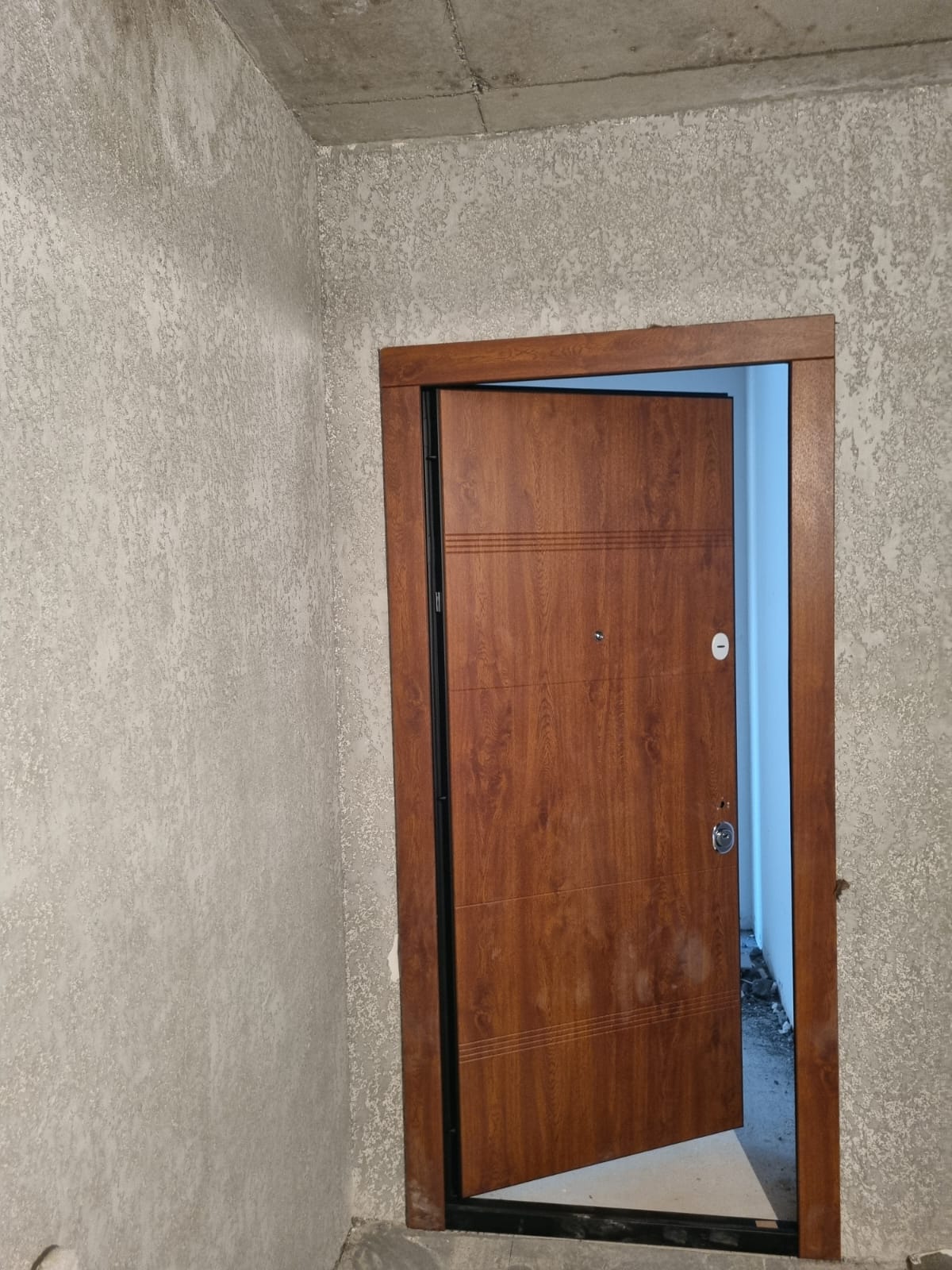

In Avchala, the iron doors to the apartments are being installed, as well as the hallways and balconies. At the same time, facade painting works.

Installation of doors
timeline 11 timeline 11 timeline 11

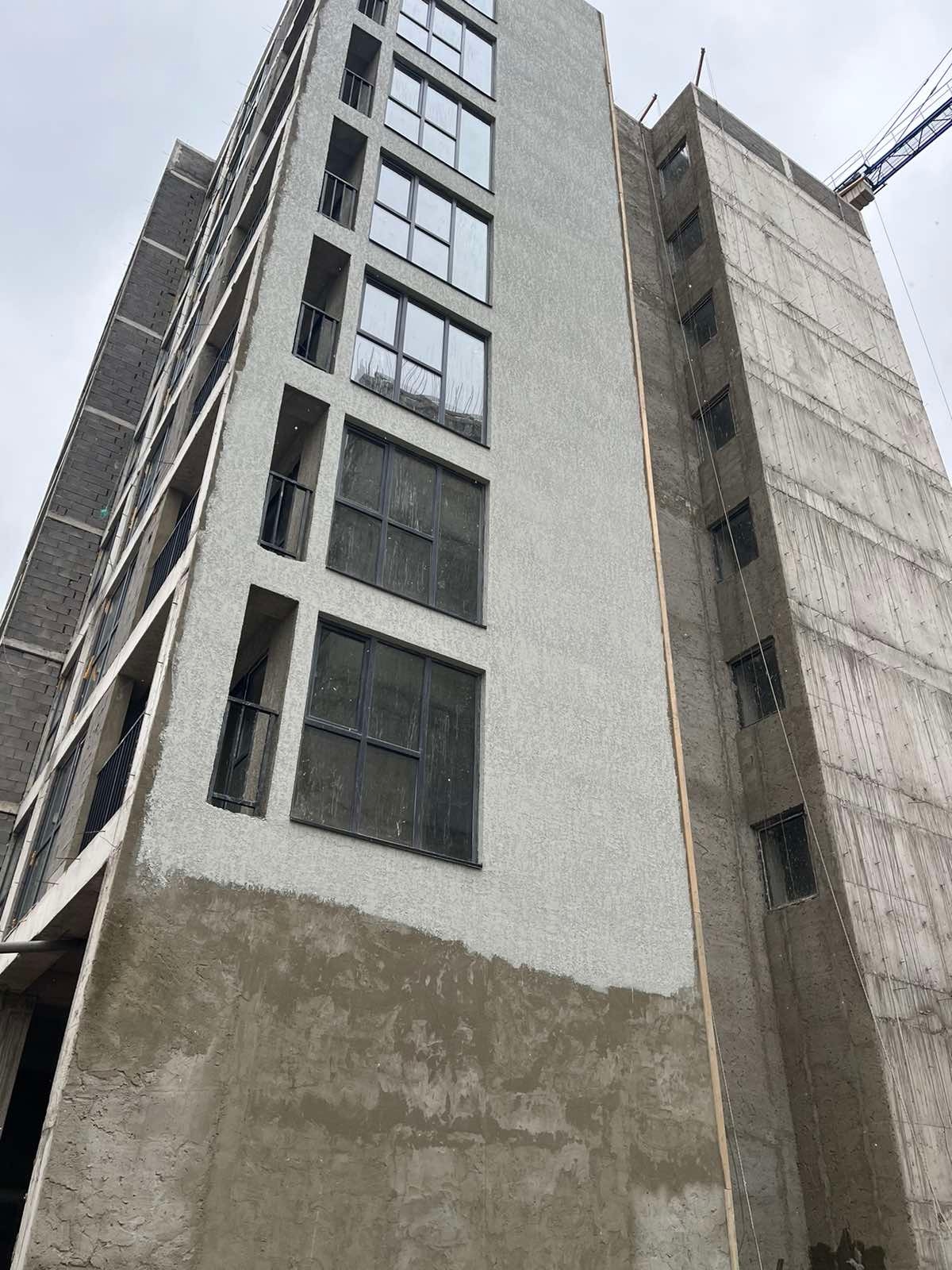

12
25 January -2024

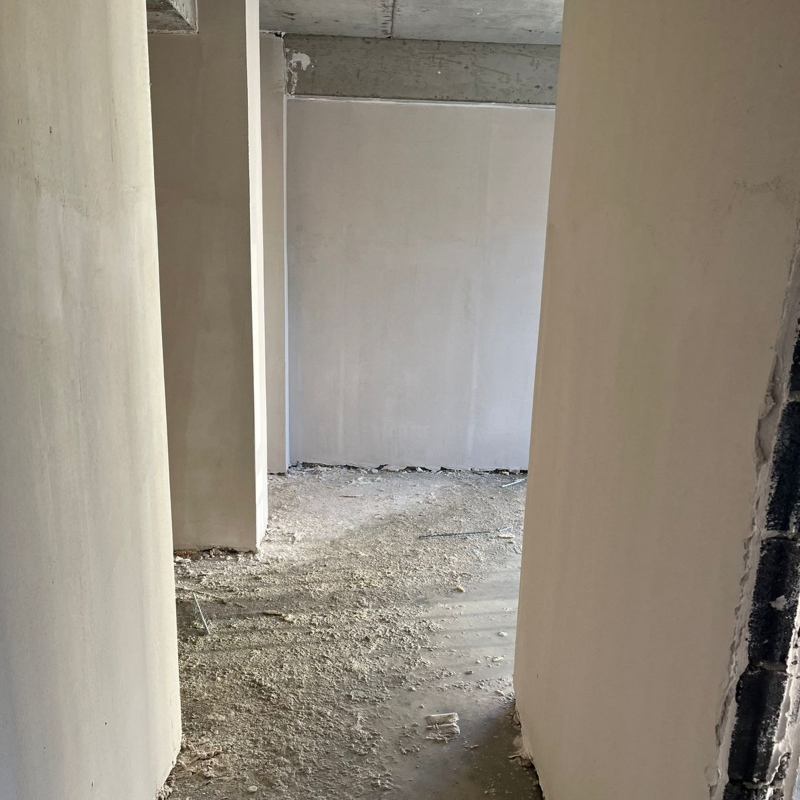

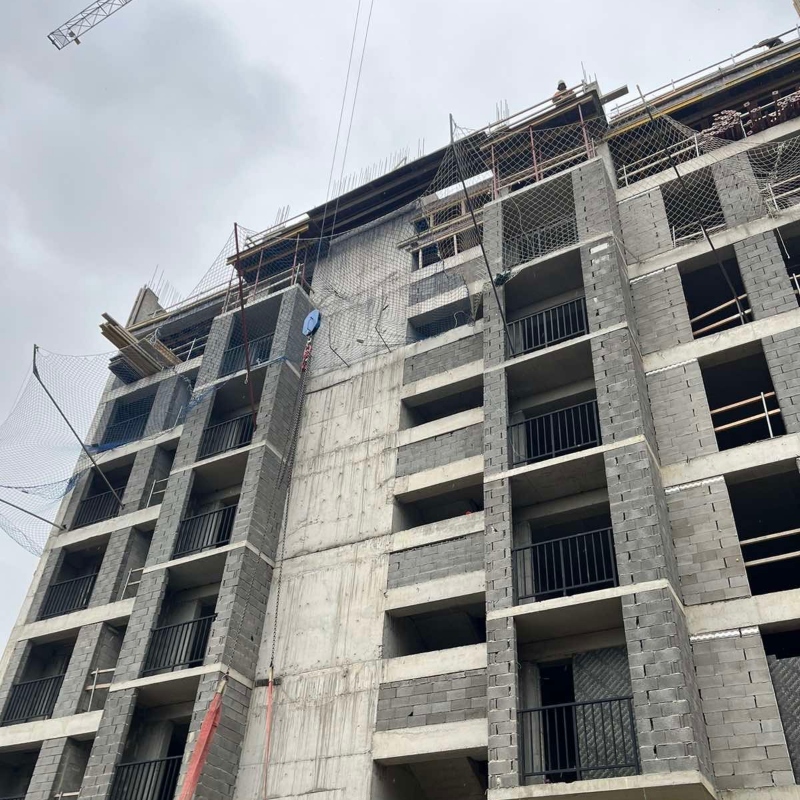

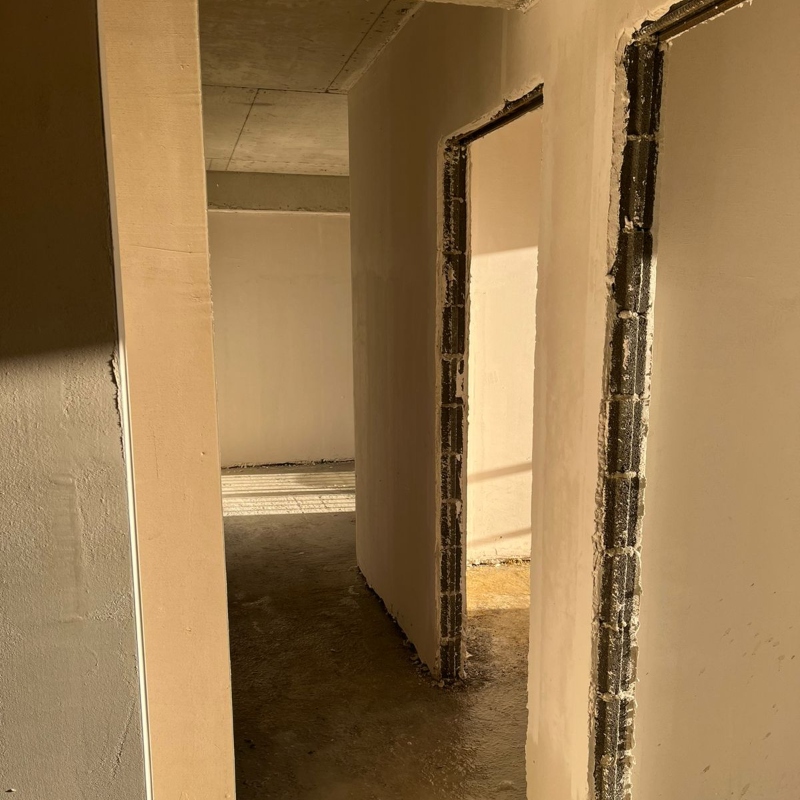

Internal work

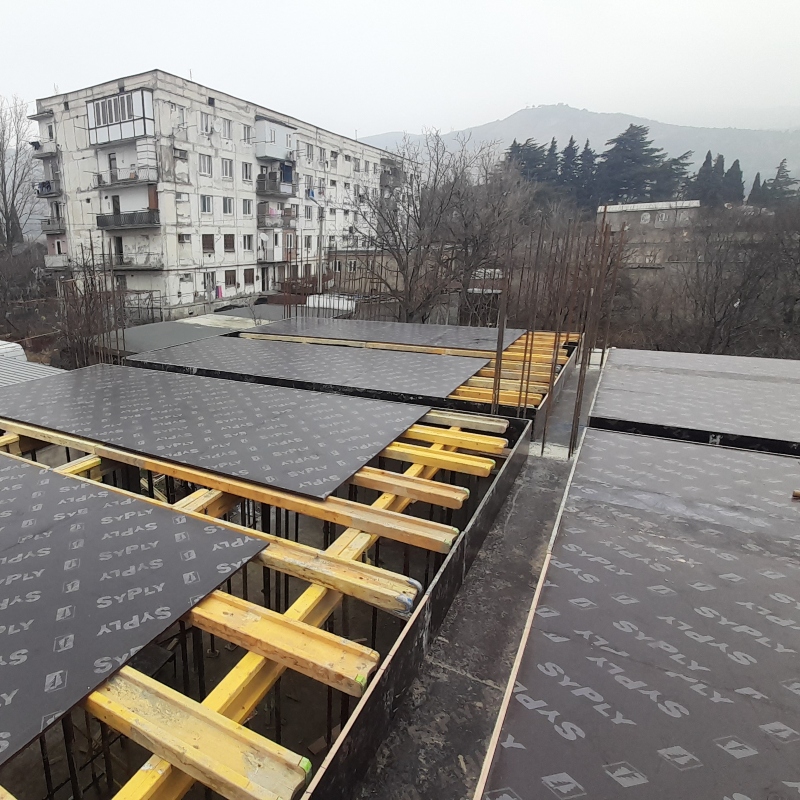

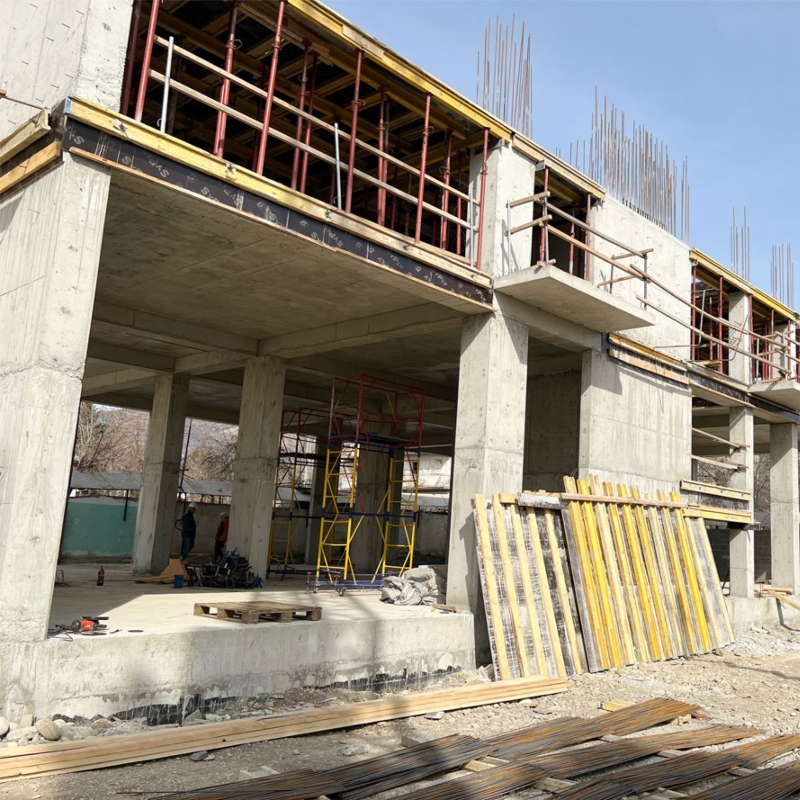

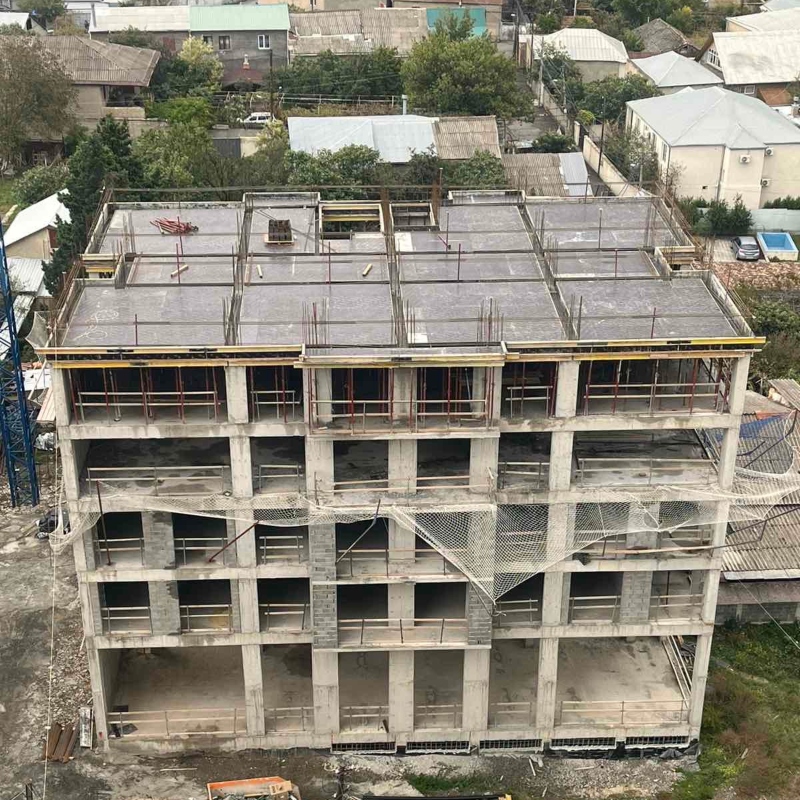

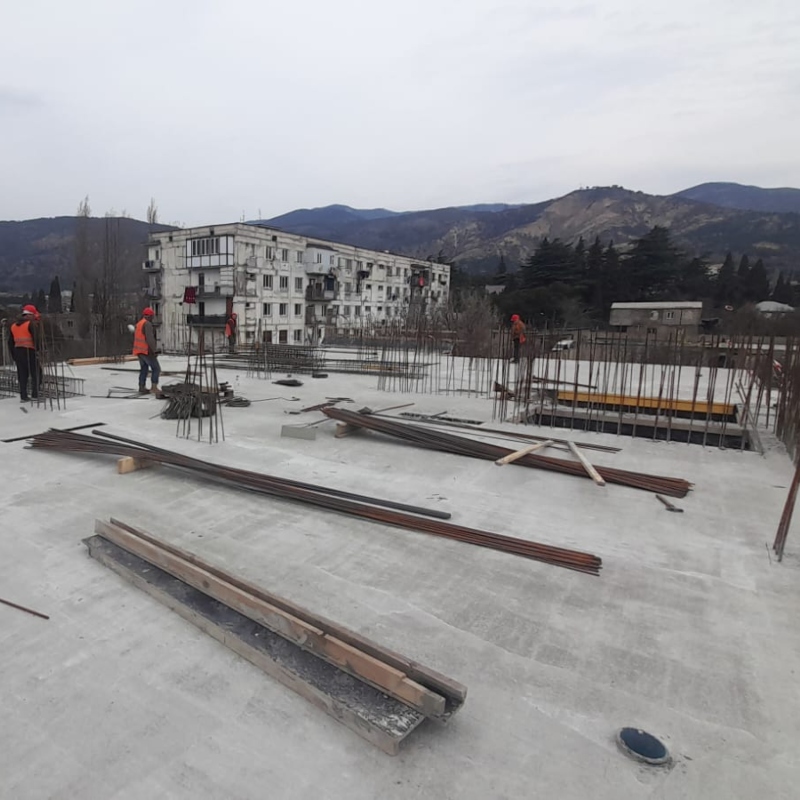

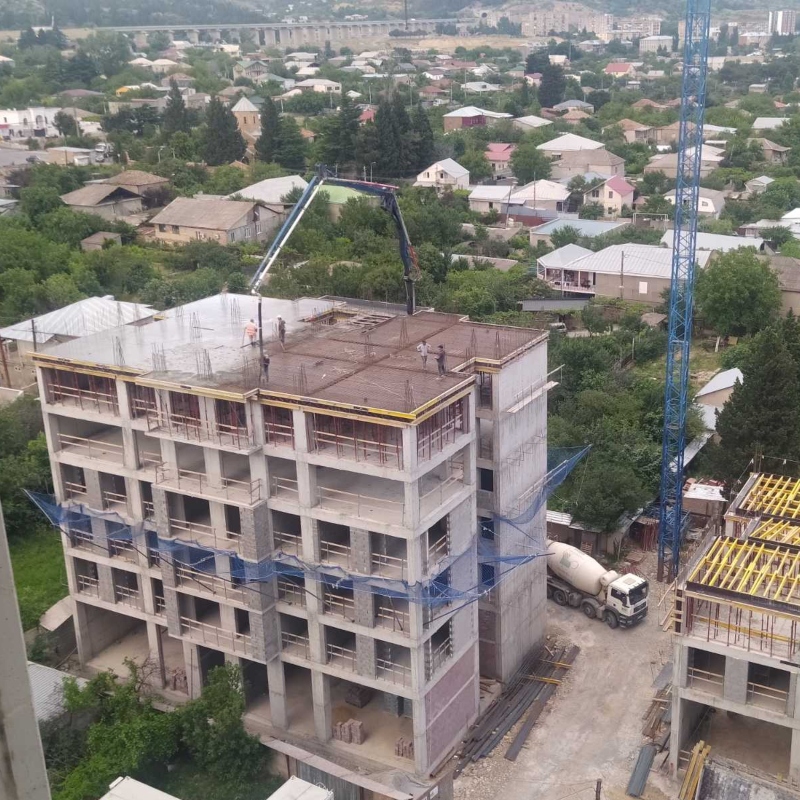

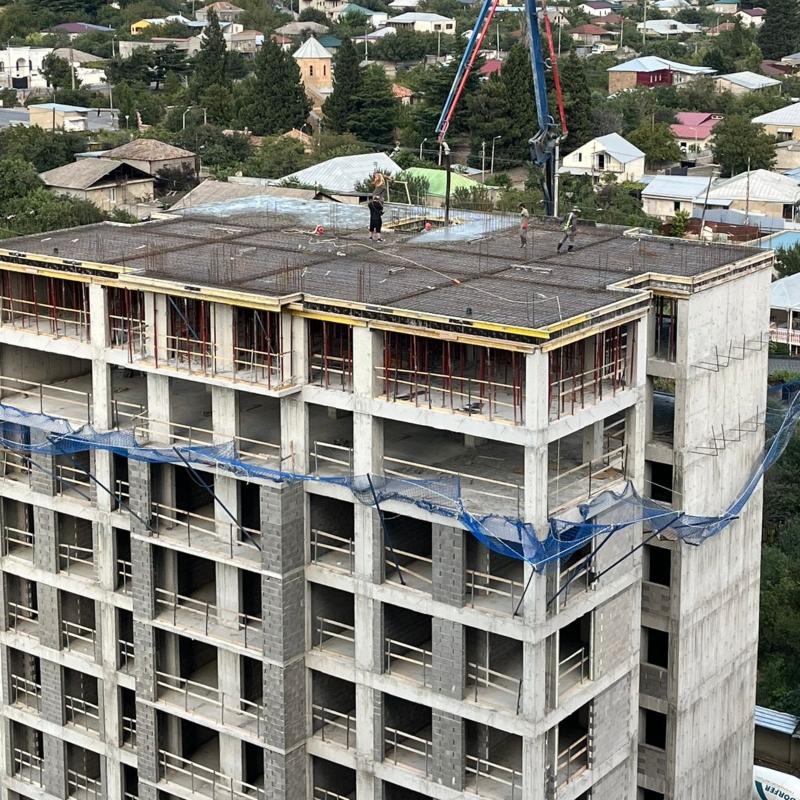

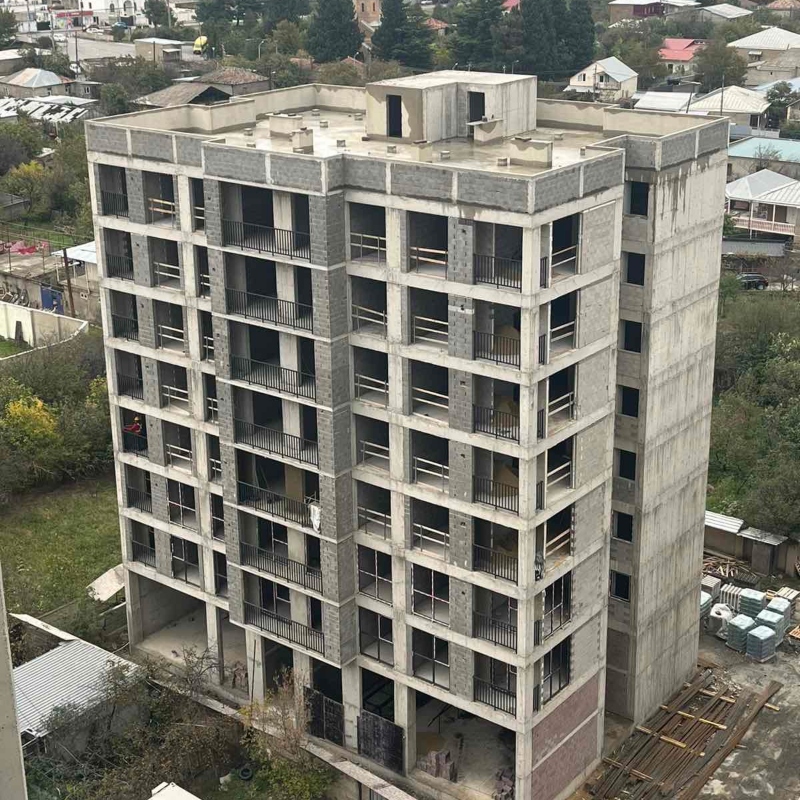

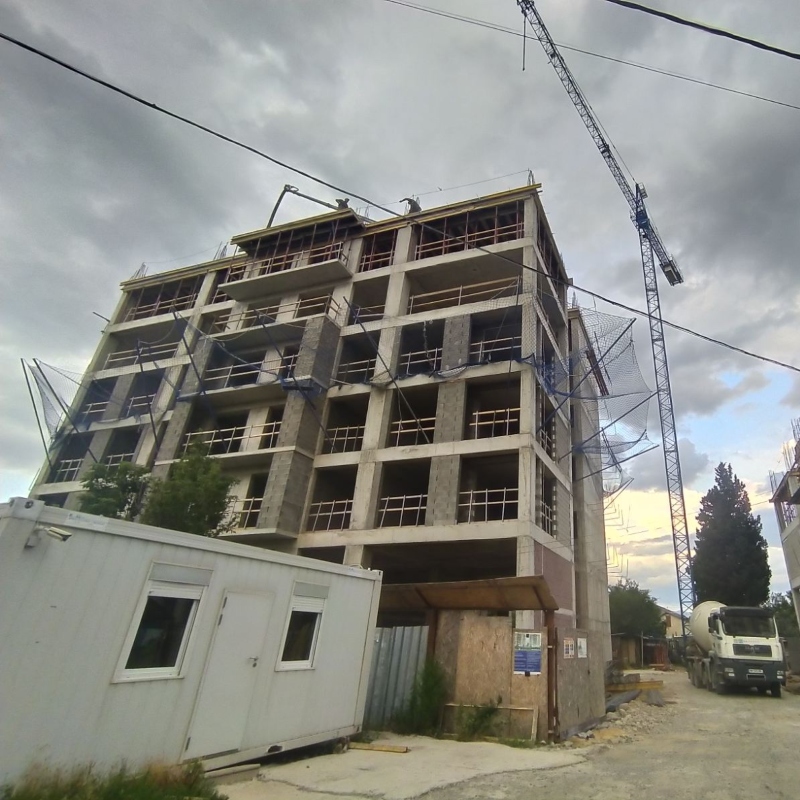

In block A - the installation of doors and windows and the railings of the entrance stairs have been completed. Plastering works of the facade are in progress. In block B - the slab of the eighth floor is being poured. The work of removing the internal partitions including the sixth floor has been completed. In Block C - the slab of the fourth floor is being laid.

Internal work
timeline 12 timeline 12 timeline 12

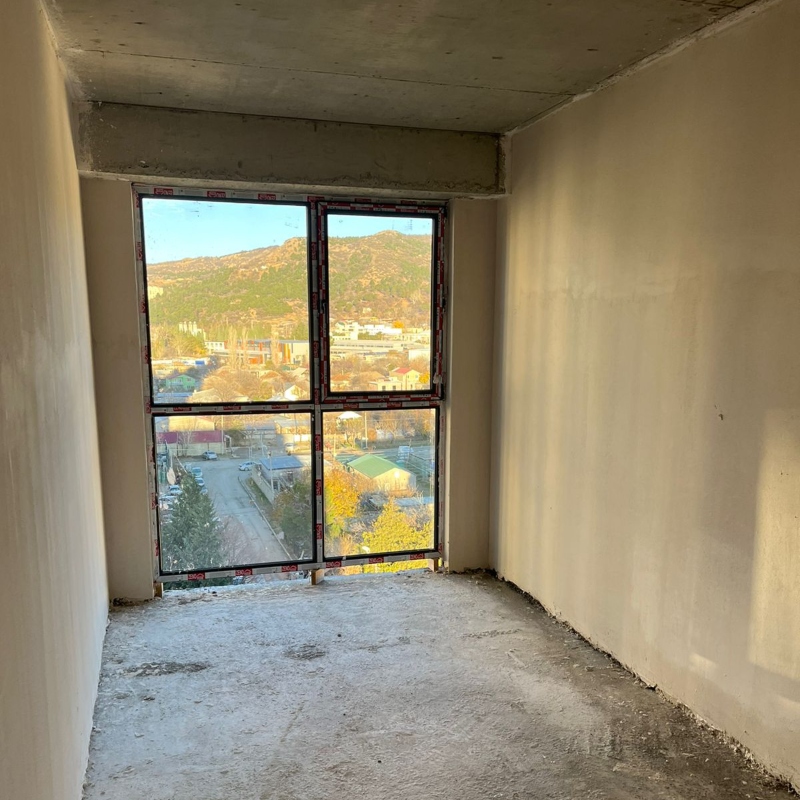

13
14 December -2023

Internal plastering

In Avchala block A, internal plastering works are underway. The entrance iron doors for the apartments, which are made of stone, have also arrived.

Internal plastering
timeline 13 timeline 13 timeline 13

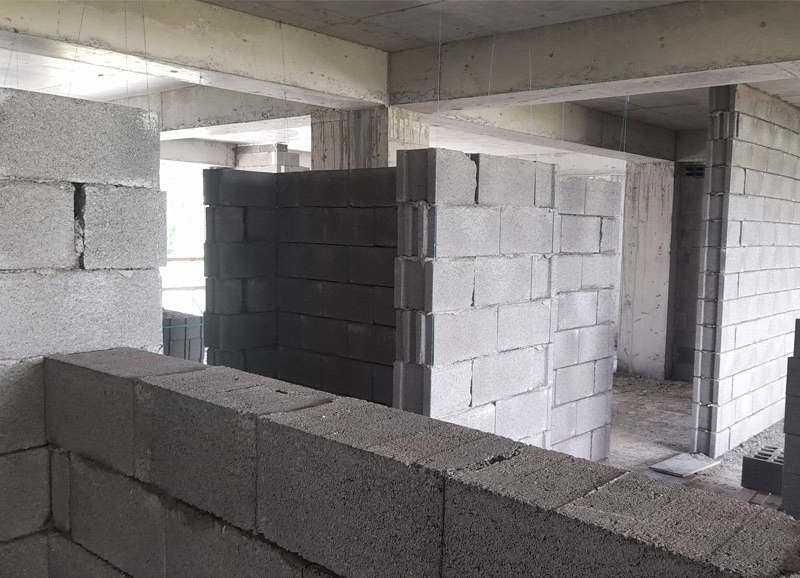

14
29 October -2023

Overlapping

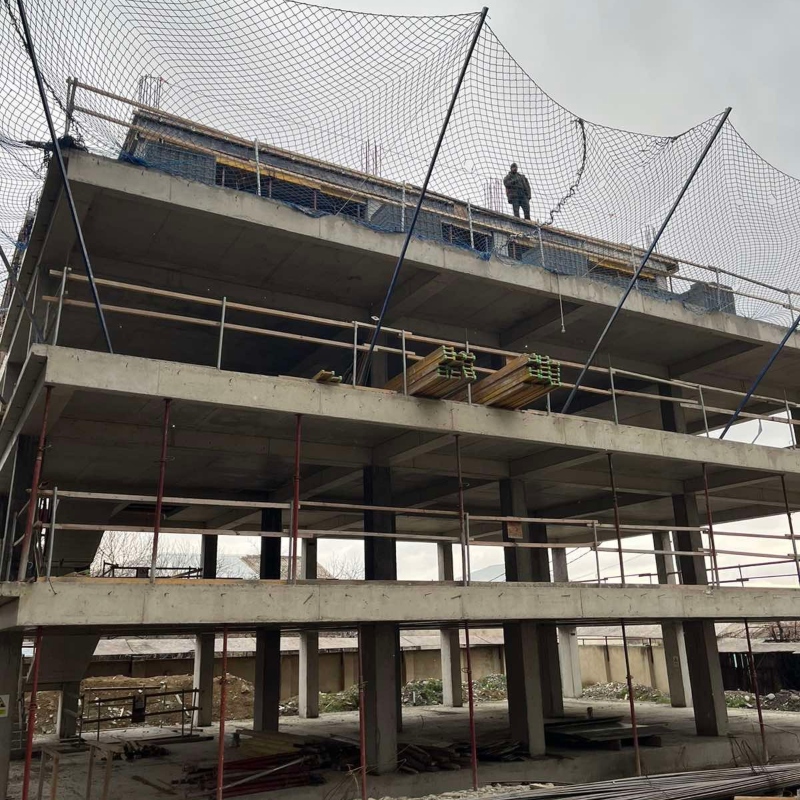

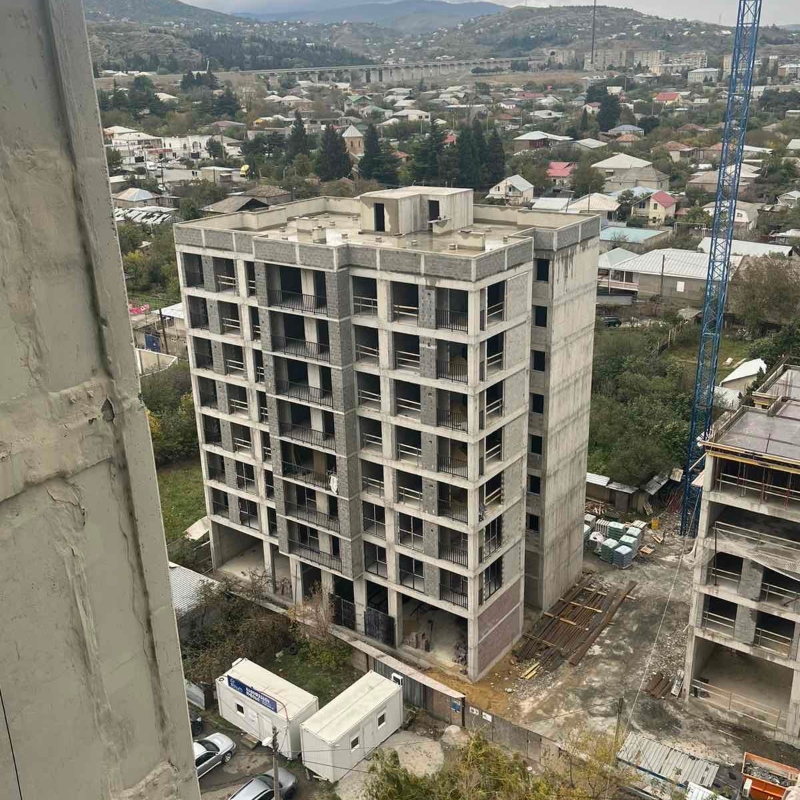

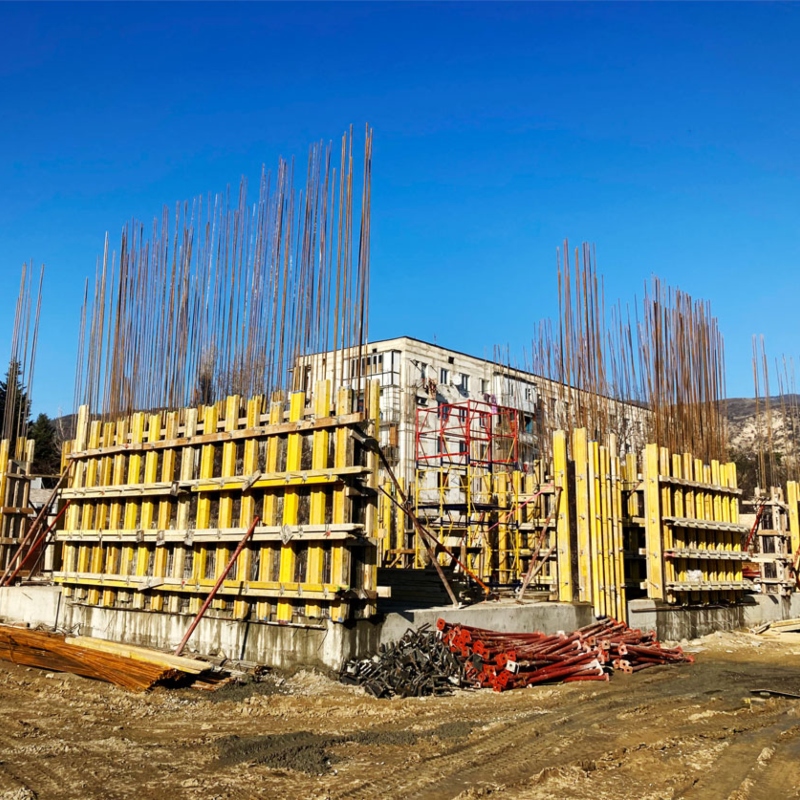

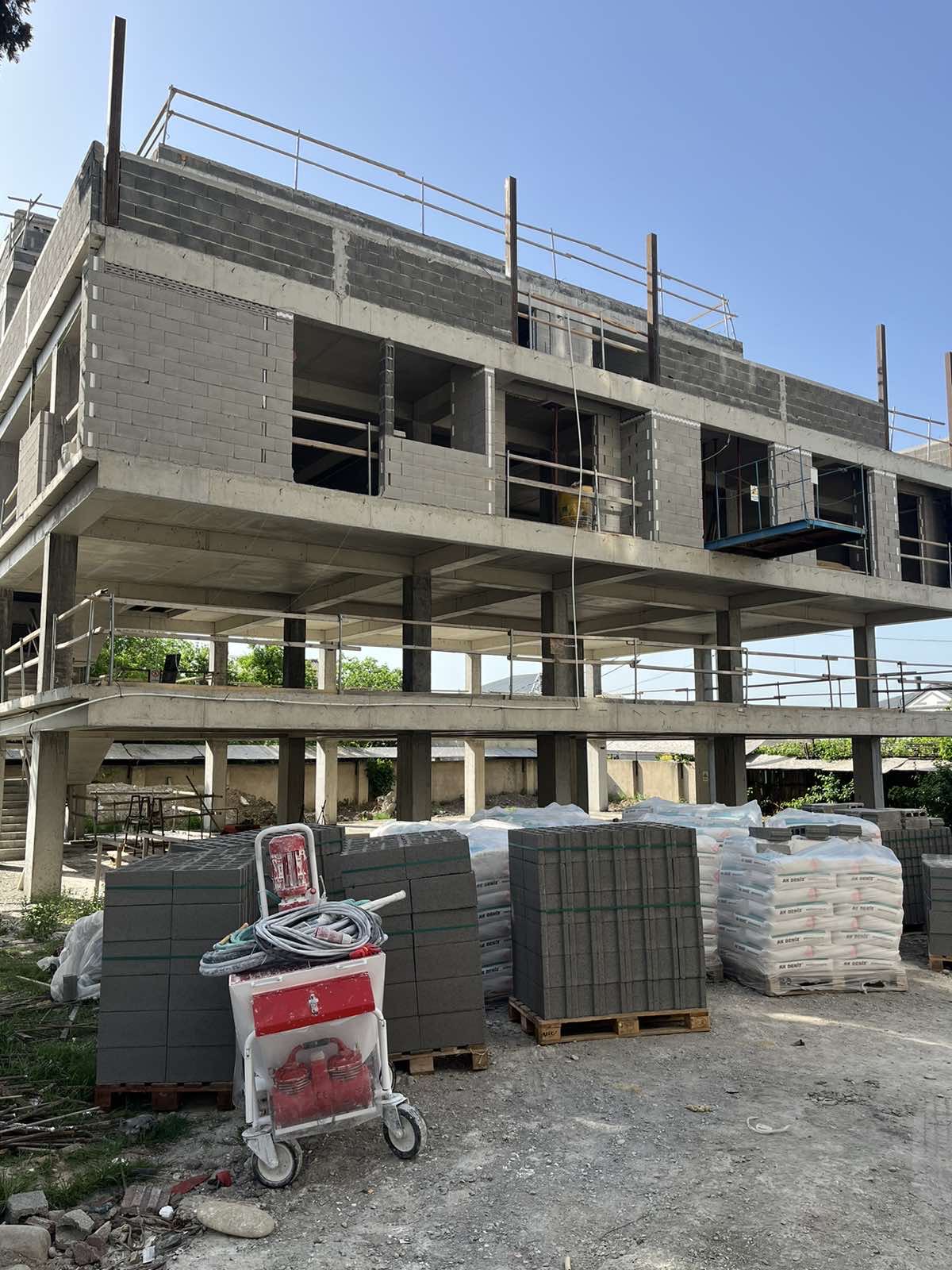

In the A sector, there are: Roofing works; Door-window insertion (including 3 floors); Installation of sewer pipes. In the B sector, there is - Placing the 5th-floor slab and removing internal partitions. In sector C, foundation pouring has been completed..

Overlapping
timeline 14

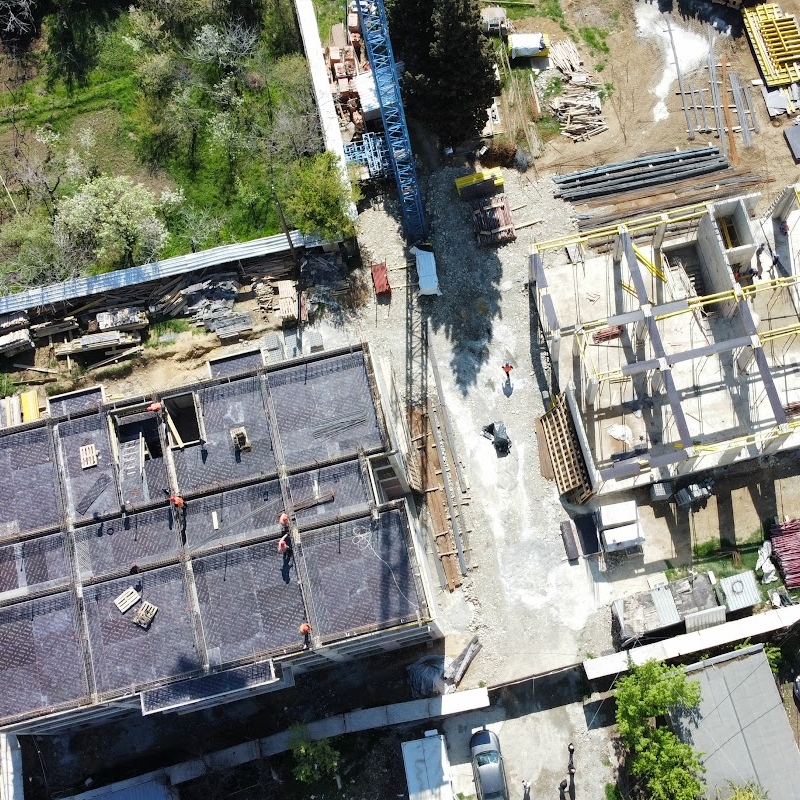

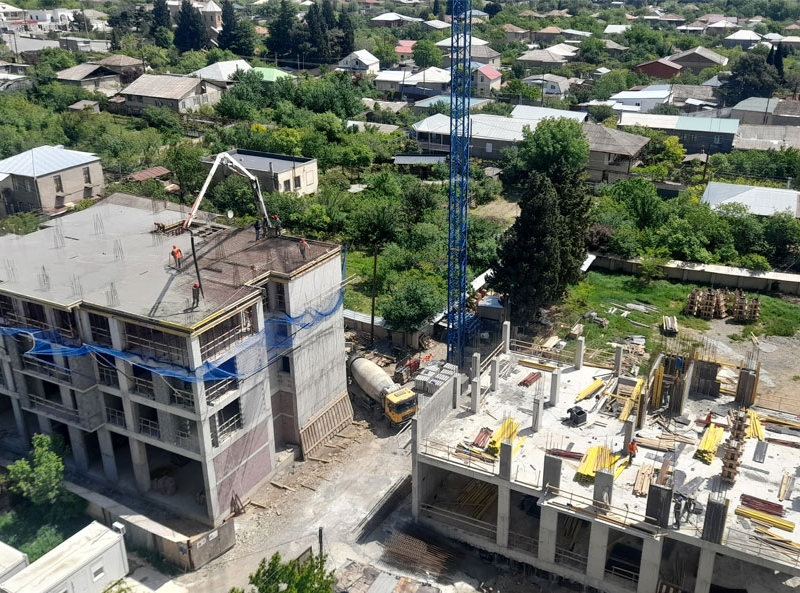

15
25 August -2023

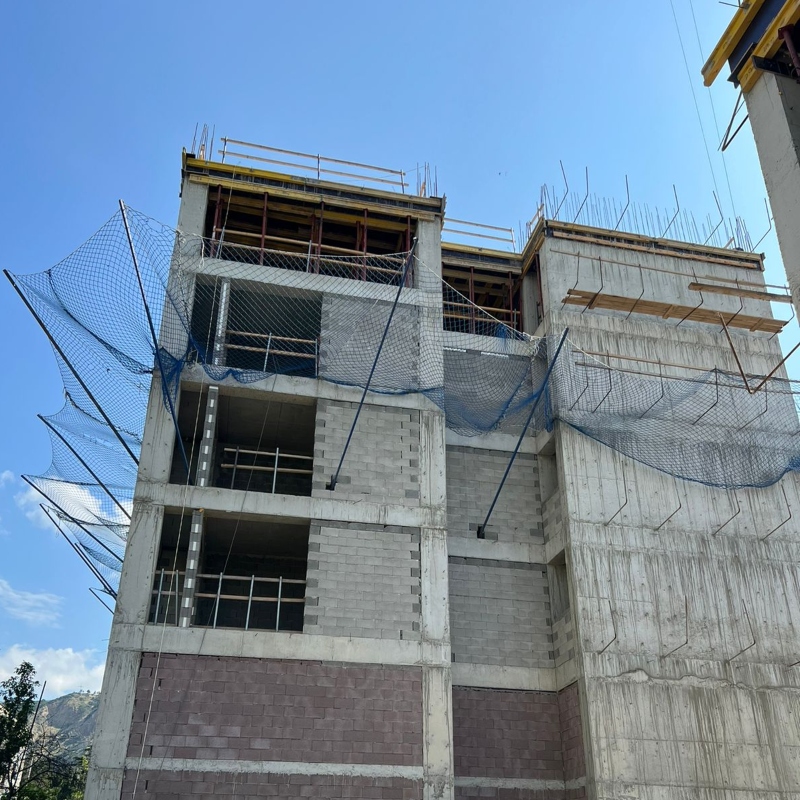

Monolith

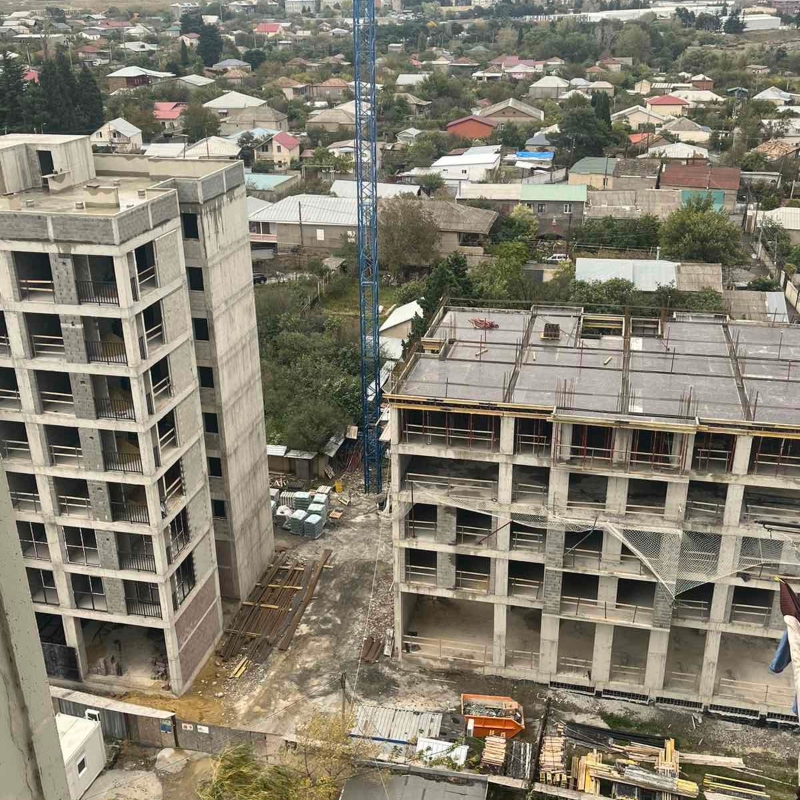

The construction of the monolith of block A in Avchala has been completed. In Block B, the floor of the 4th floor has been poured, and the partitions of the 2nd and 3rd floors have also been built.

Monolith
timeline 15 timeline 15

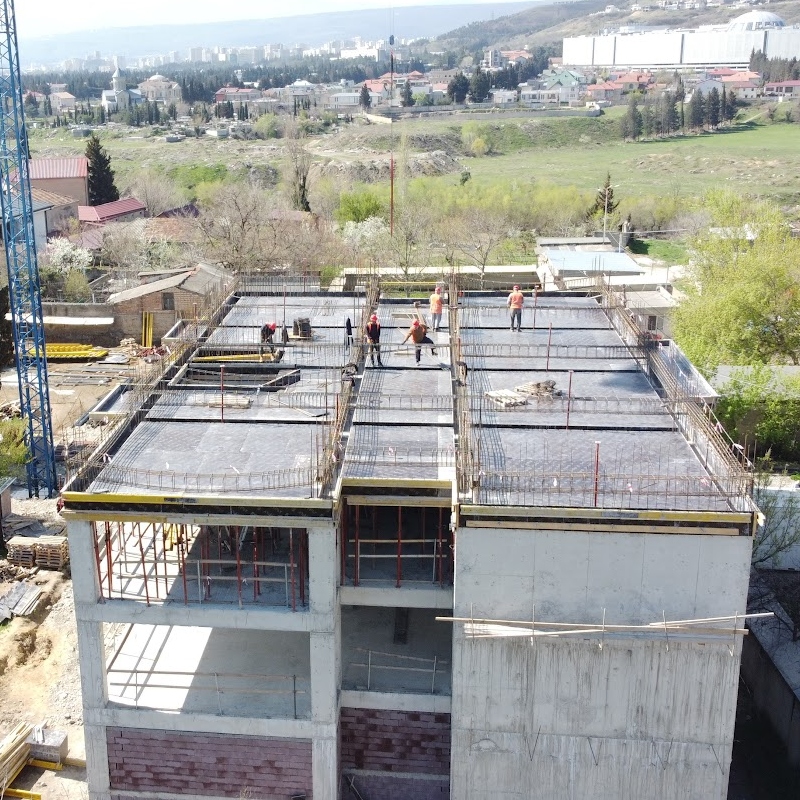

16
29 June -2023

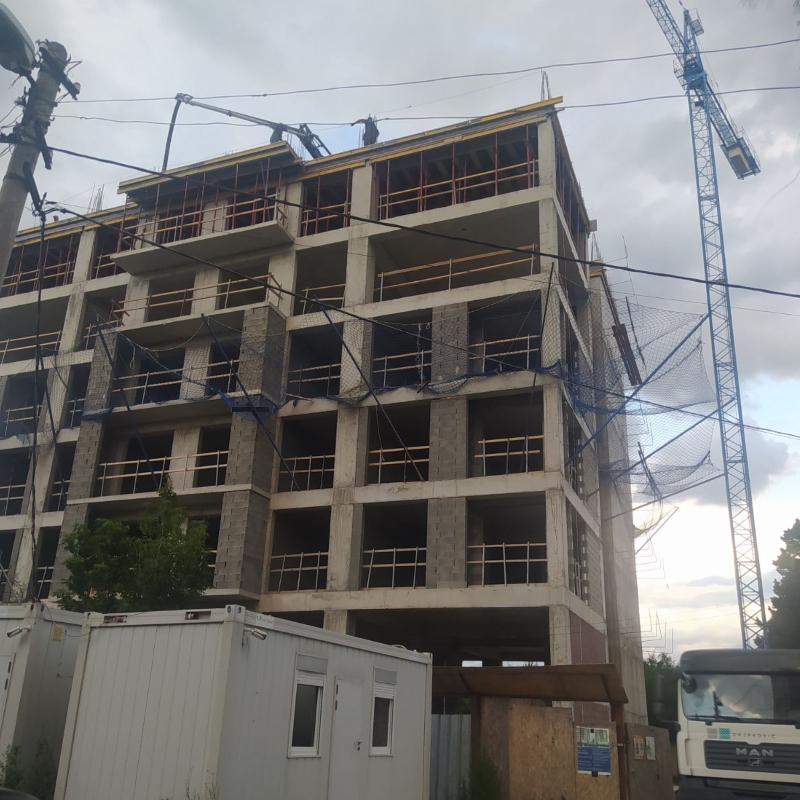

7th Floor

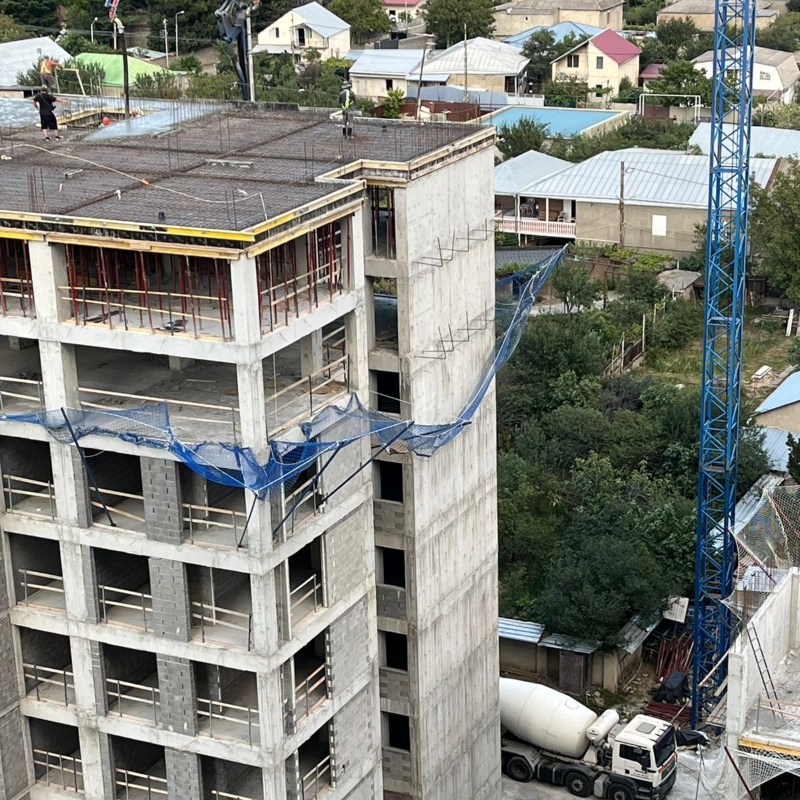

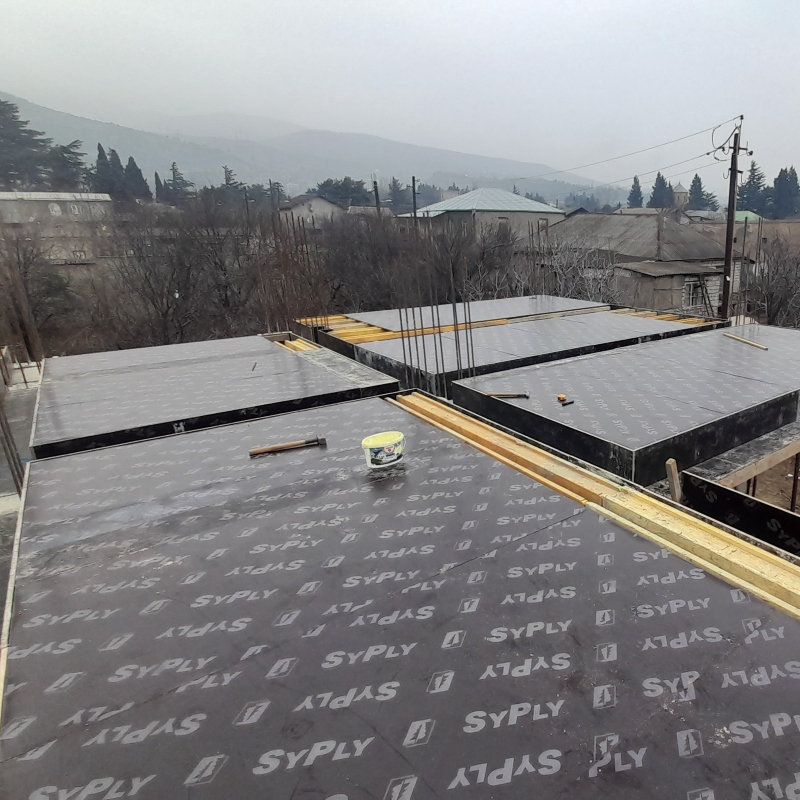

The laying of the slab of the 7th floor on block А has been completed. Arrangement of slab molds for the 3rd floor on block B is in progress.

7th Floor
timeline 16
17
02 June -2023

6th Floor

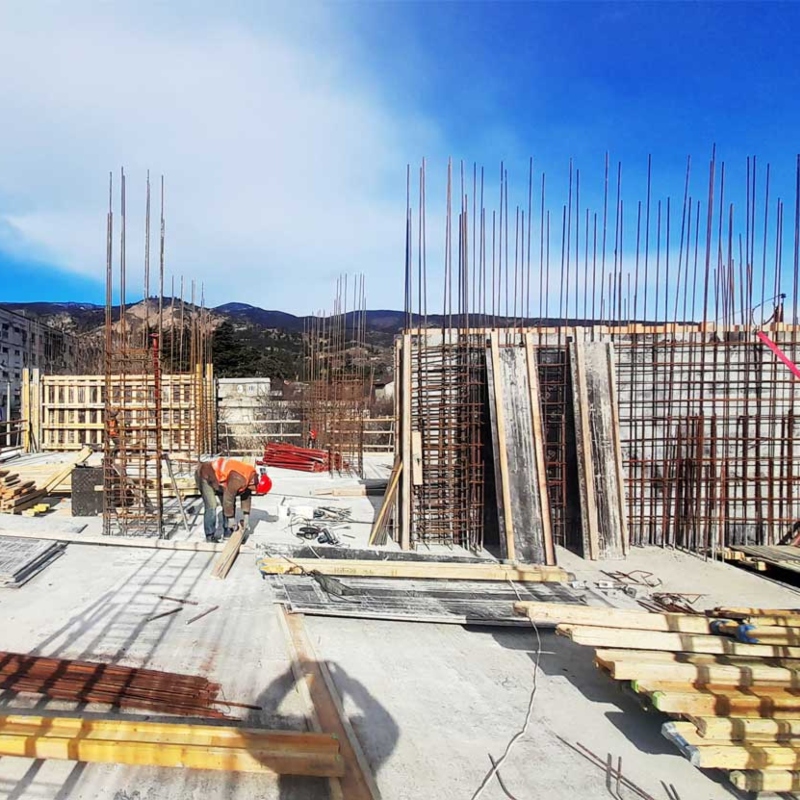

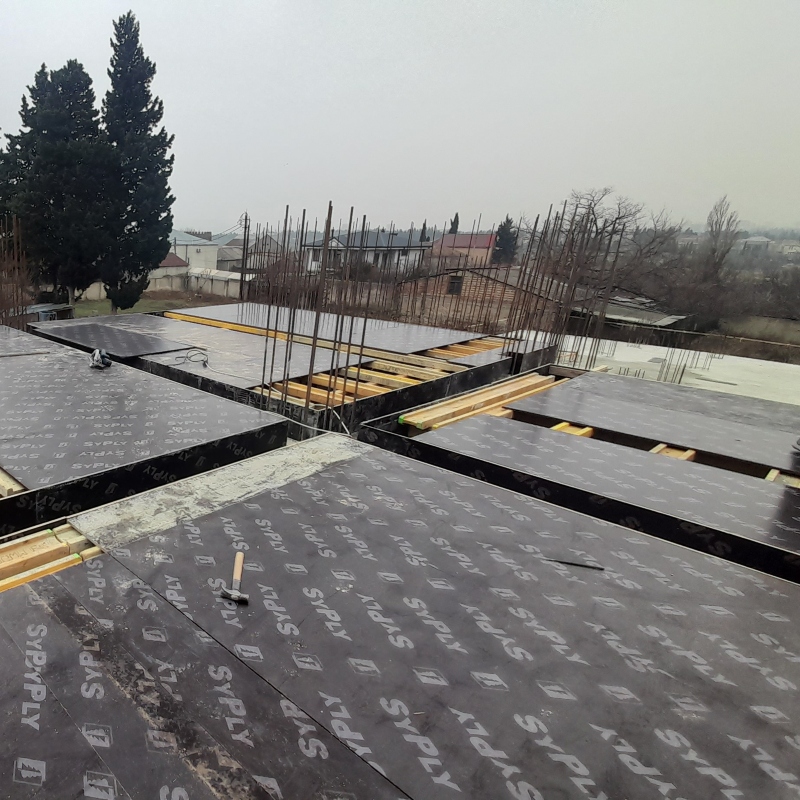

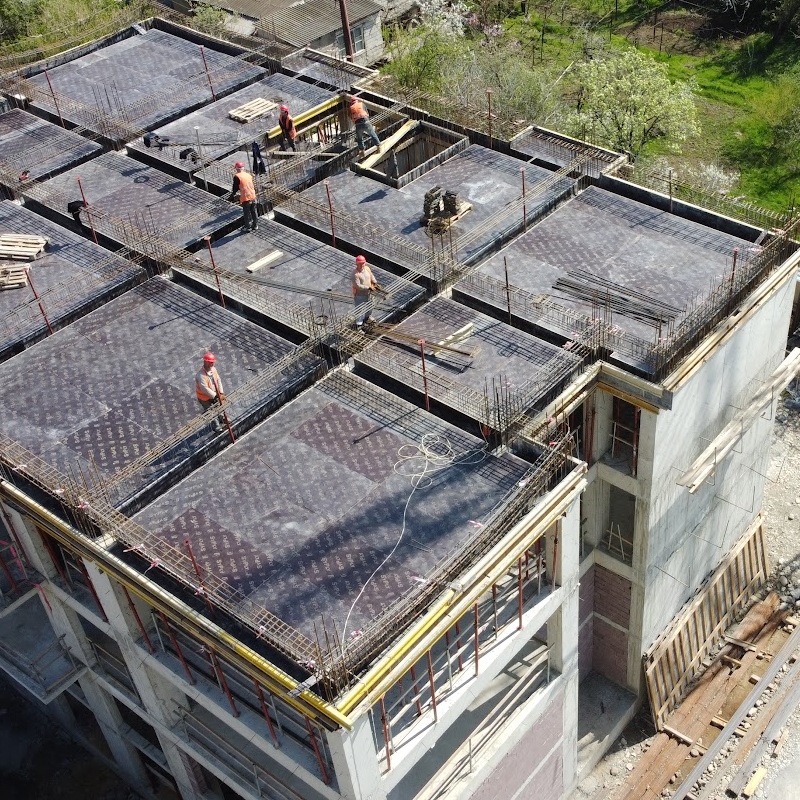

In Avchala, in sector A, the floor of the 6th floor was laid, and the almatur needed for the current convoys was poured. Also, in agreement with the tenants, the construction of internal partitions was completed on the 4th floor, and the construction of external partitions on the 5th floor is underway.

6th Floor
timeline 17 timeline 17
18
05 May -2023

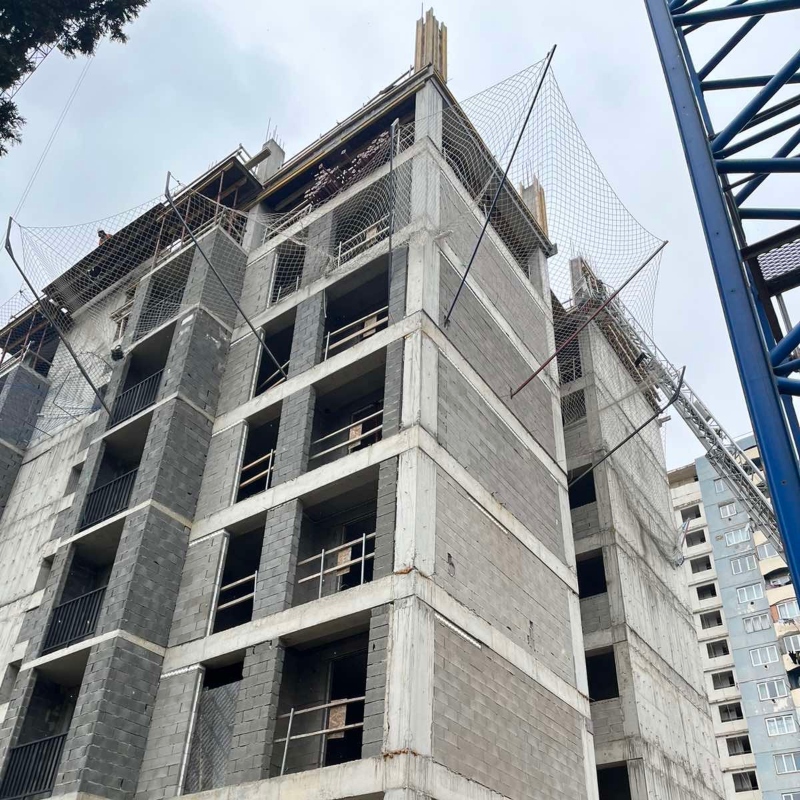

5th floor

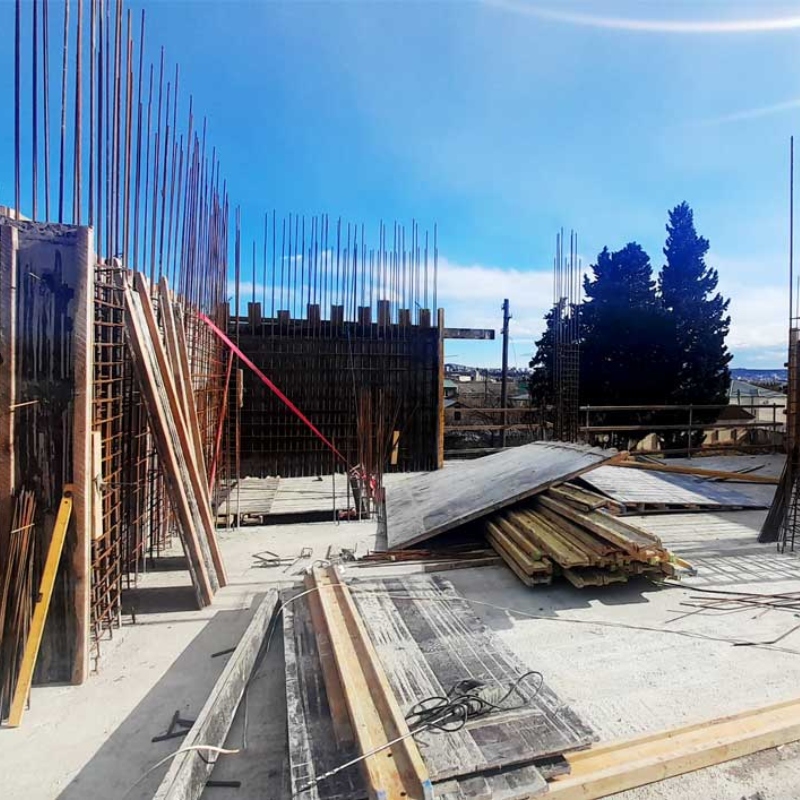

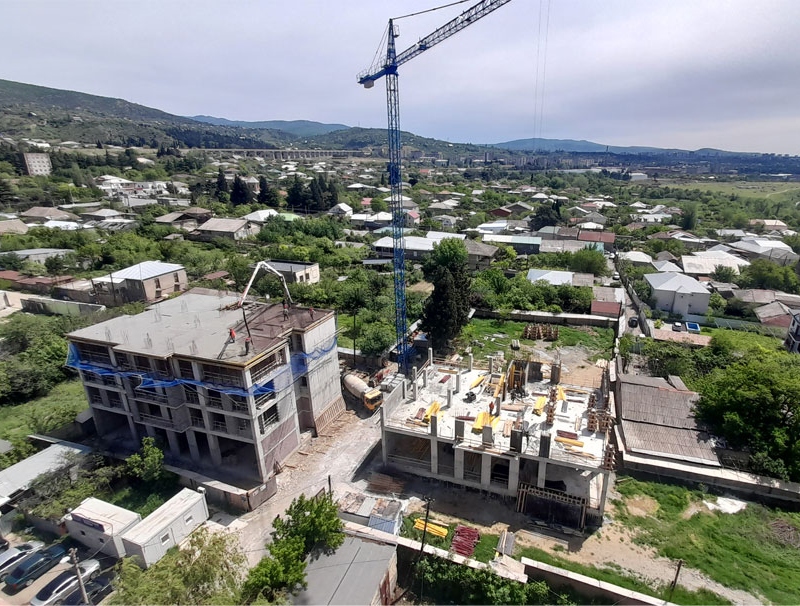

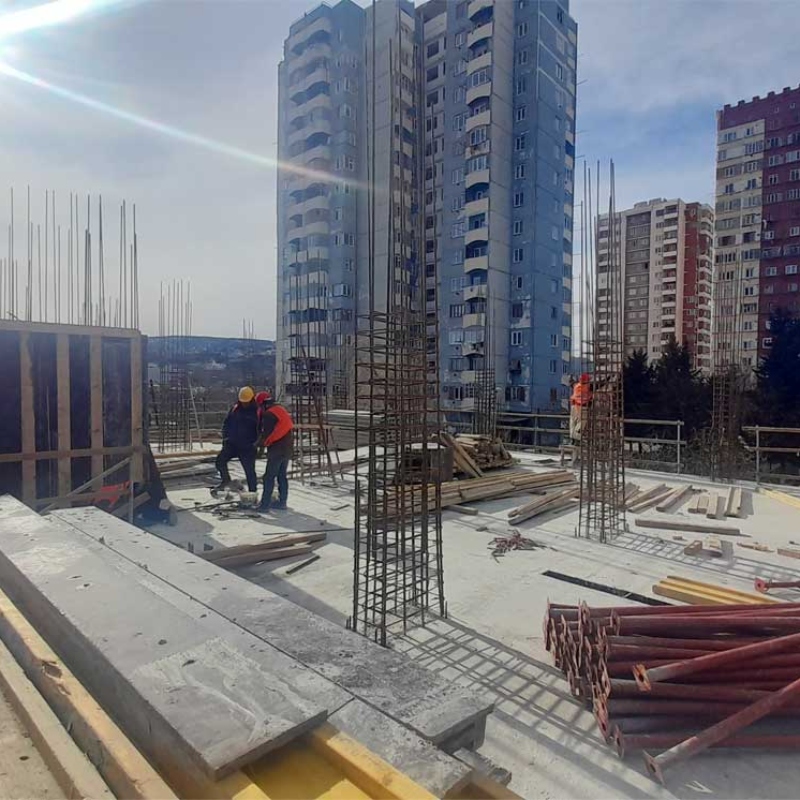

In Avchala, the 5th floor tile was poured on block А. On the built floors, the apartments are being opened and walls are being erected on the facade. And in block B, column diaphragms were arranged on the 2nd floor.

5th floor
timeline 18 timeline 18 timeline 18

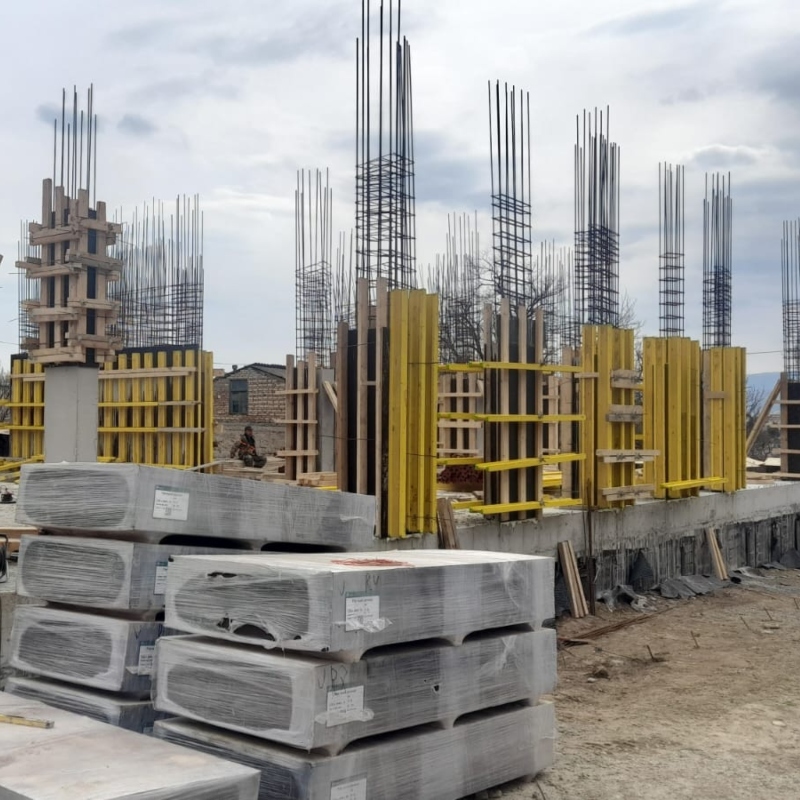

19
03 April -2023

Columns

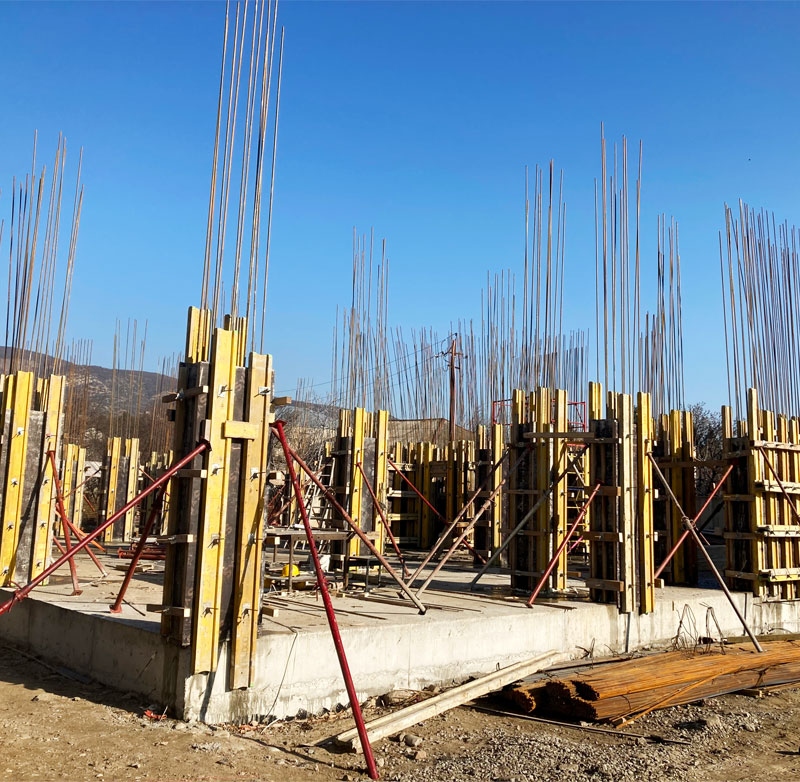

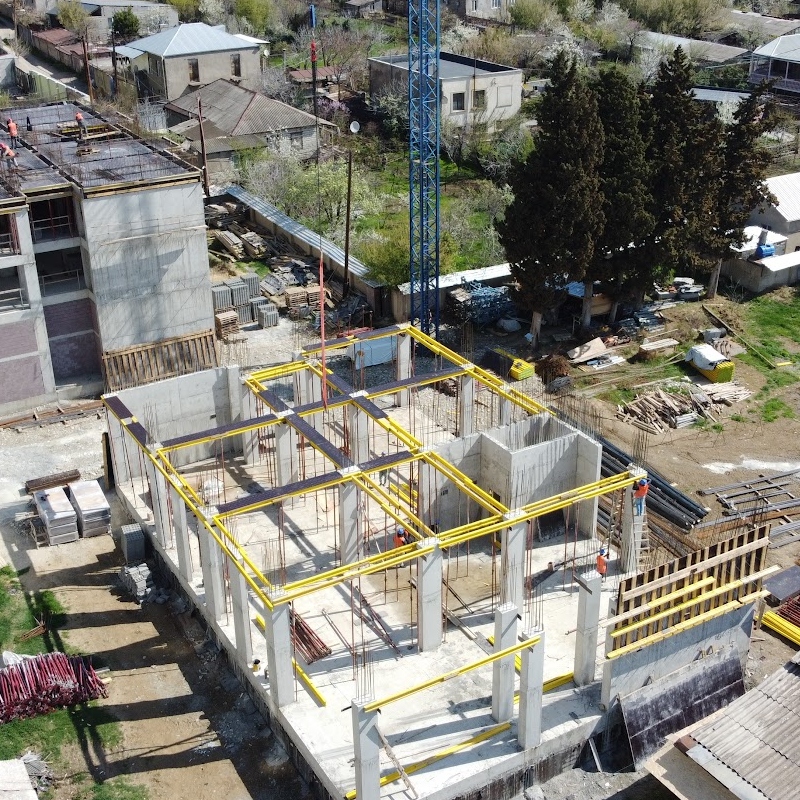

In Avchala Block A the outer and inner partitions of the commercial floor were built. Columns of the fourth floor were poured. In Block B, the commercial floor columns have been poured and preparations are underway to pour the second floor slab.

Columns
timeline 19 timeline 19 timeline 19 timeline 19
20
15 March -2023

3rd Floor tile

Columns of the second floor, elevator shaft and stairs were installed in Avchala sector A. Preparatory work for the third floor slab was also carried out and the slab was poured. Almatura was spun for the columns of the commercial floor in sector B, and the elevator shaft was prepared for pouring concrete.

3rd Floor tile
timeline 20 timeline 20

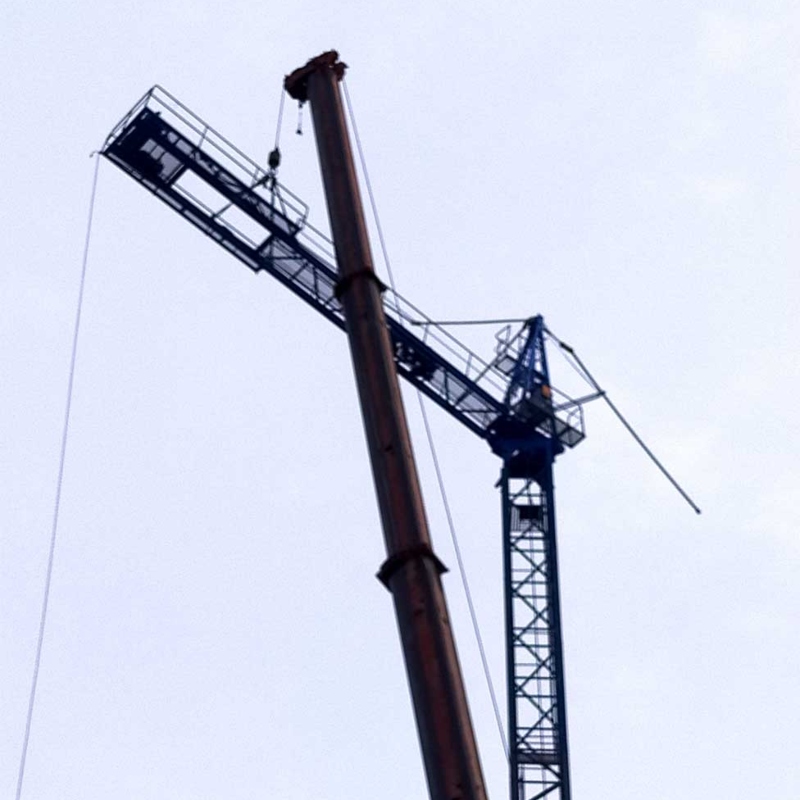

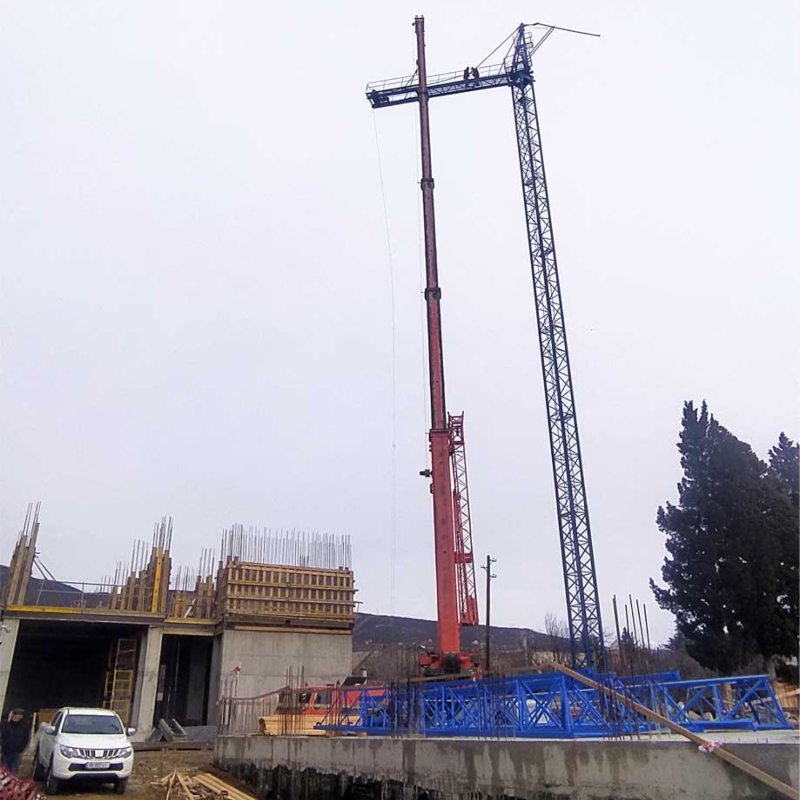

21
20 February -2023

The crane

Tower crane, СОMANSA NT 40100, is being installed. Start of construction of Block B planned in March in parallel mode.

The crane
timeline 21 timeline 21
22
10 February -2023

2nd Floor

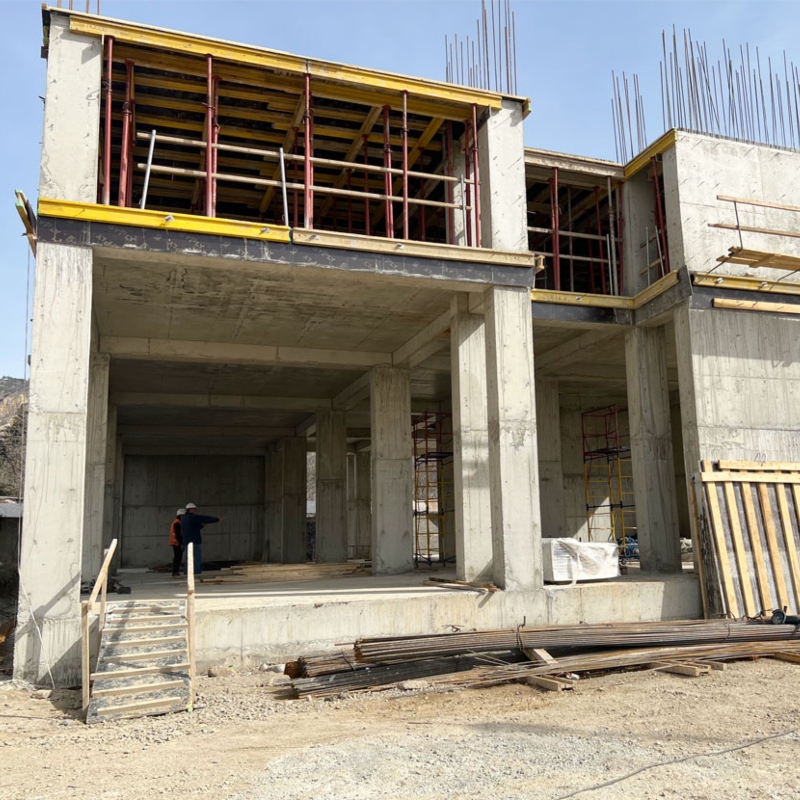

The concrete pouring of the roof of Block A commercial floor has been completed. Next step erection and installation of the rebars frames on the Second living floor.

2nd Floor
timeline 22 timeline 22
23
24 January -2023

Commercial roofing

Roofing slabs of the commercial floor of Block A are in progress.

Commercial roofing
timeline 23 timeline 23 timeline 23
24
20 December -2022

Columns

In block A, the columns and walls of the commercial floor were poured. In block B, the construction of the columns of the commercial floor is in progress.

Columns
timeline 24 timeline 24 timeline 24 timeline 24

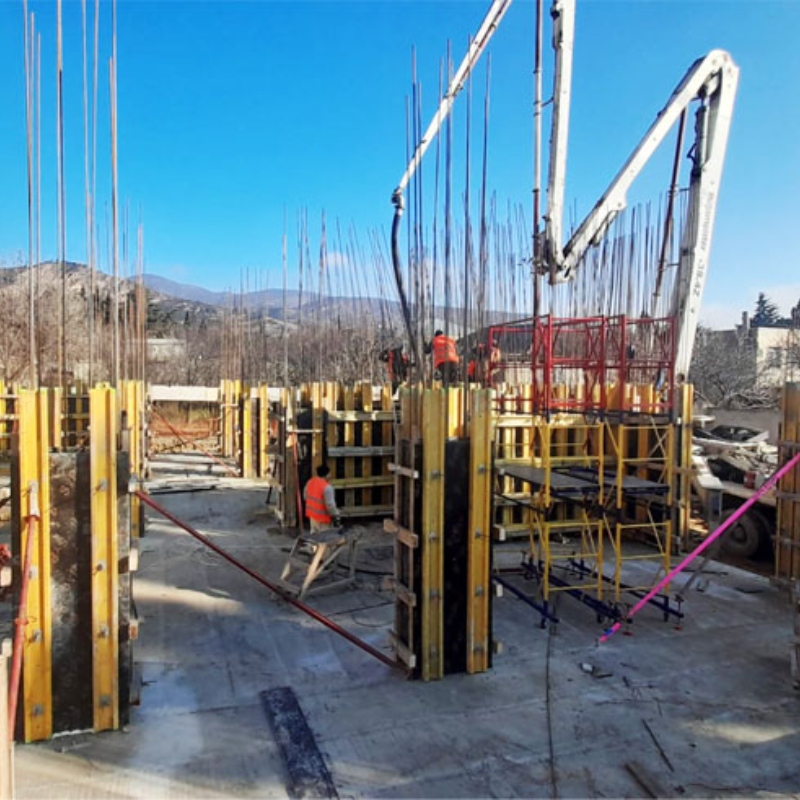

25
01 November -2022

Commercial floor

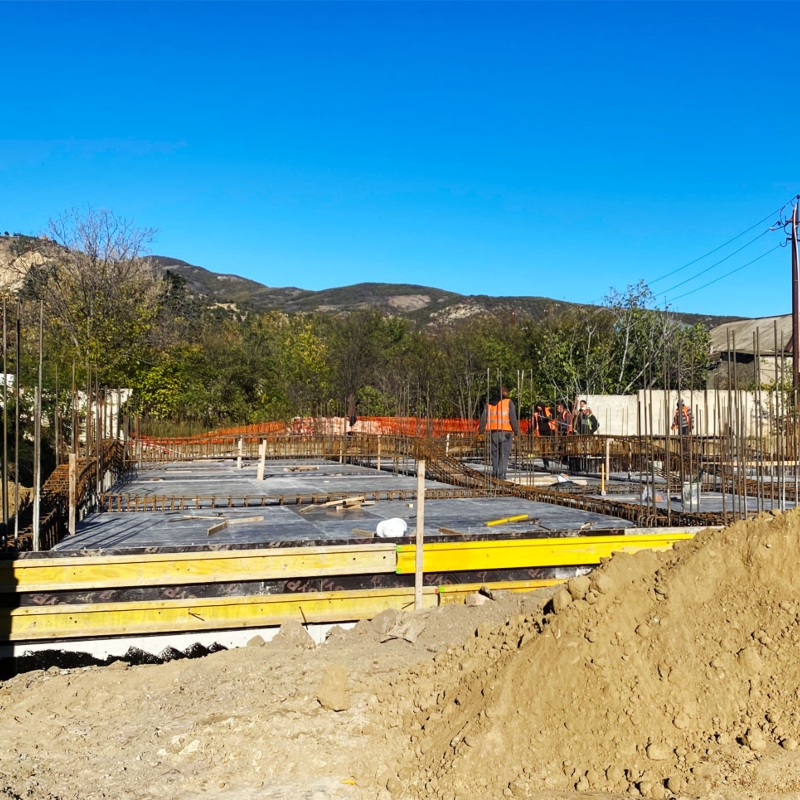

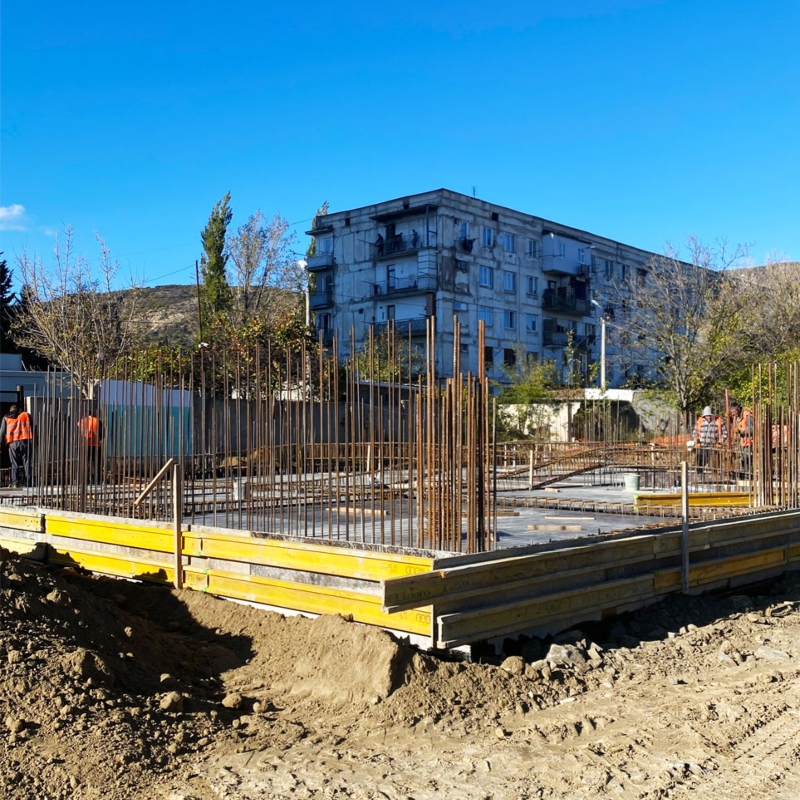

In block A, the laying of the slab of the commercial floor is in progress, and in block B, the laying of the column of the 0th floor is in progress.

Commercial floor
timeline 25 timeline 25 timeline 25

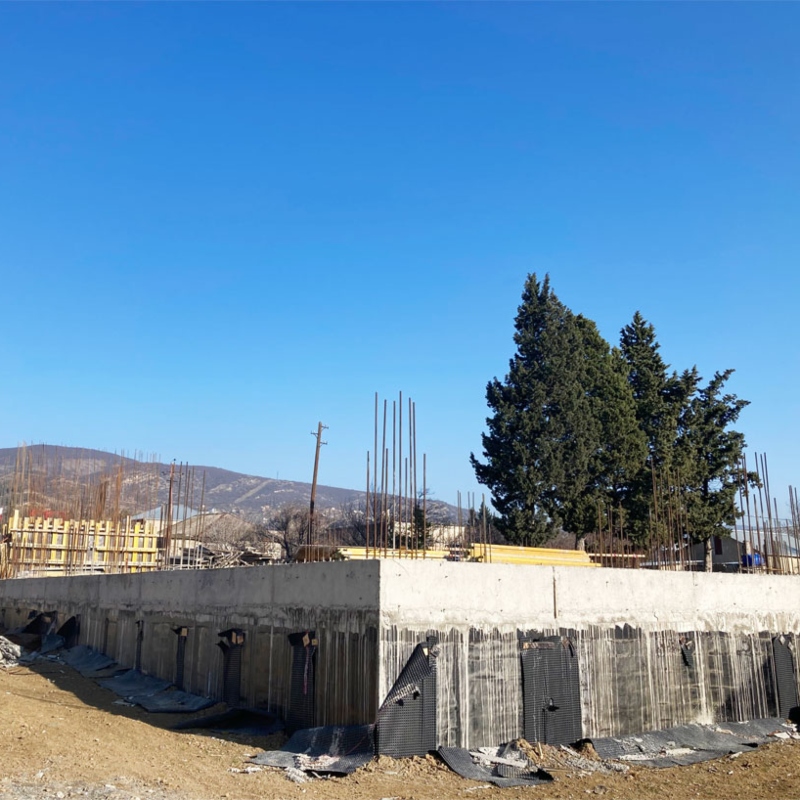

26
10 October -2022

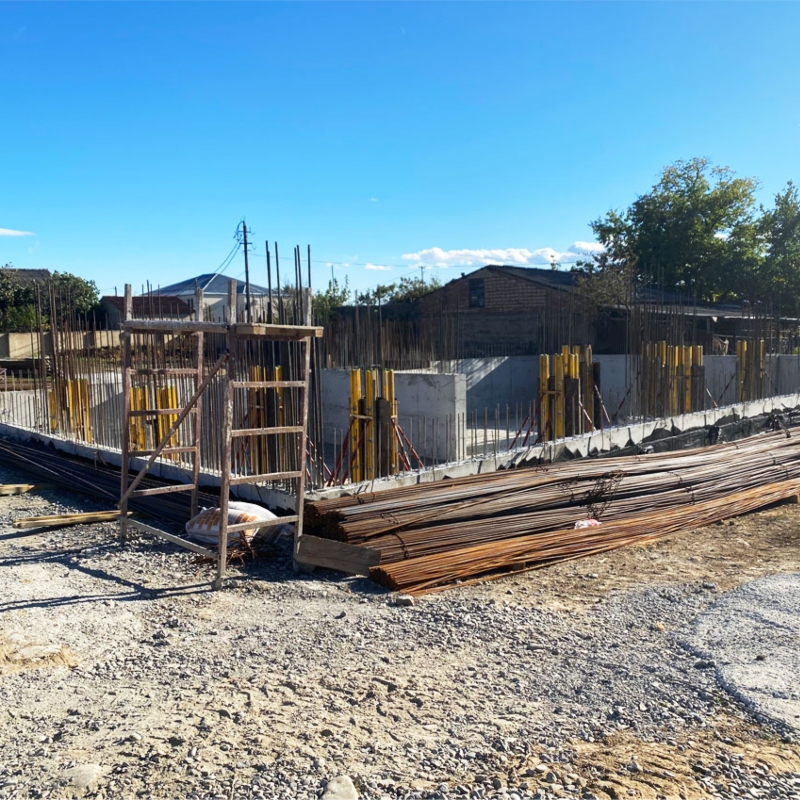

Block A

The walls of the underground floor of block A were poured. In the next week, the waterproofing of the walls will be arranged and the earth will be backfilled into the foundation.

Block A
timeline 26 timeline 26
27
04 October -2022

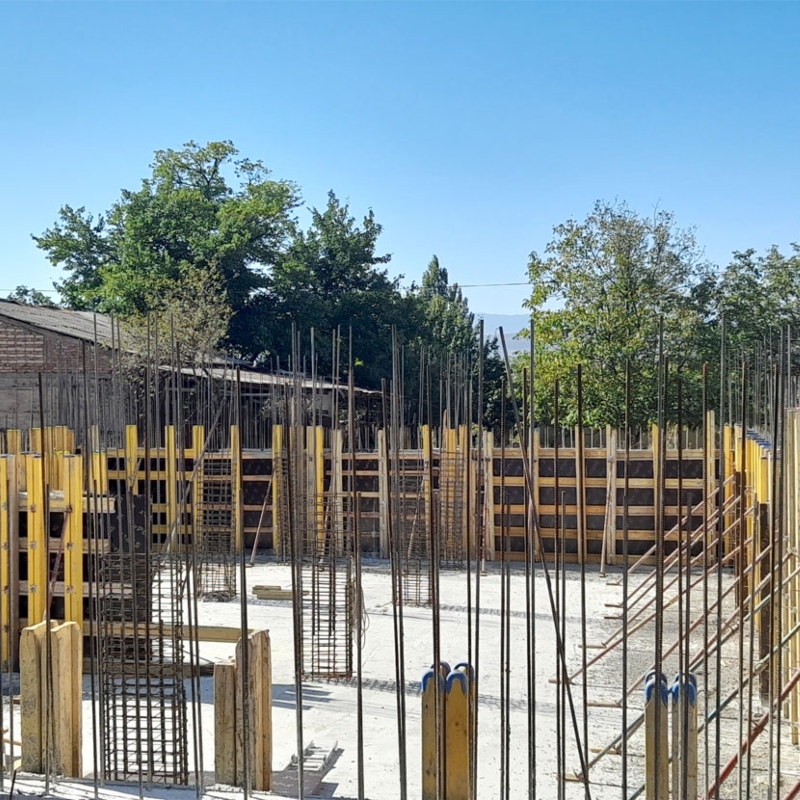

Walls

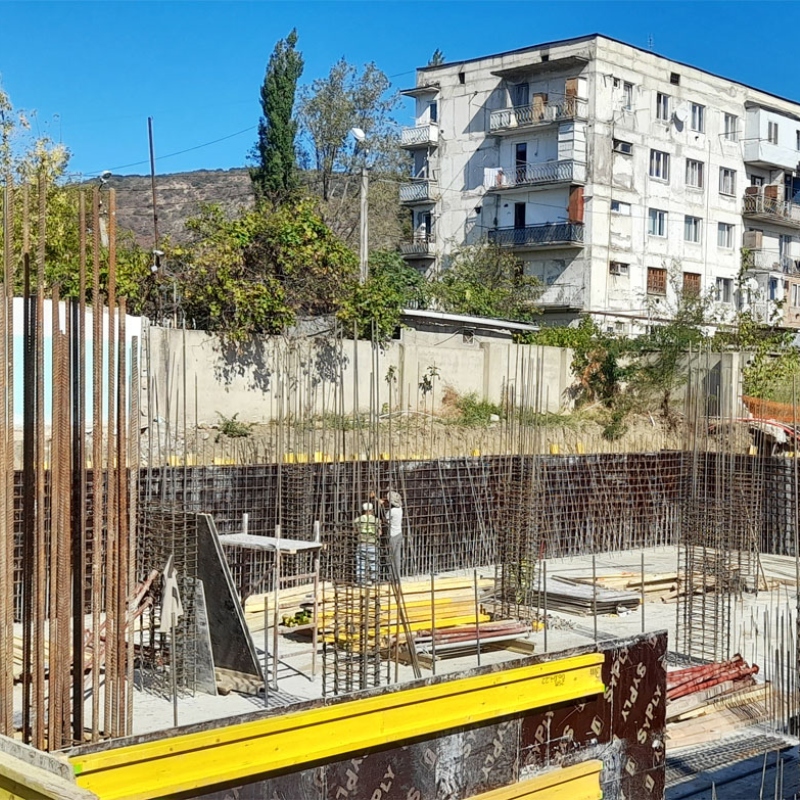

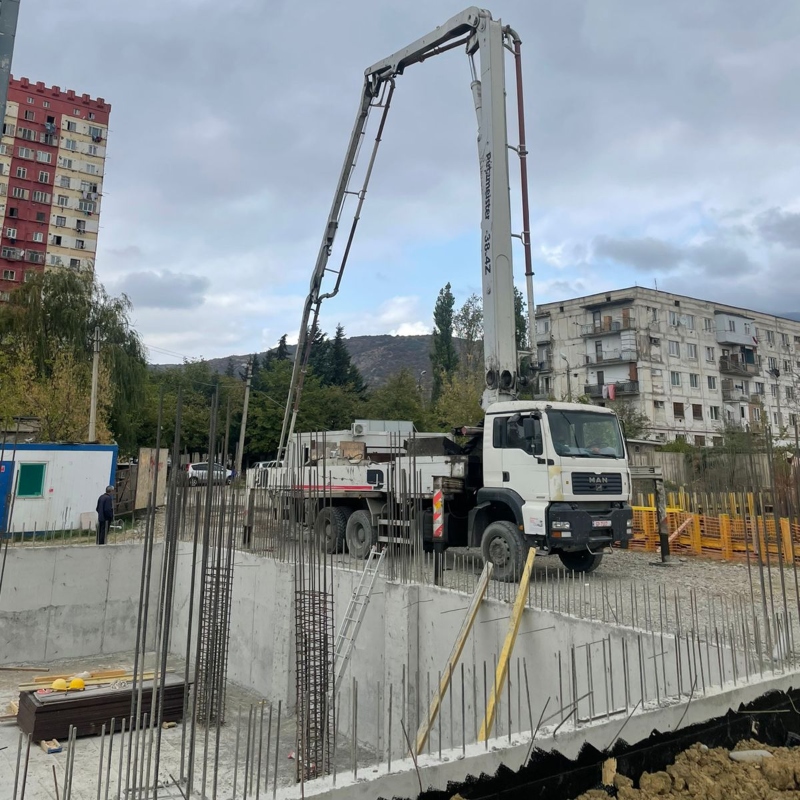

Foundation walls and columns are made on block A Reinforced concrete slab, reinforced concrete basement walls and diaphragms are poured on block B.

Walls
timeline 27 timeline 27
28

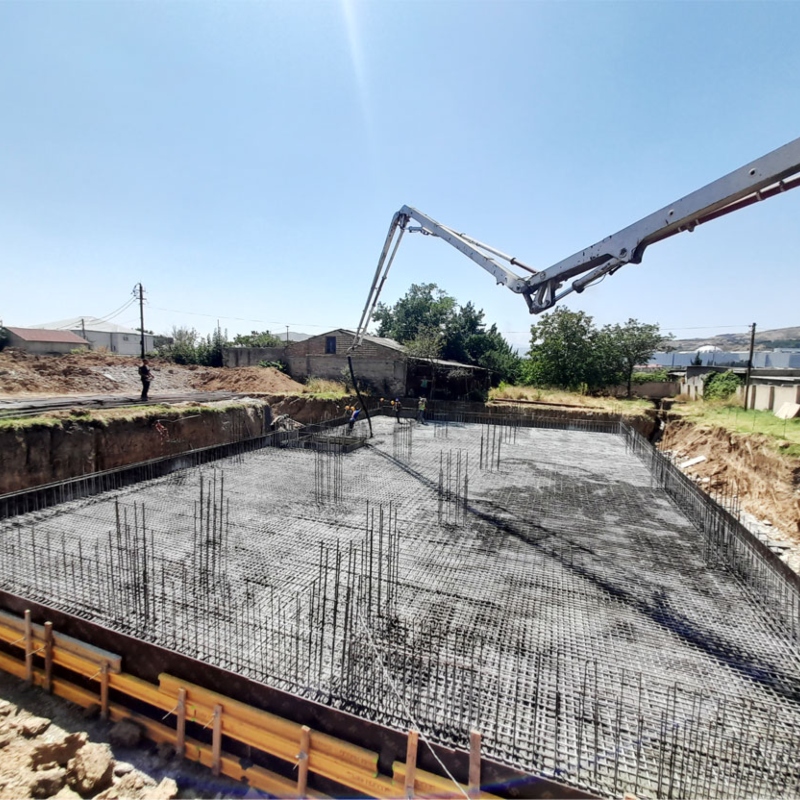

22 September -2022

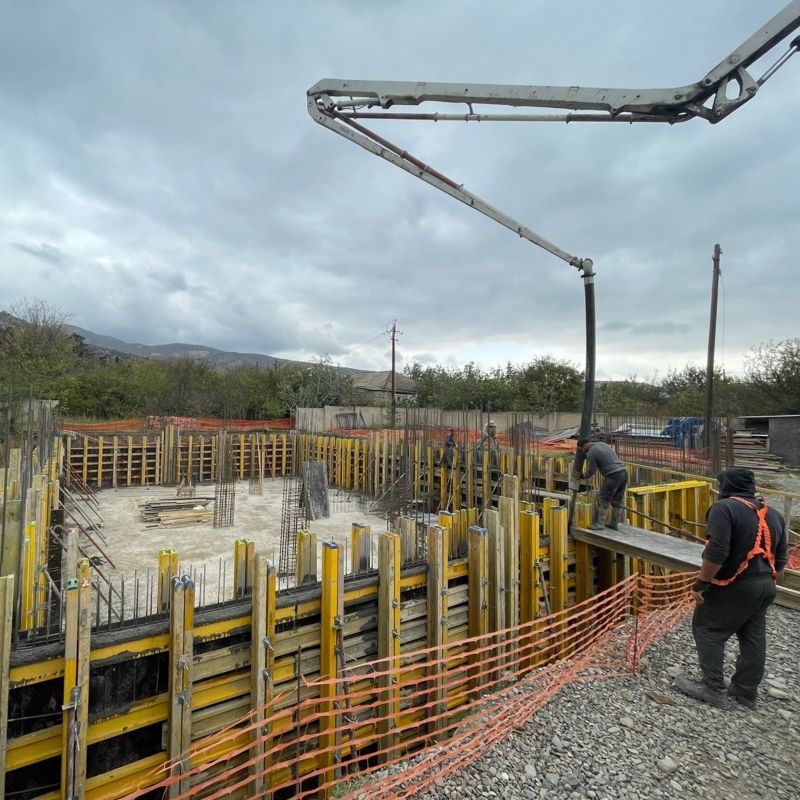

Underground Floor

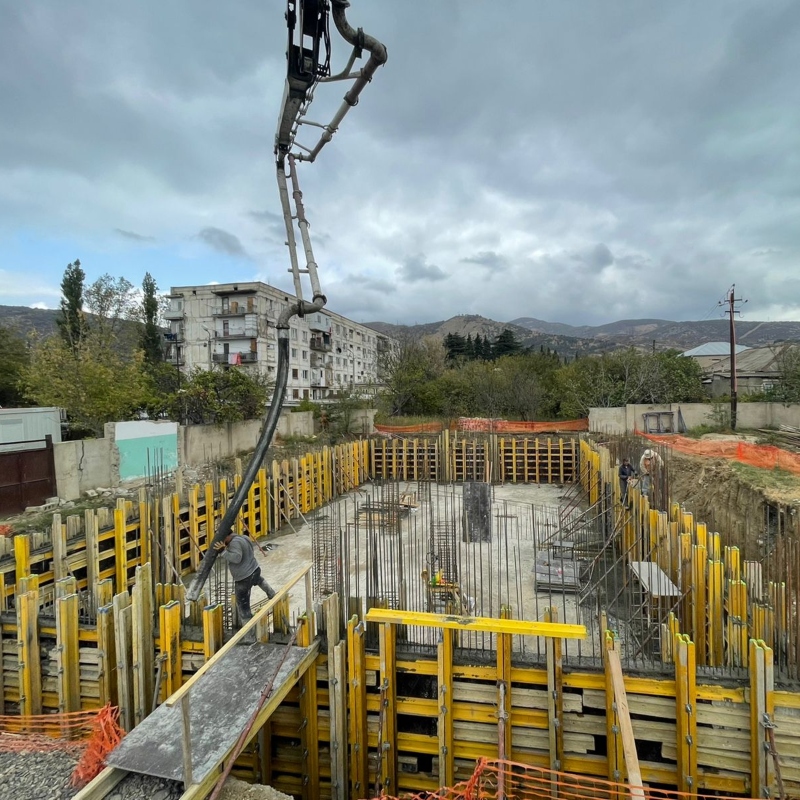

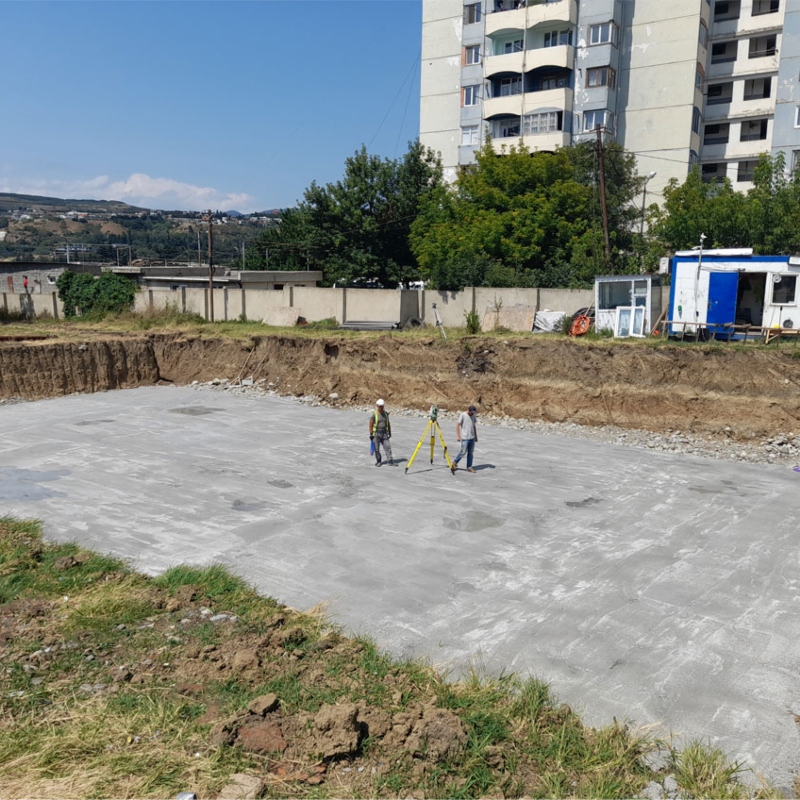

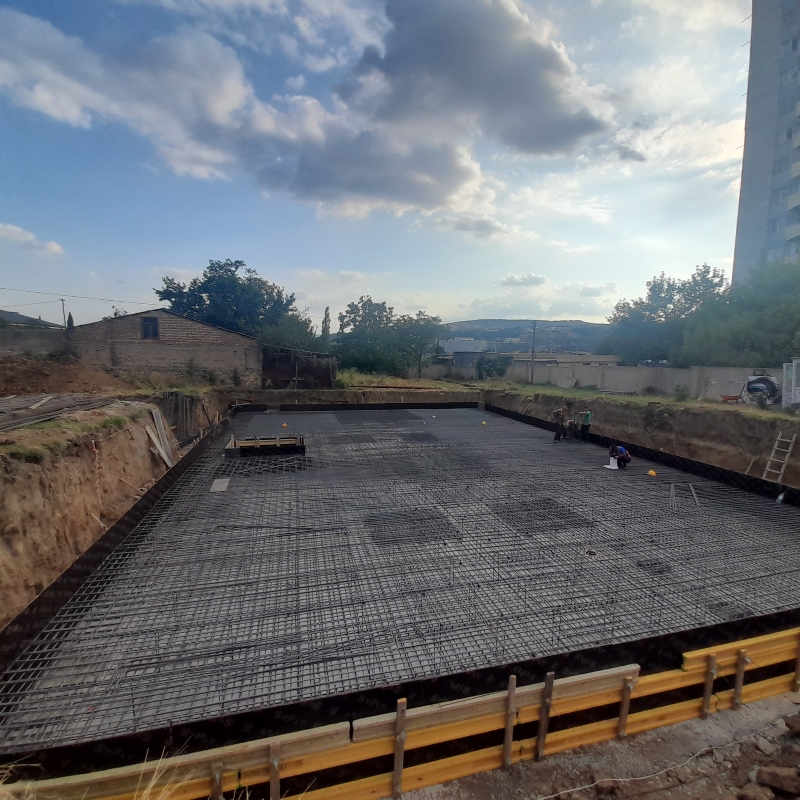

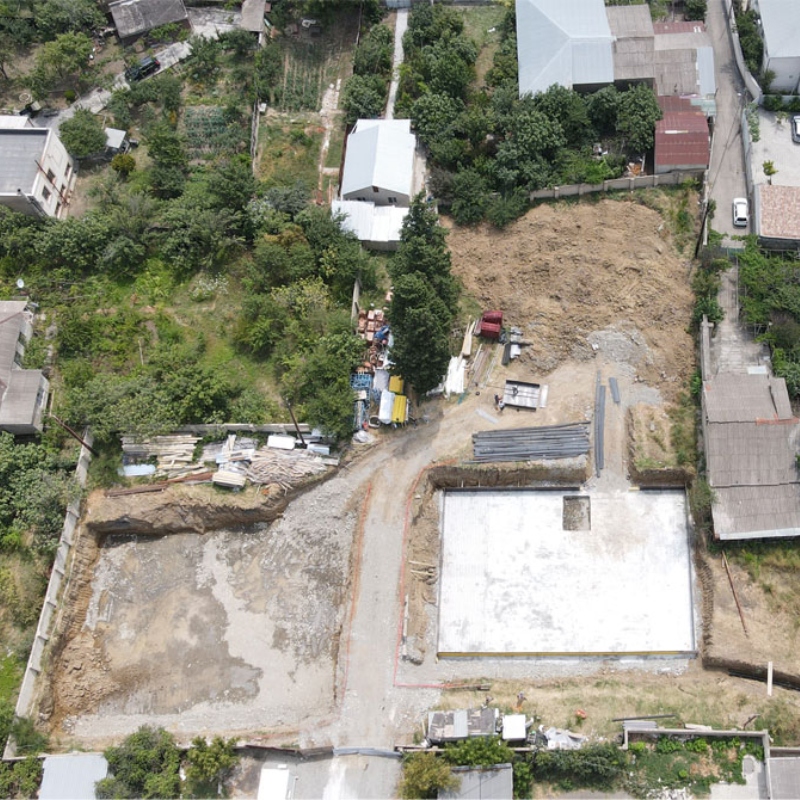

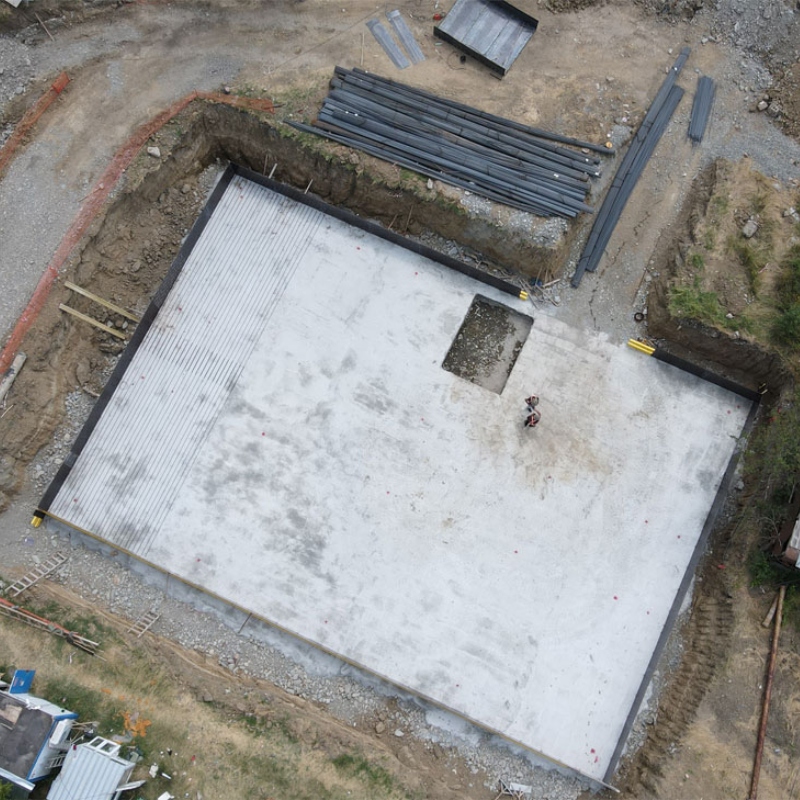

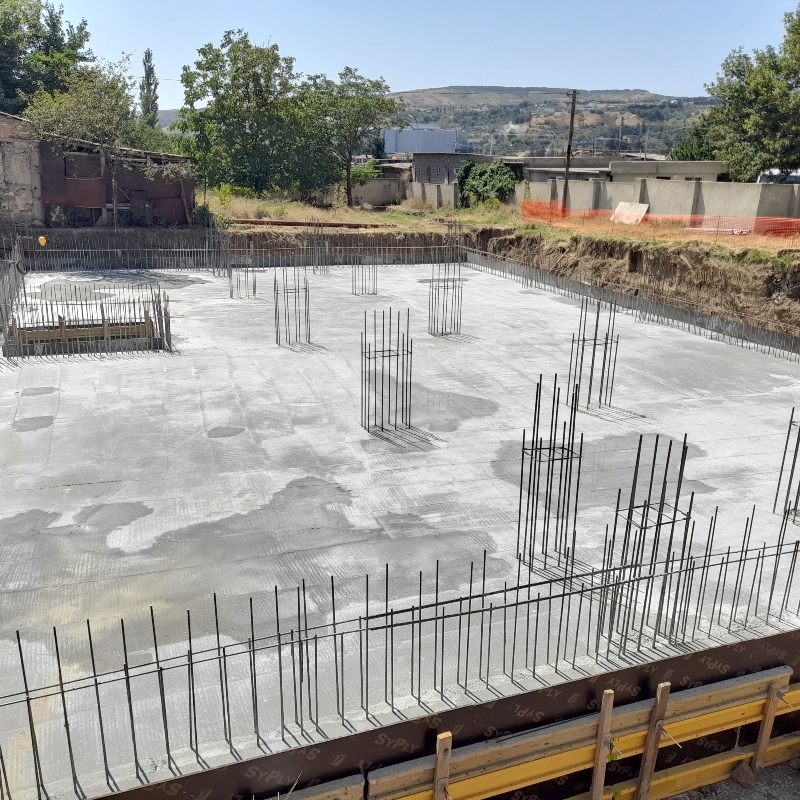

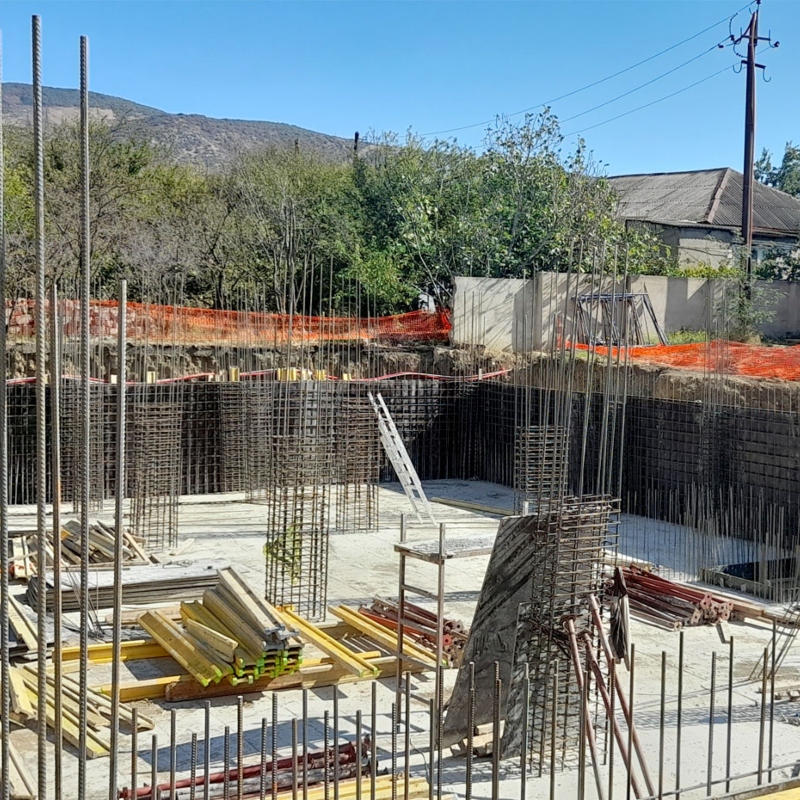

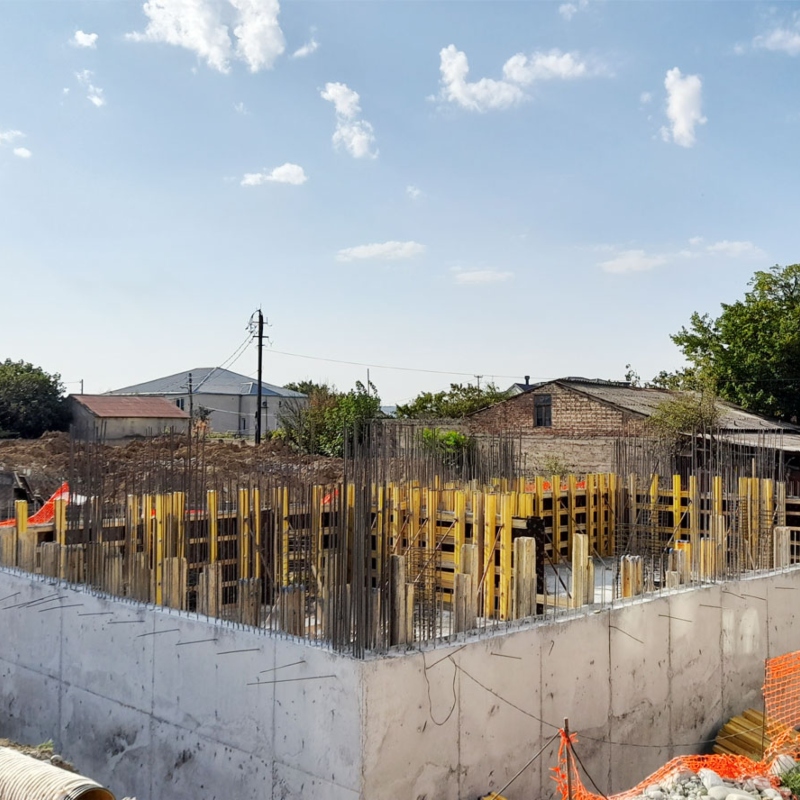

The foundation slab of block A is poured. on 440m2. The walls of the underground floor of Block B are poured. By the end of the month, it is planned to pour the walls of the underground floor of block A and waterproof the outer perimeter of its walls.

Underground Floor
timeline 28
29
01 September -2022

walls and columns

In block A, the foundation slab is being prepared, and in block B, reinforced concrete walls and columns are being built.

walls and columns
timeline 29 timeline 29
30

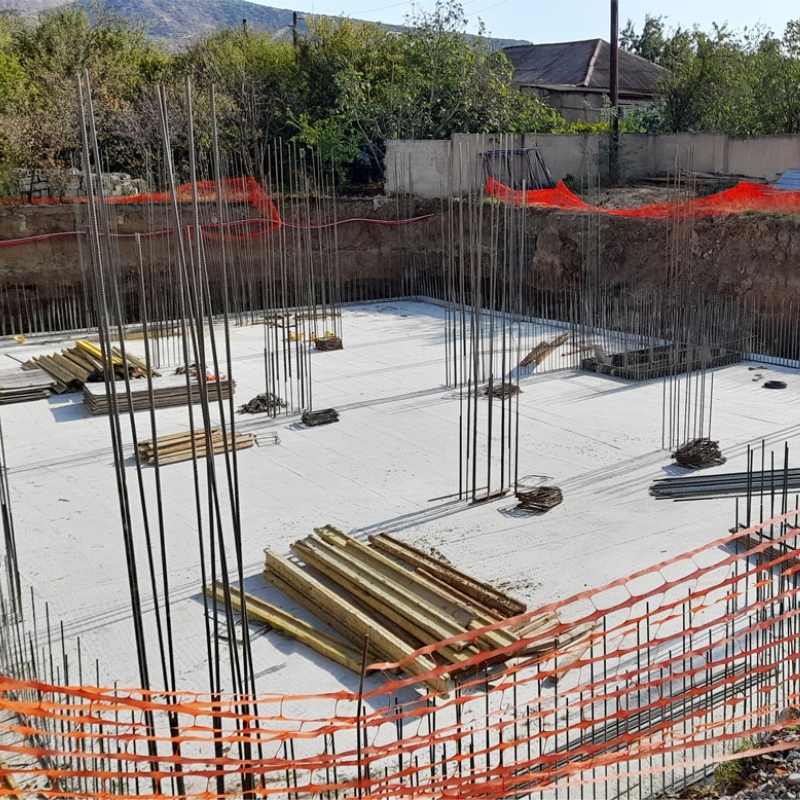

16 August -2022

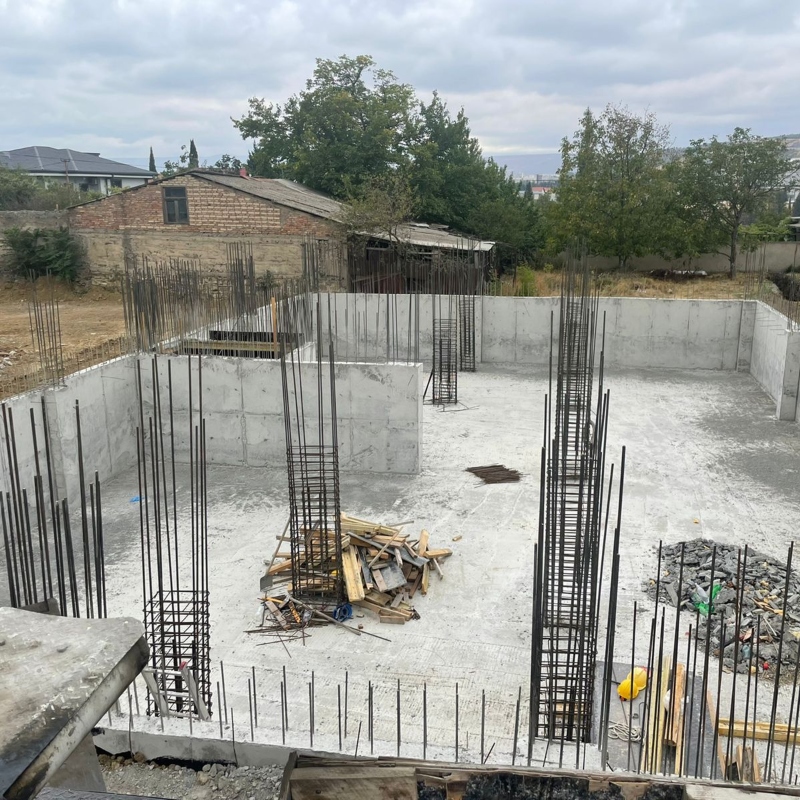

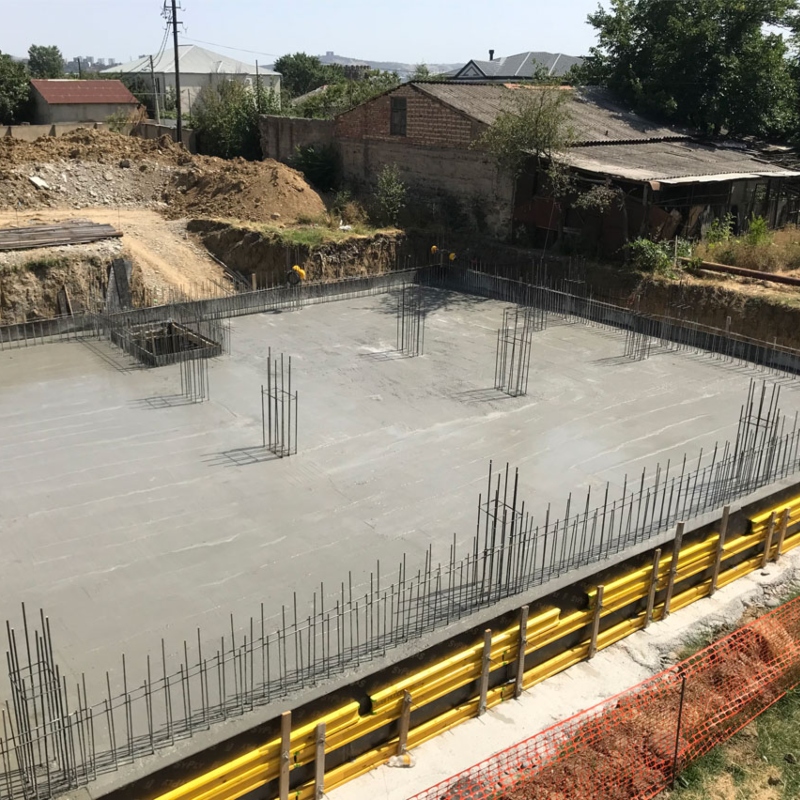

The foundation laid

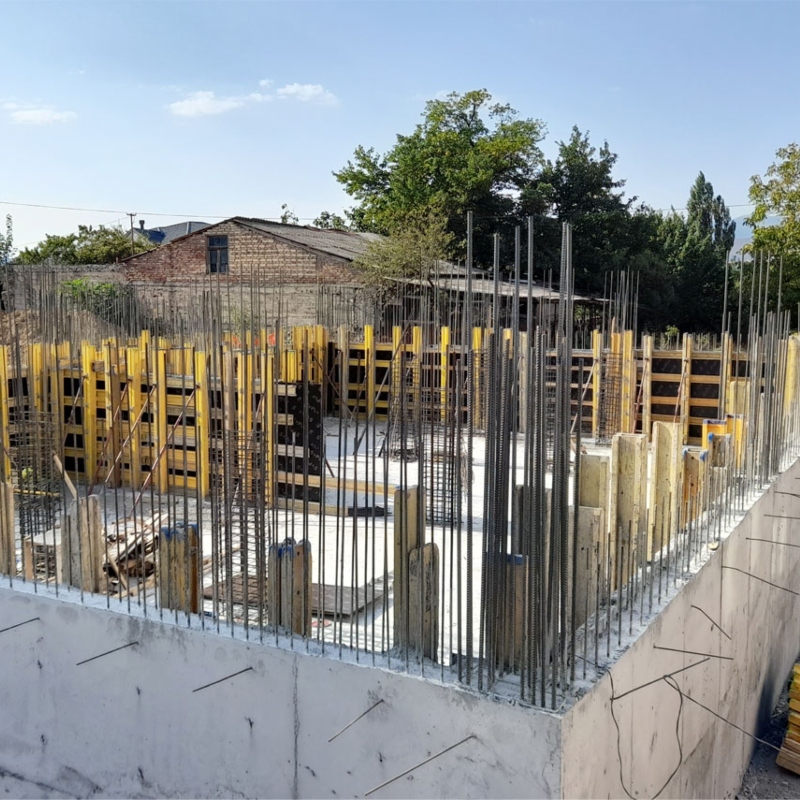

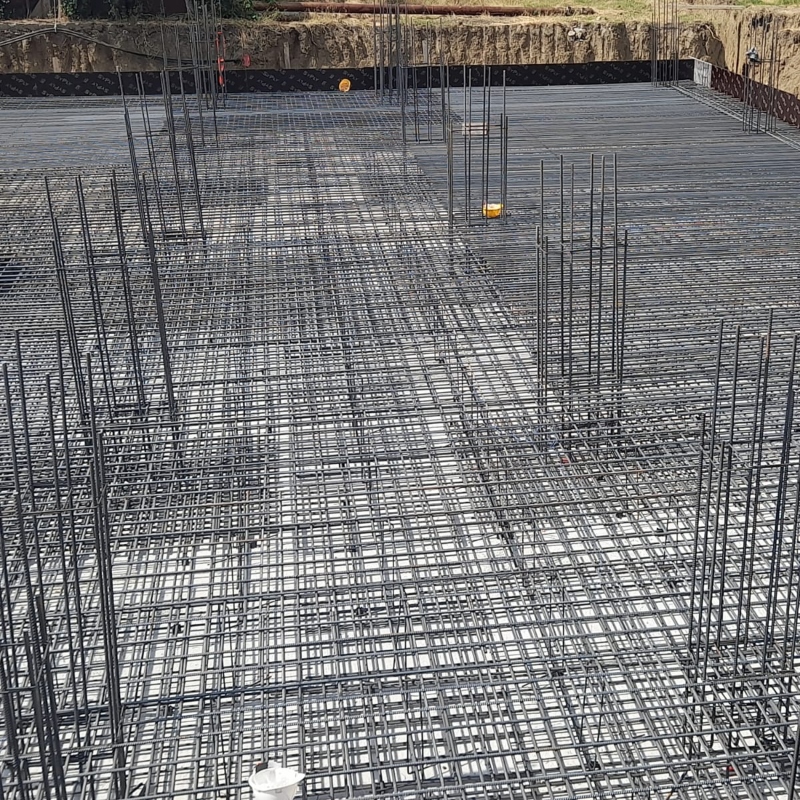

The foundation of block B was laid. 80 cm thick at the -3.00 mark. We are starting to arrange the walls and roofing structures of the underground floor. as well as reinforcement of the foundation of block A.

The foundation laid
timeline 30 timeline 30 timeline 30 timeline 30
31
03 August -2022

Foundation

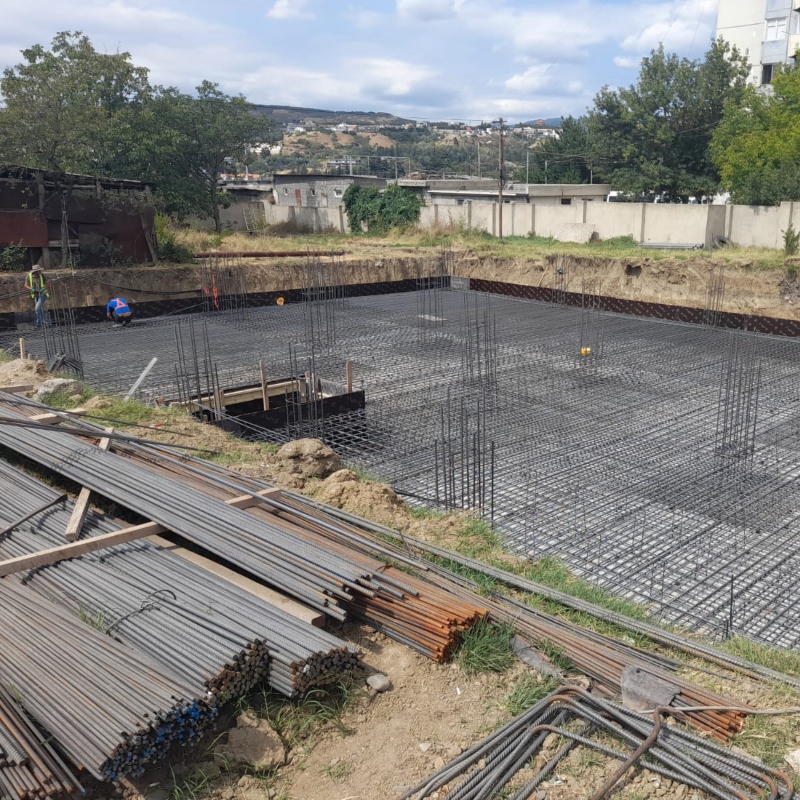

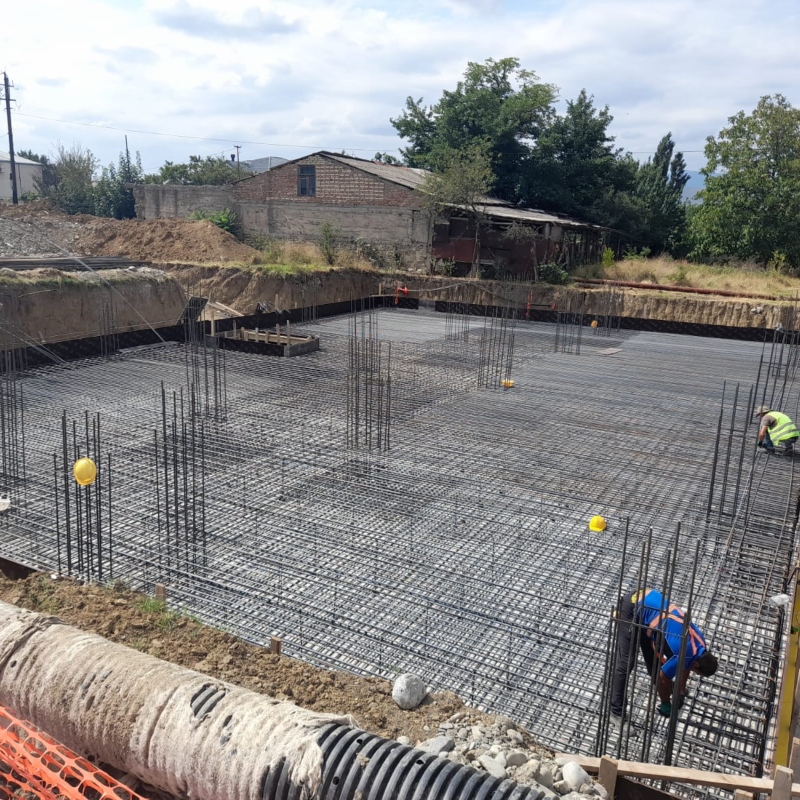

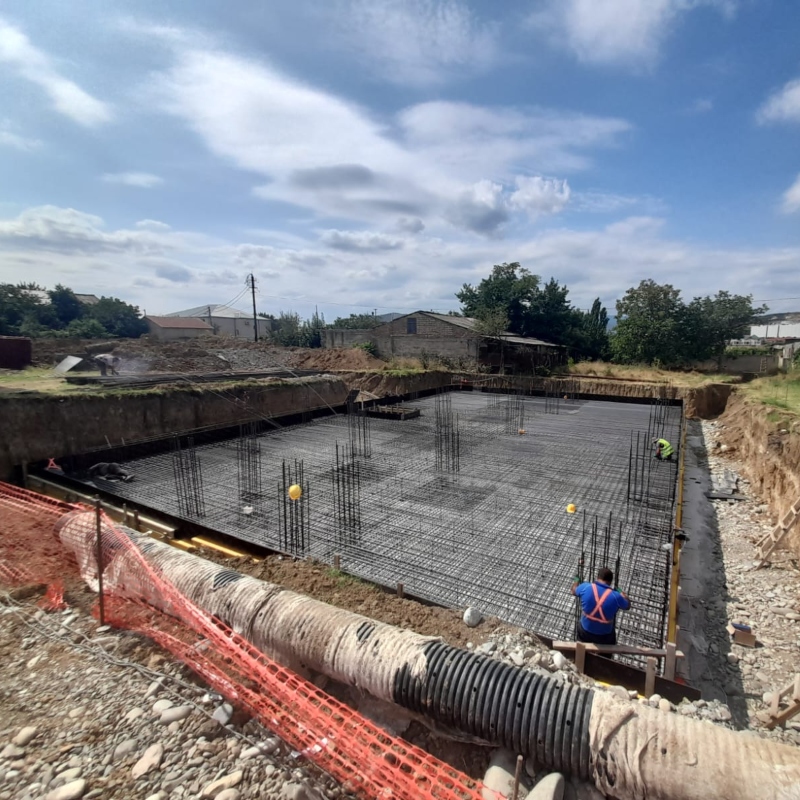

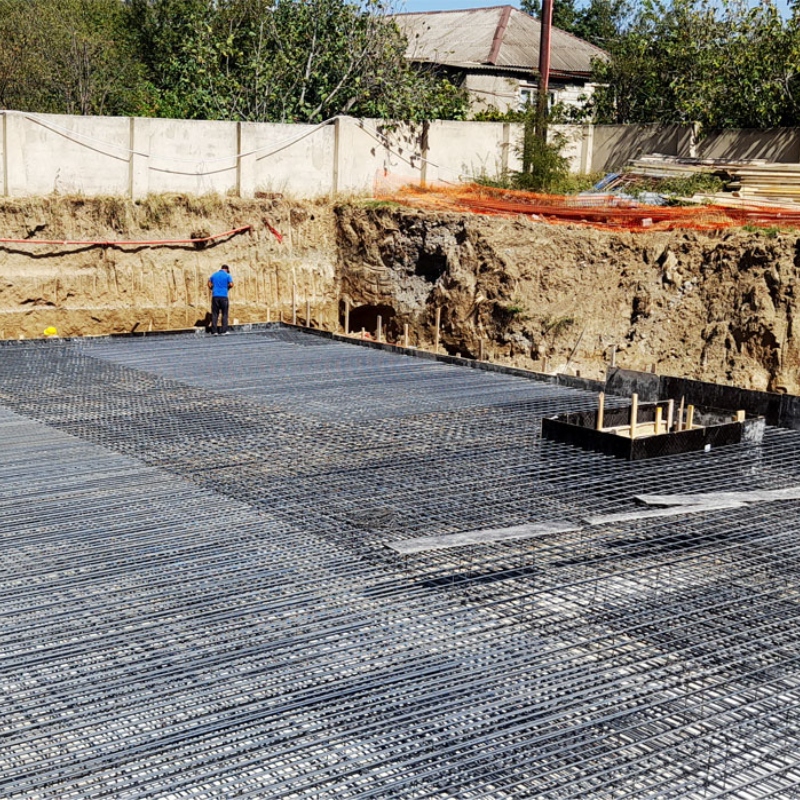

At this stage, the reinforcement of the foundation slab is underway.

Foundation
timeline 31 timeline 31 timeline 31 timeline 31
32

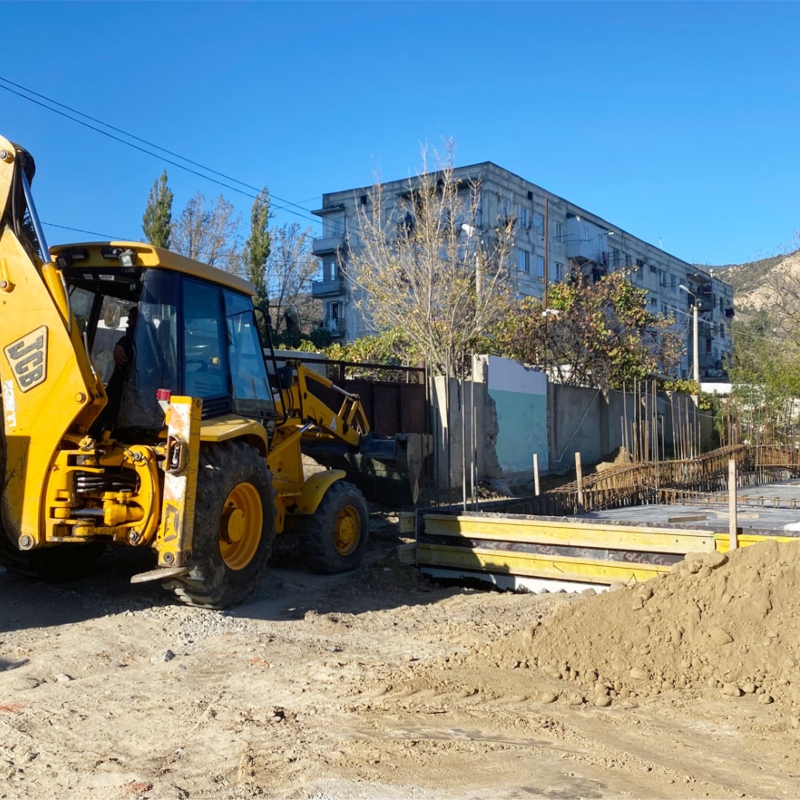

16 July -2022

Land works

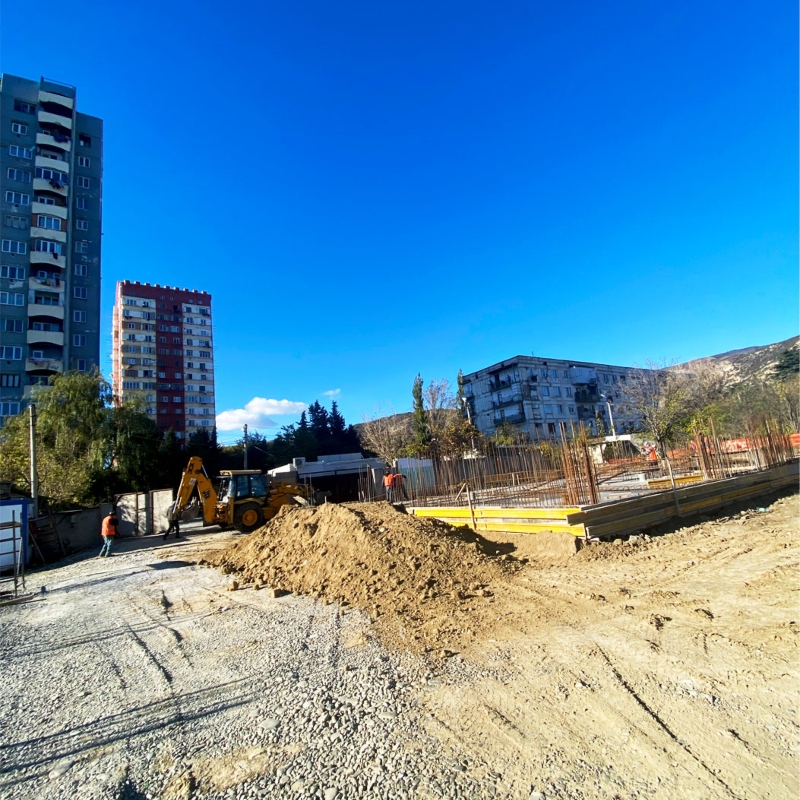

Construction has started in Avchala, and at this stage, land is being cut for the foundation.

Land works
33
22 June -2022

Preparation

The surrounding area is being rehabilitated and preparations are underway for the ground works.

Preparation
