01

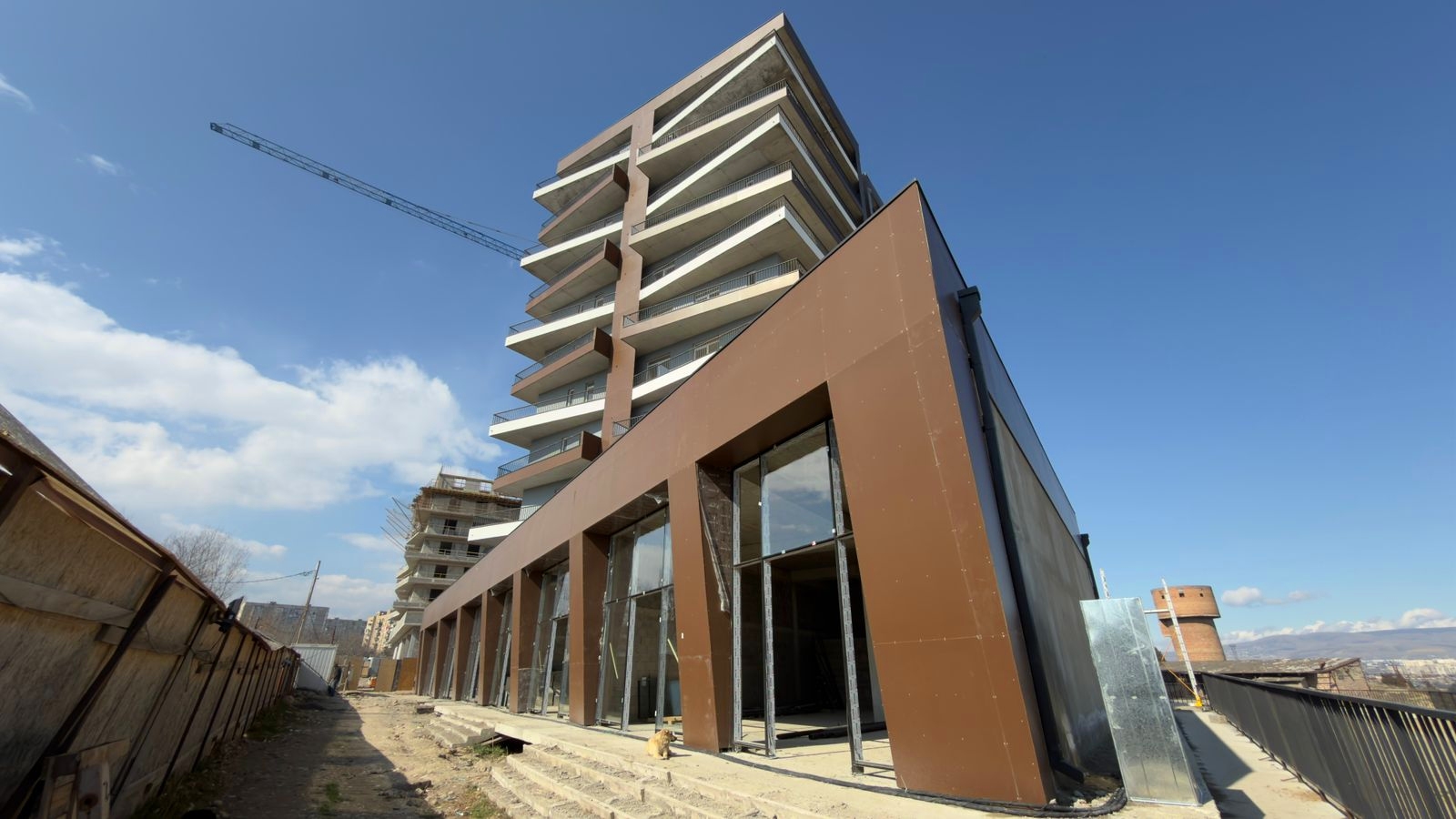

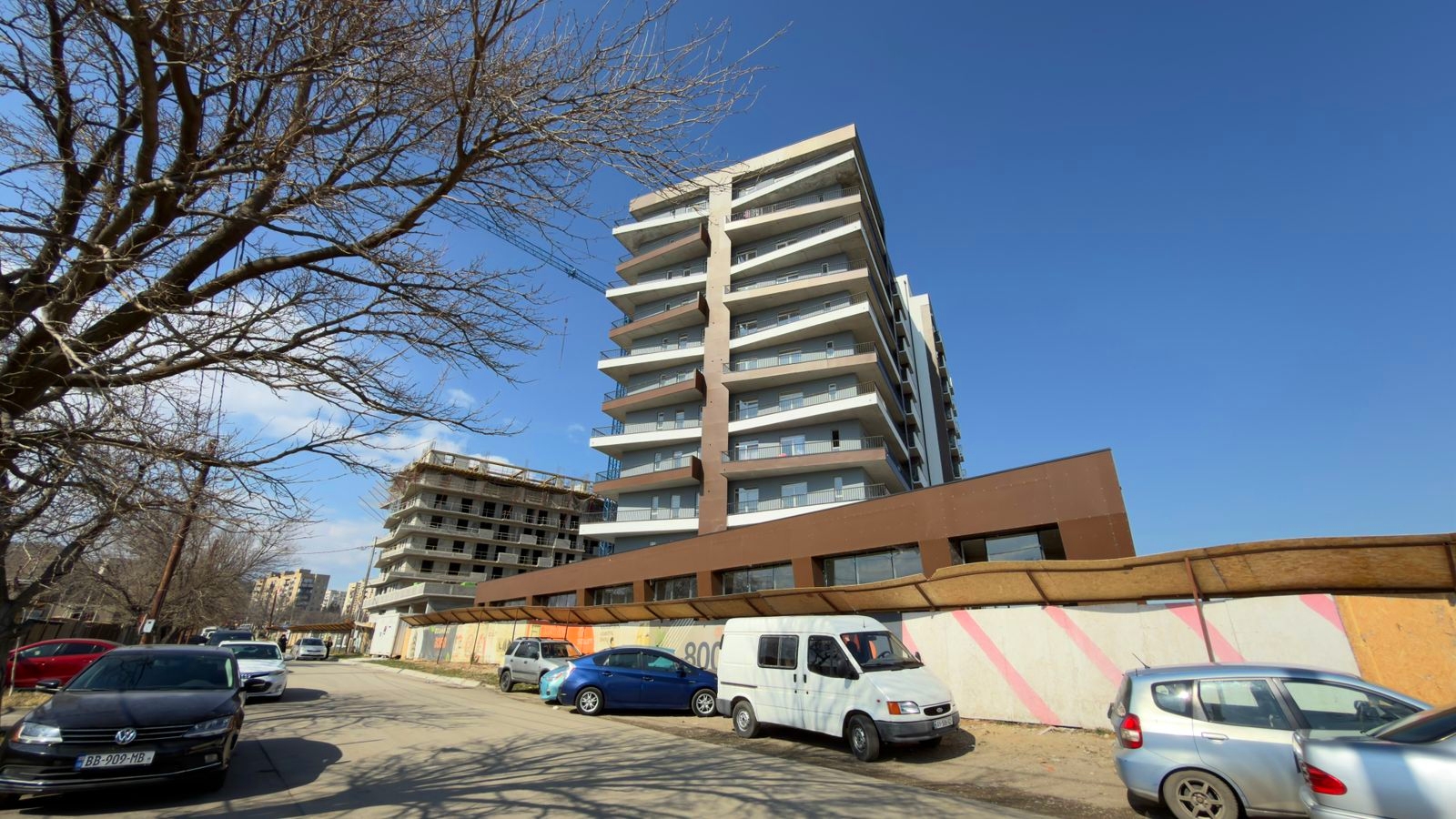

22 June -2025

3rd floor

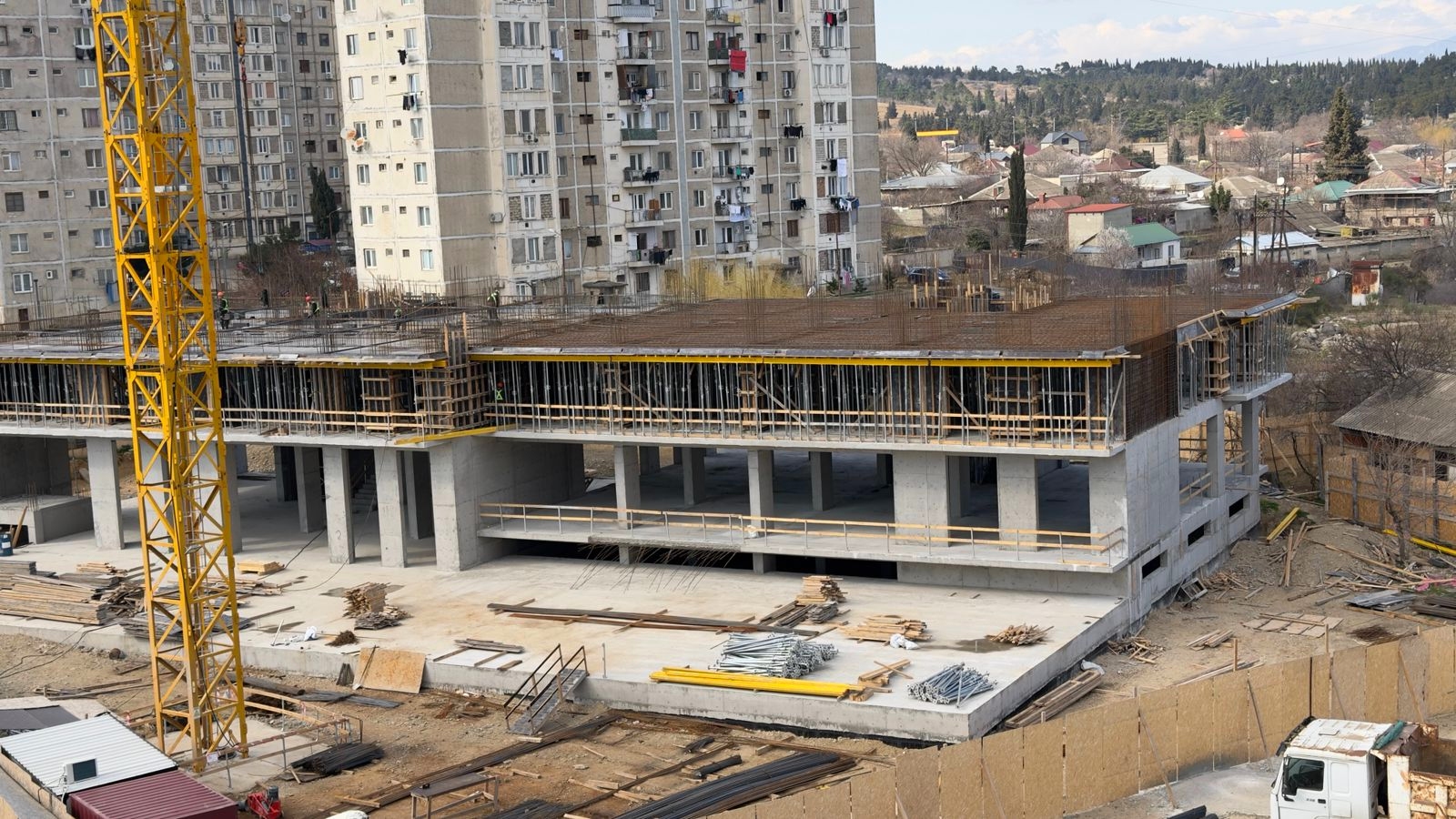

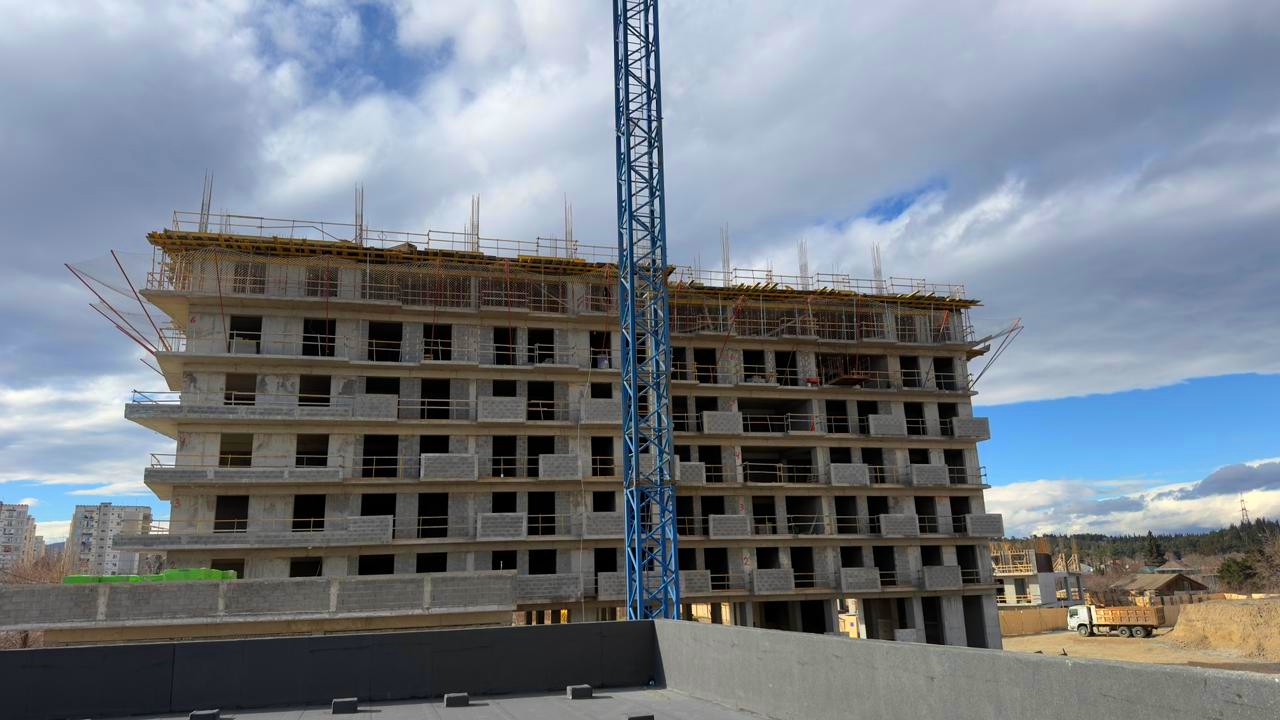

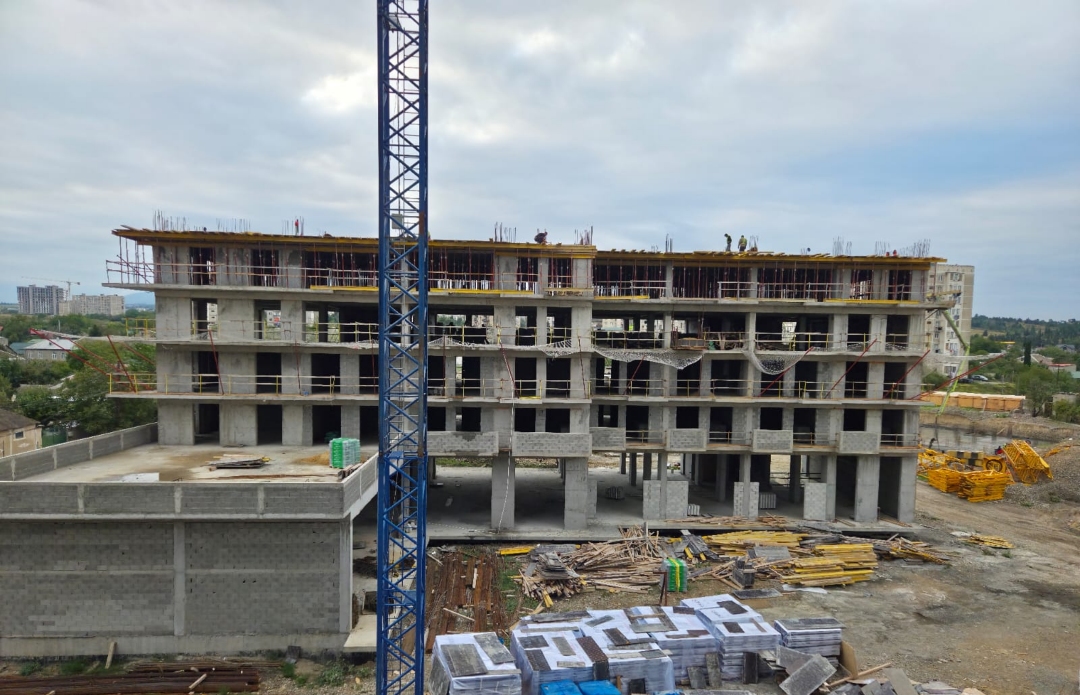

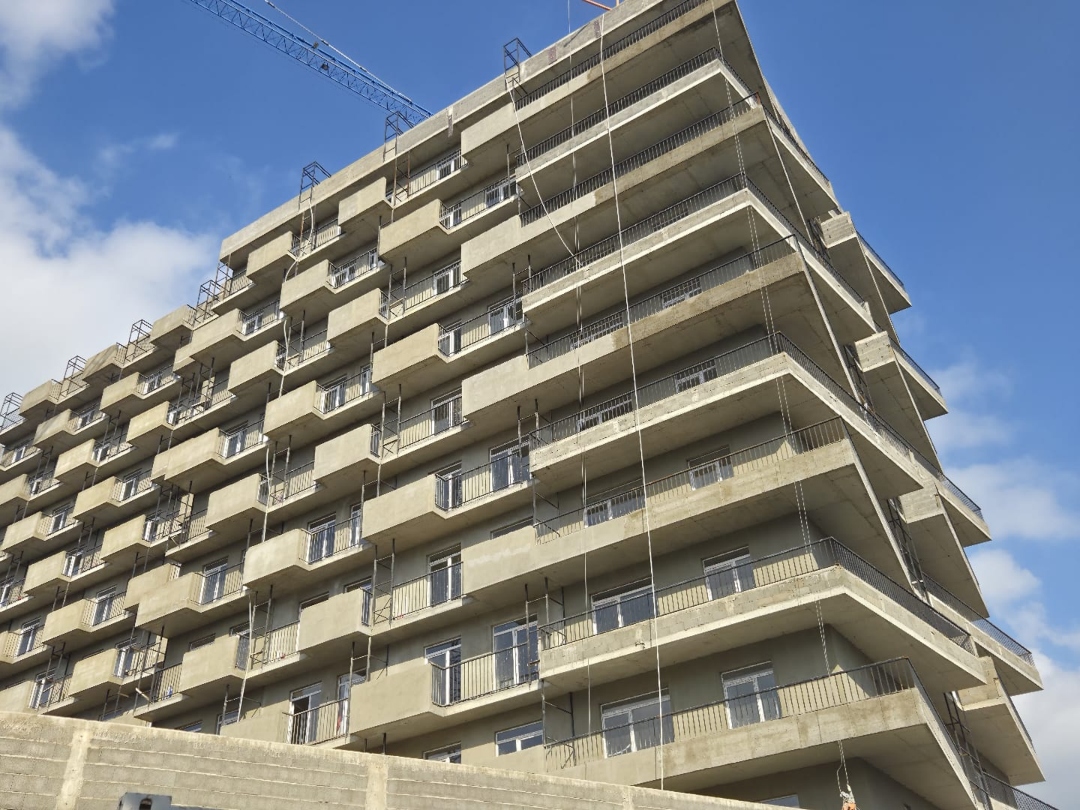

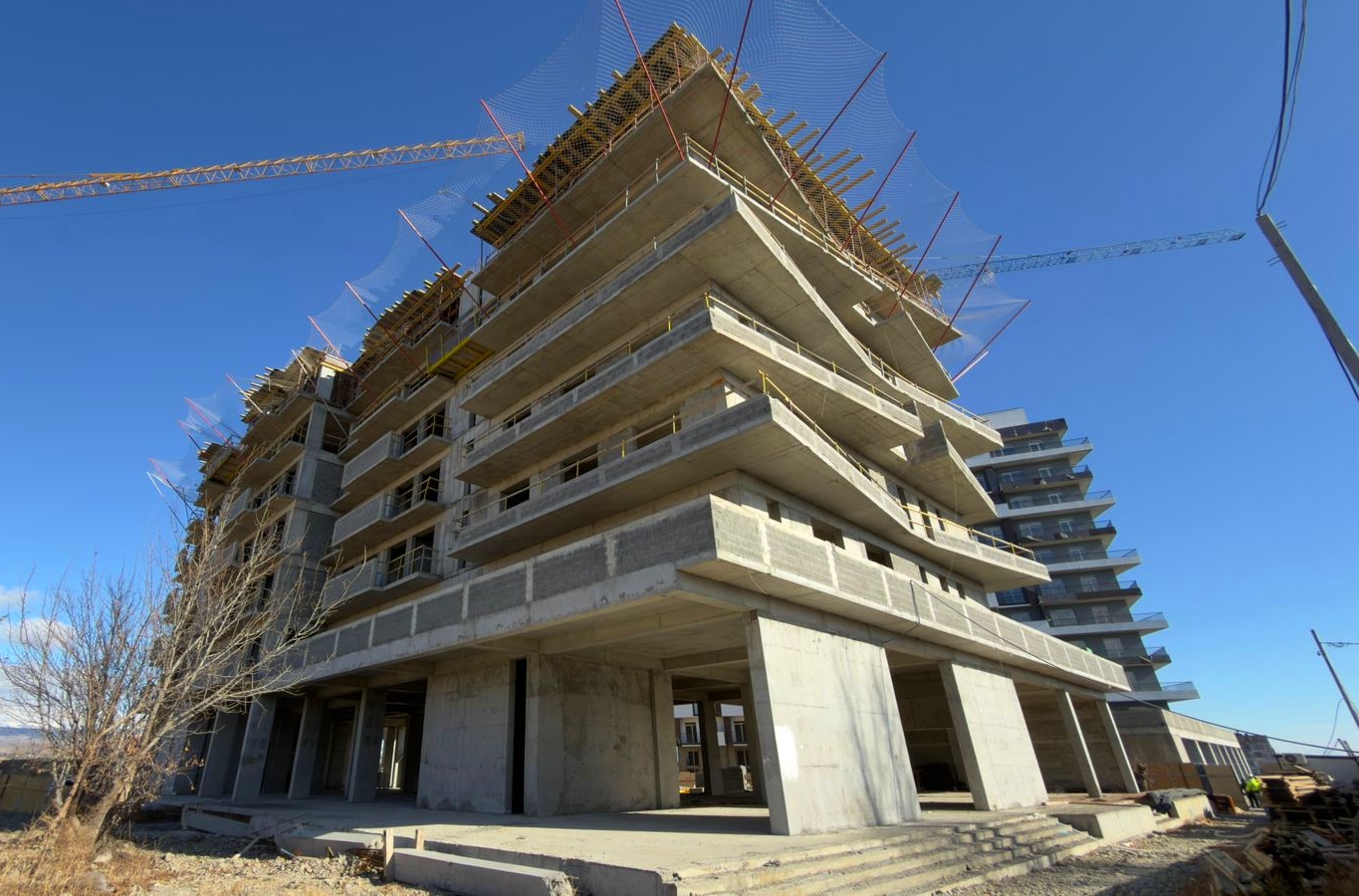

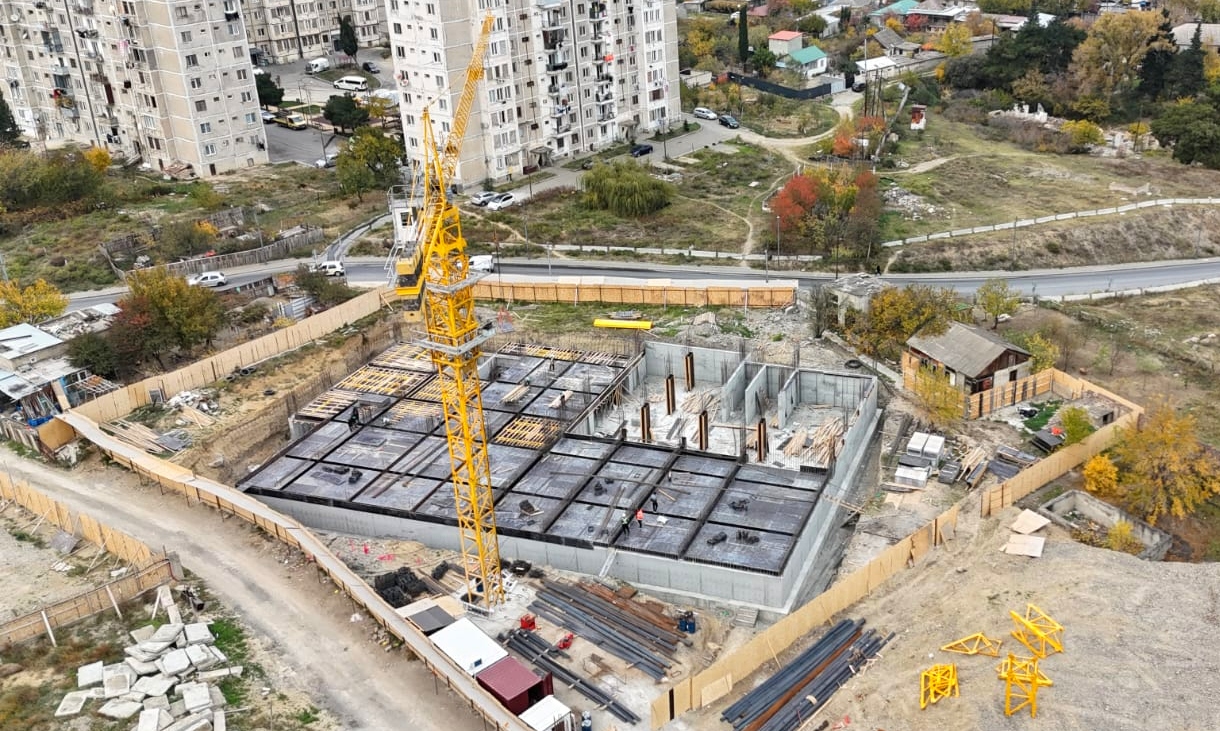

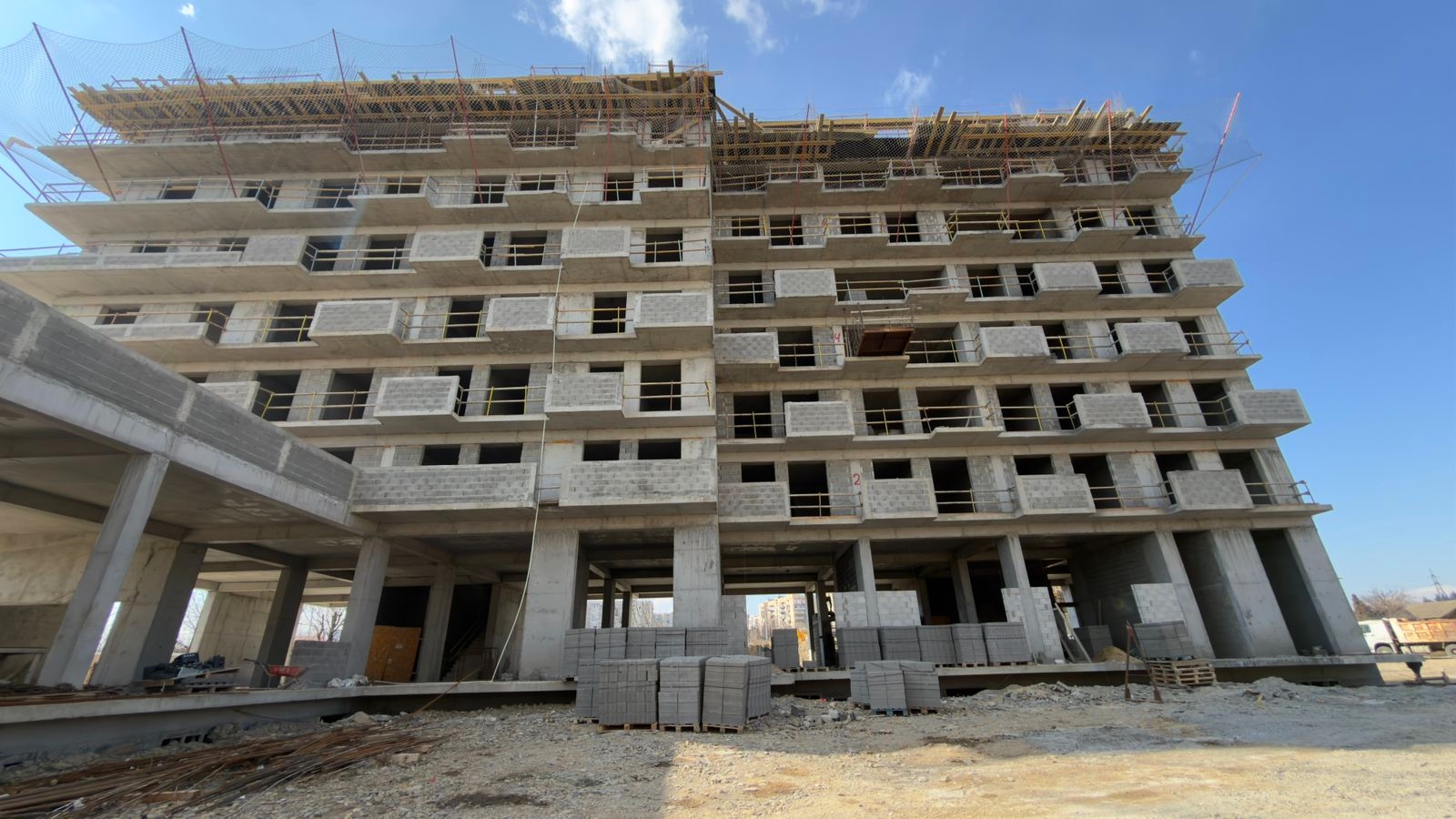

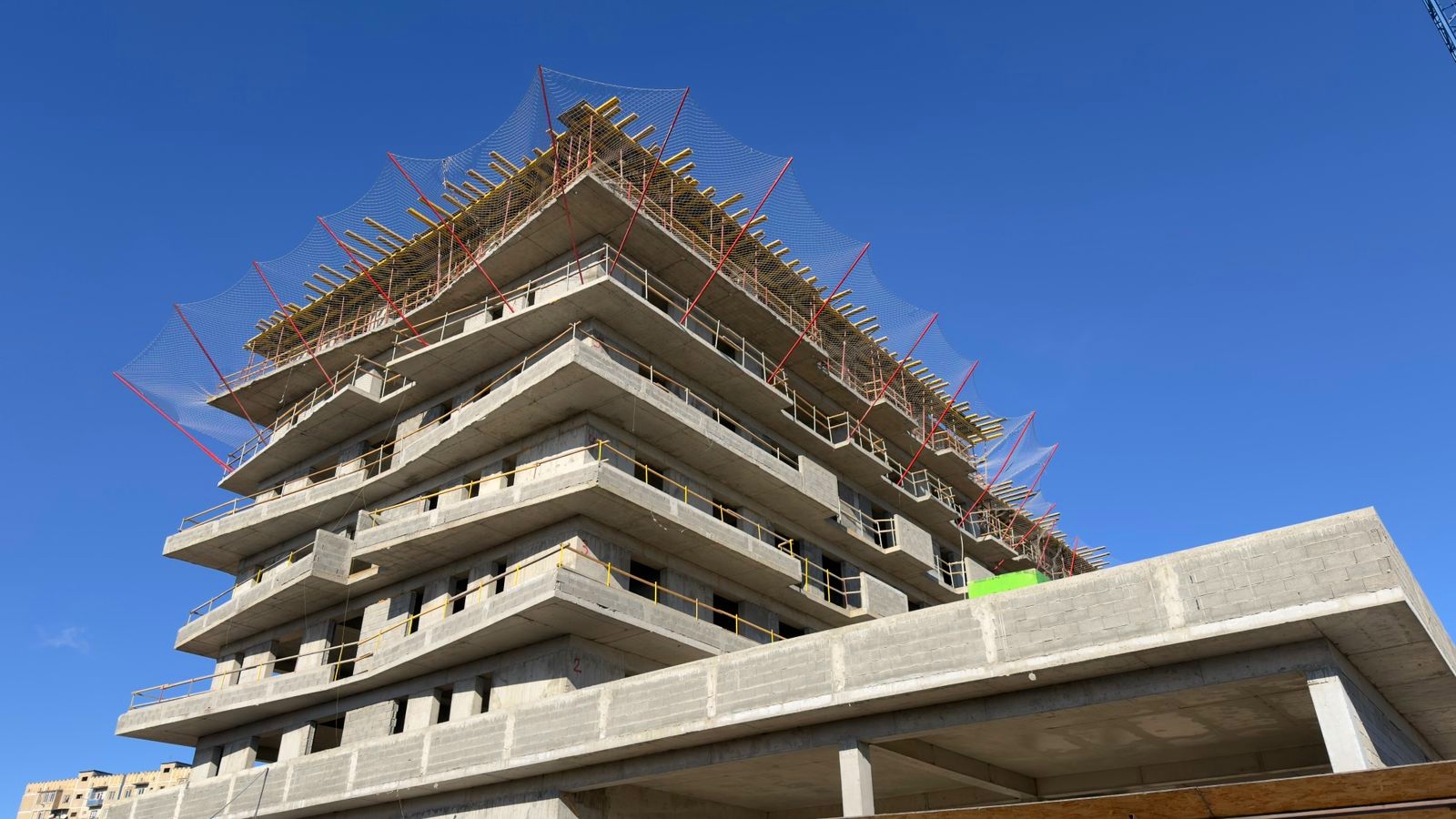

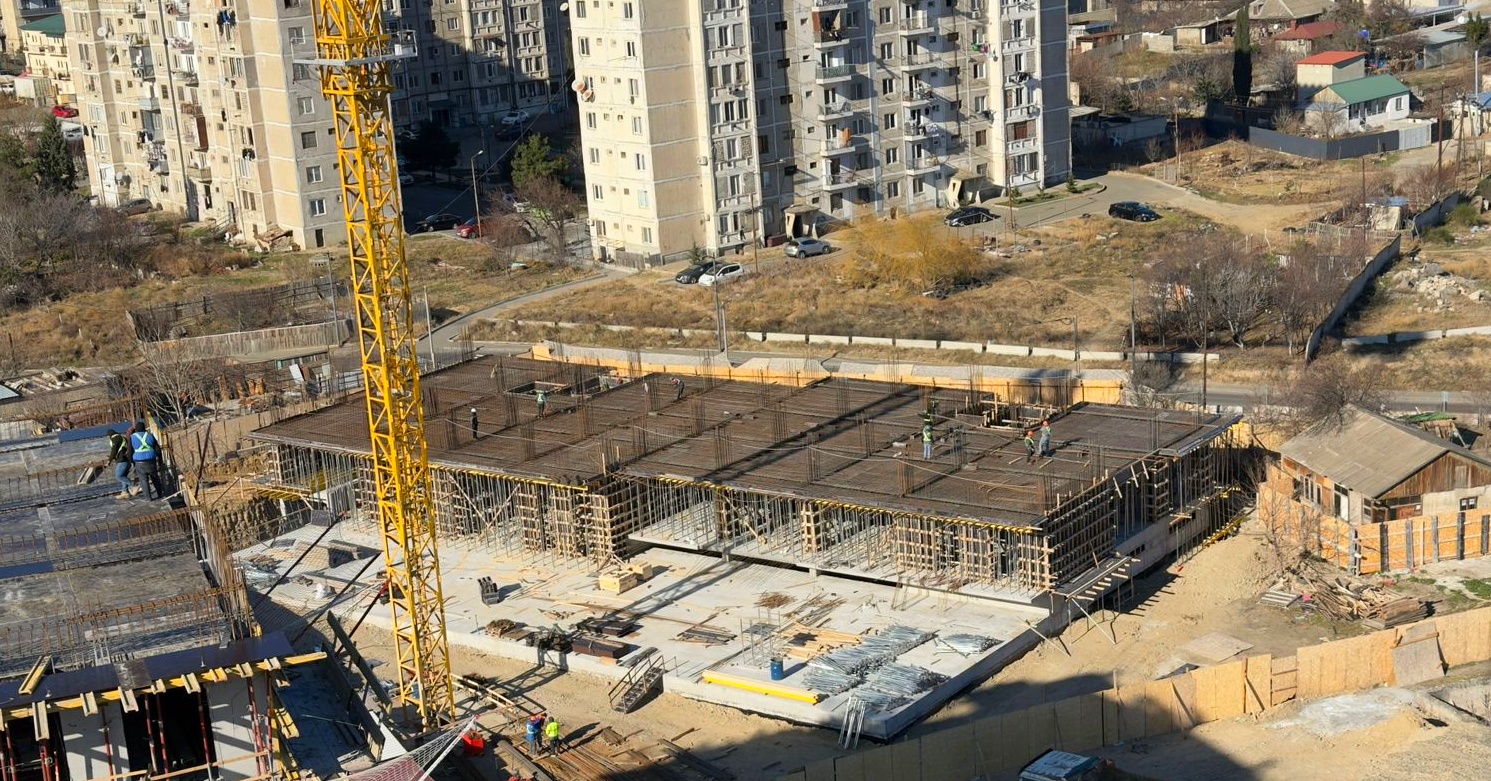

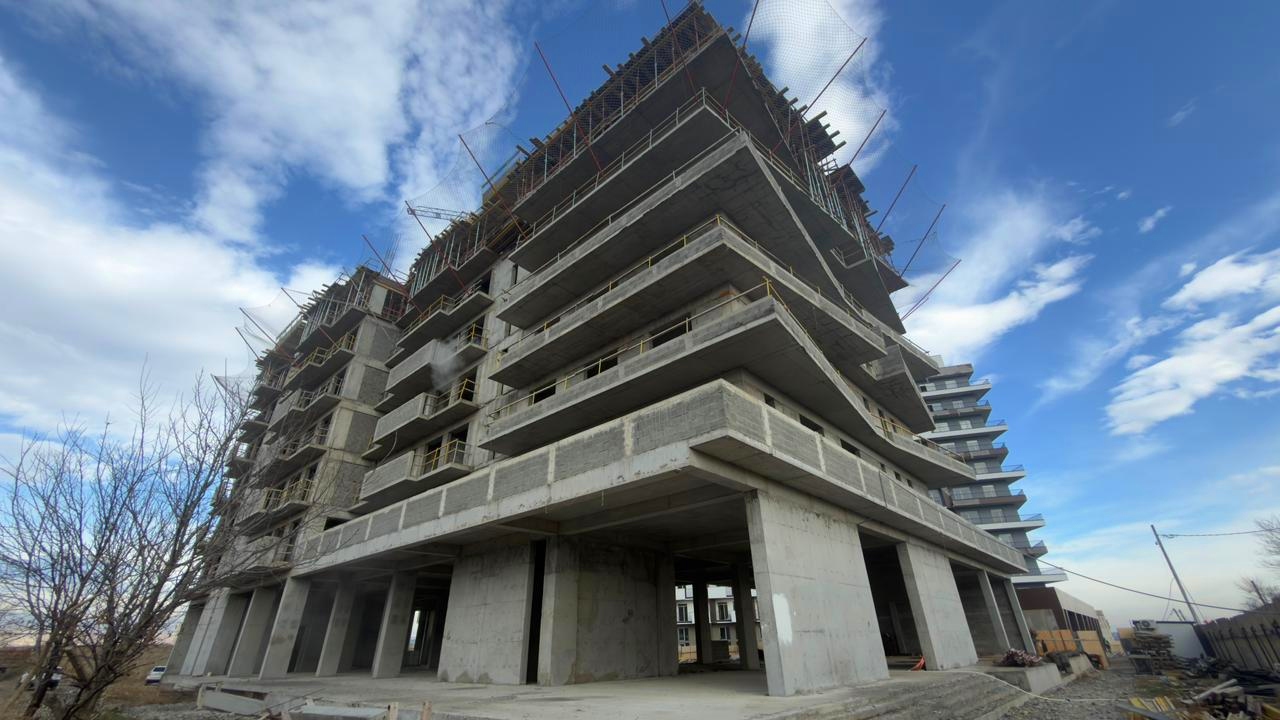

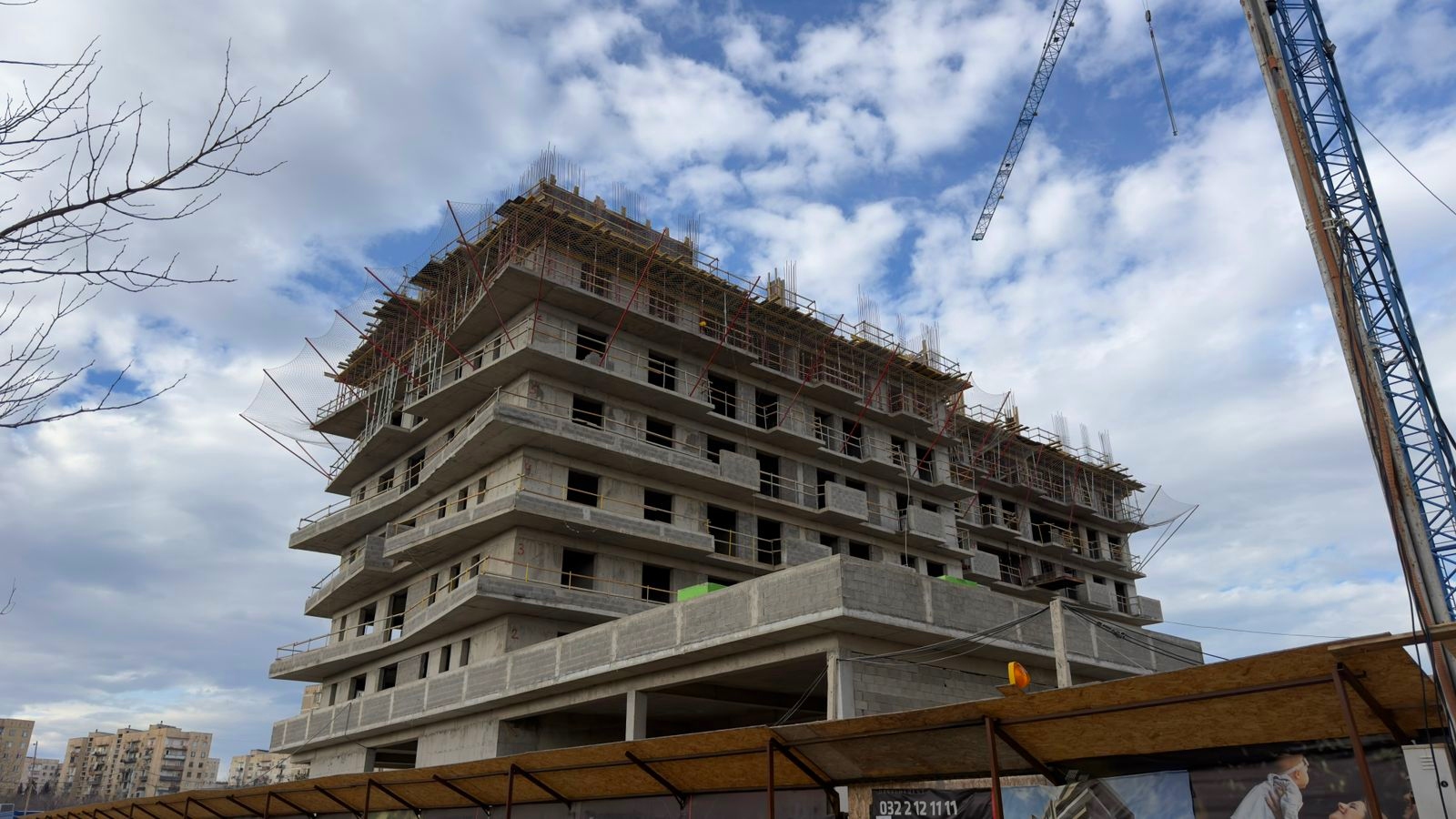

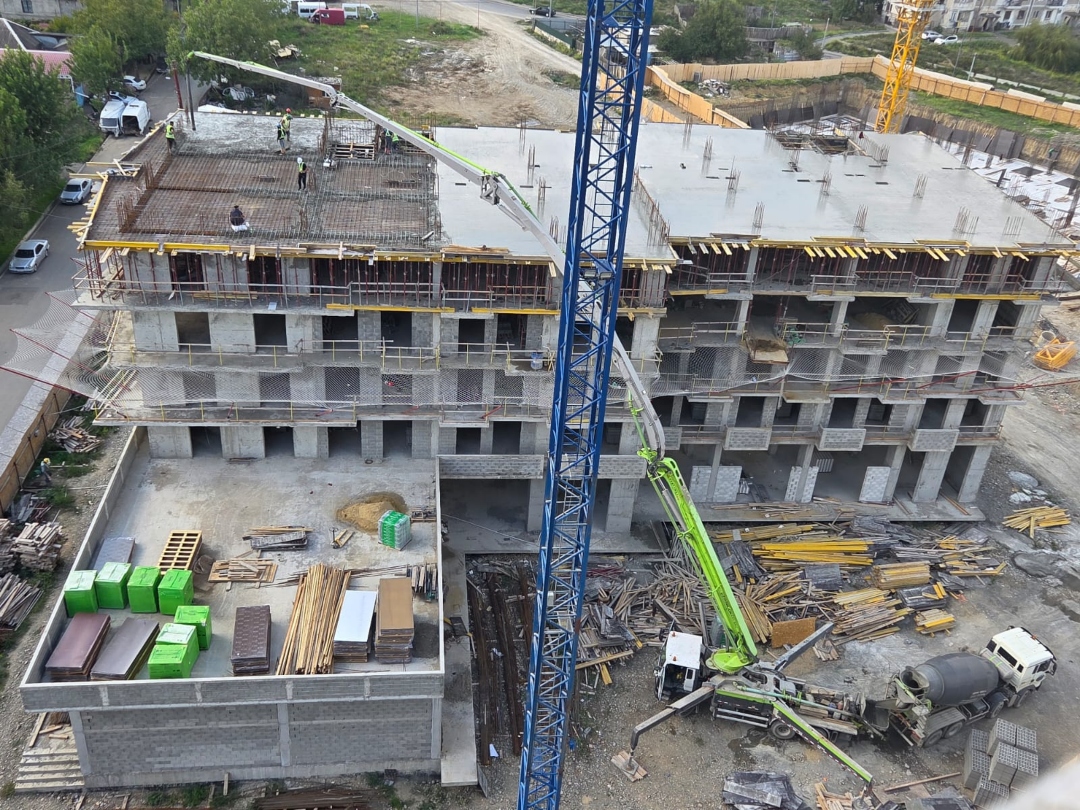

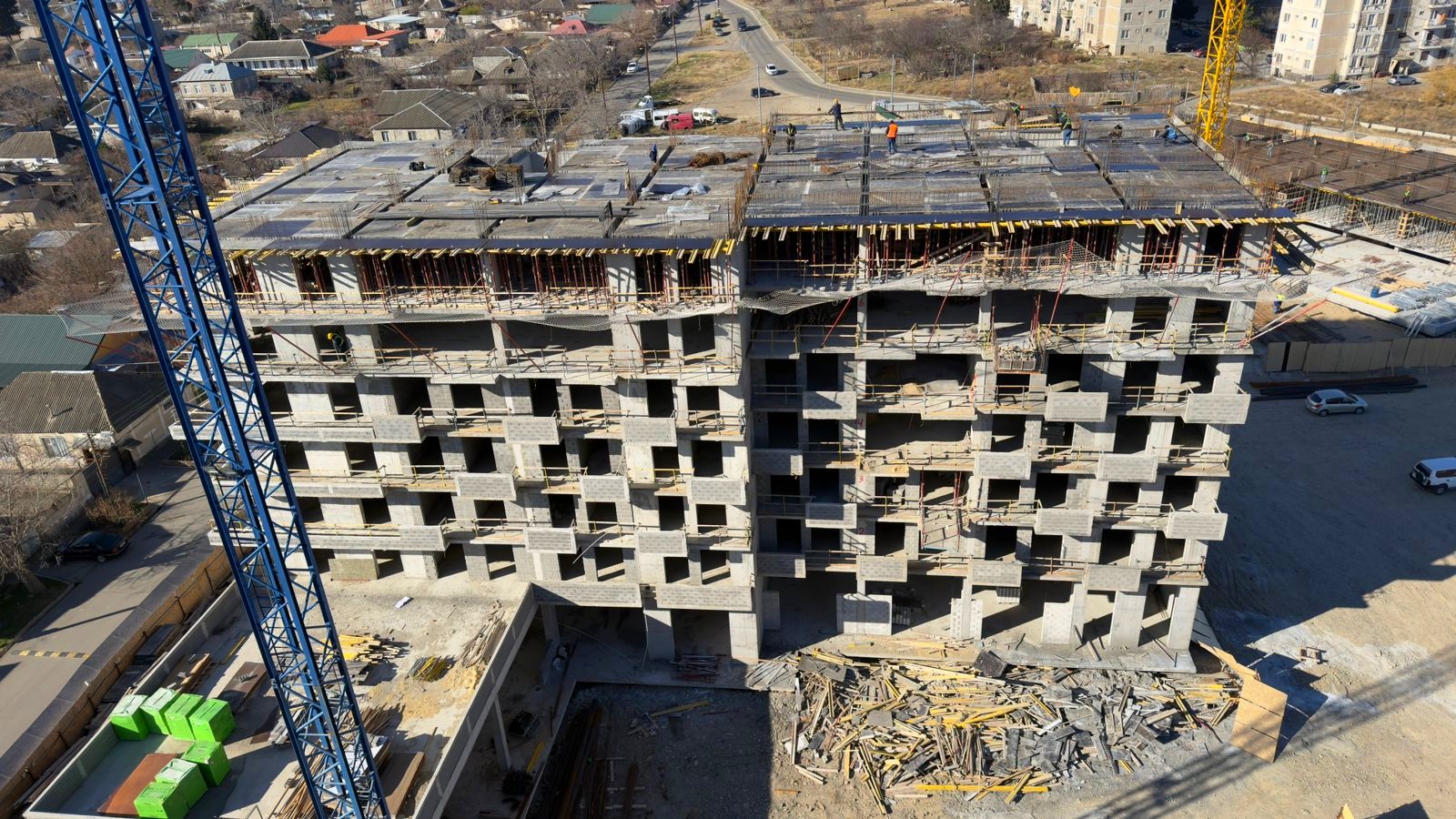

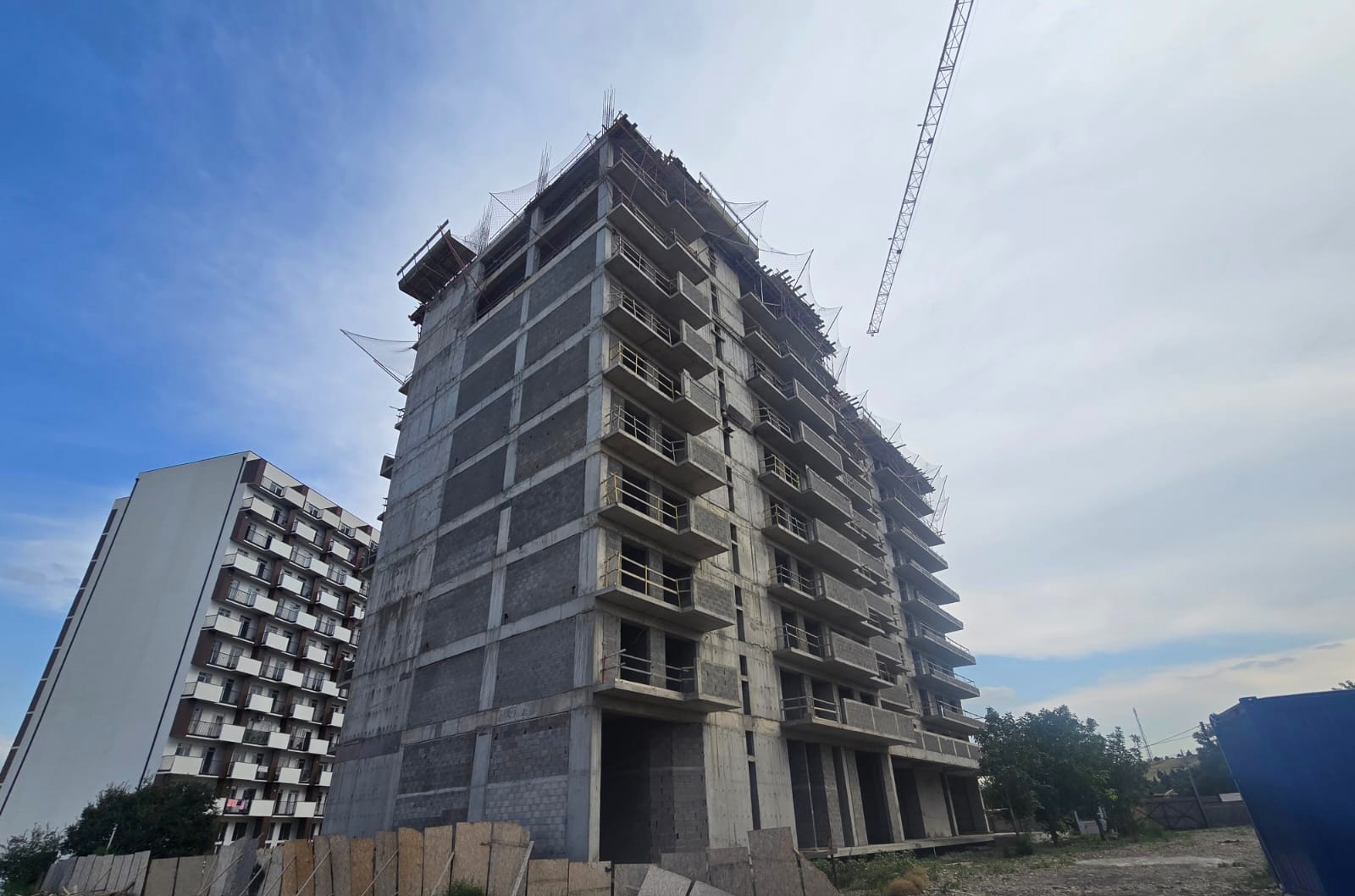

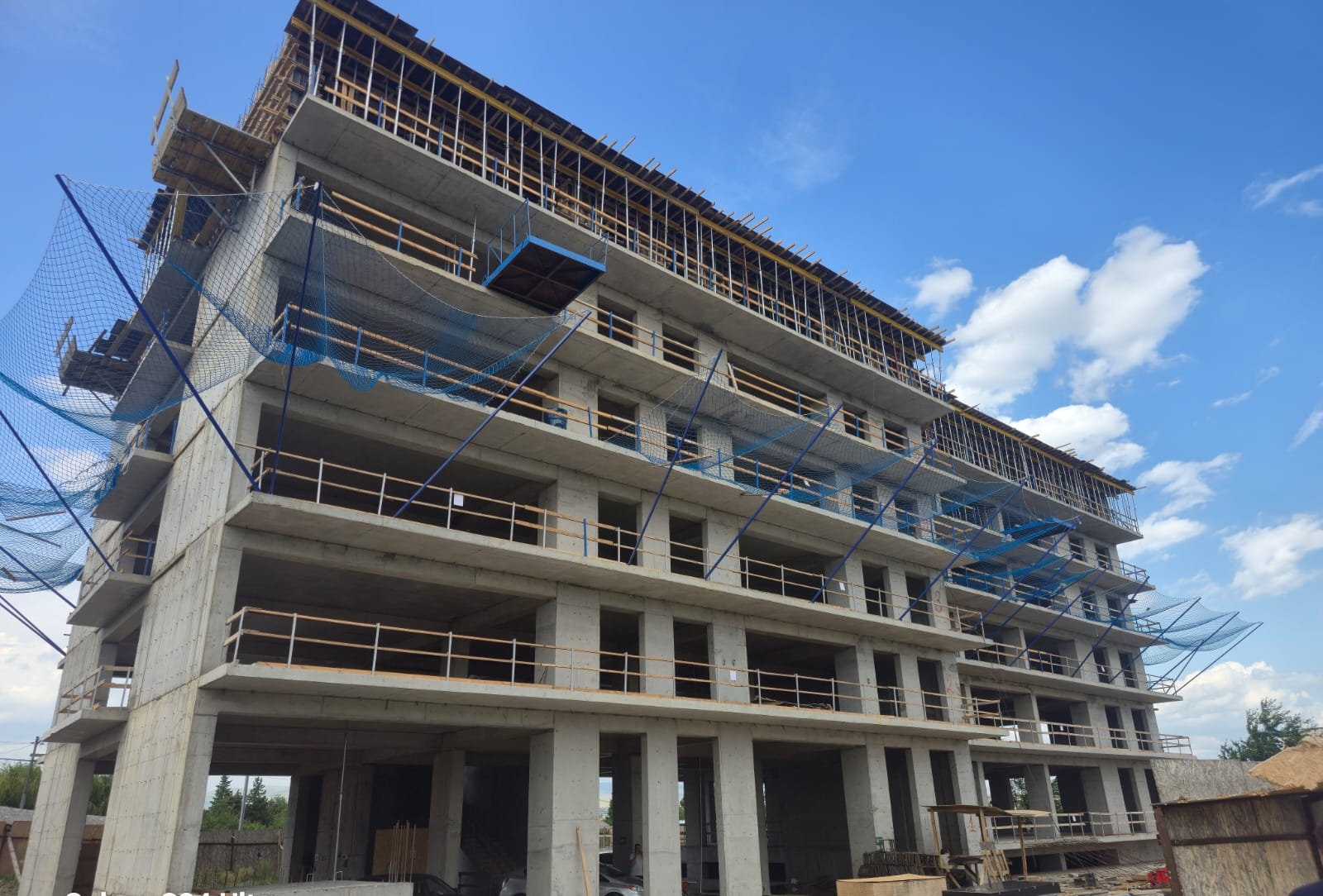

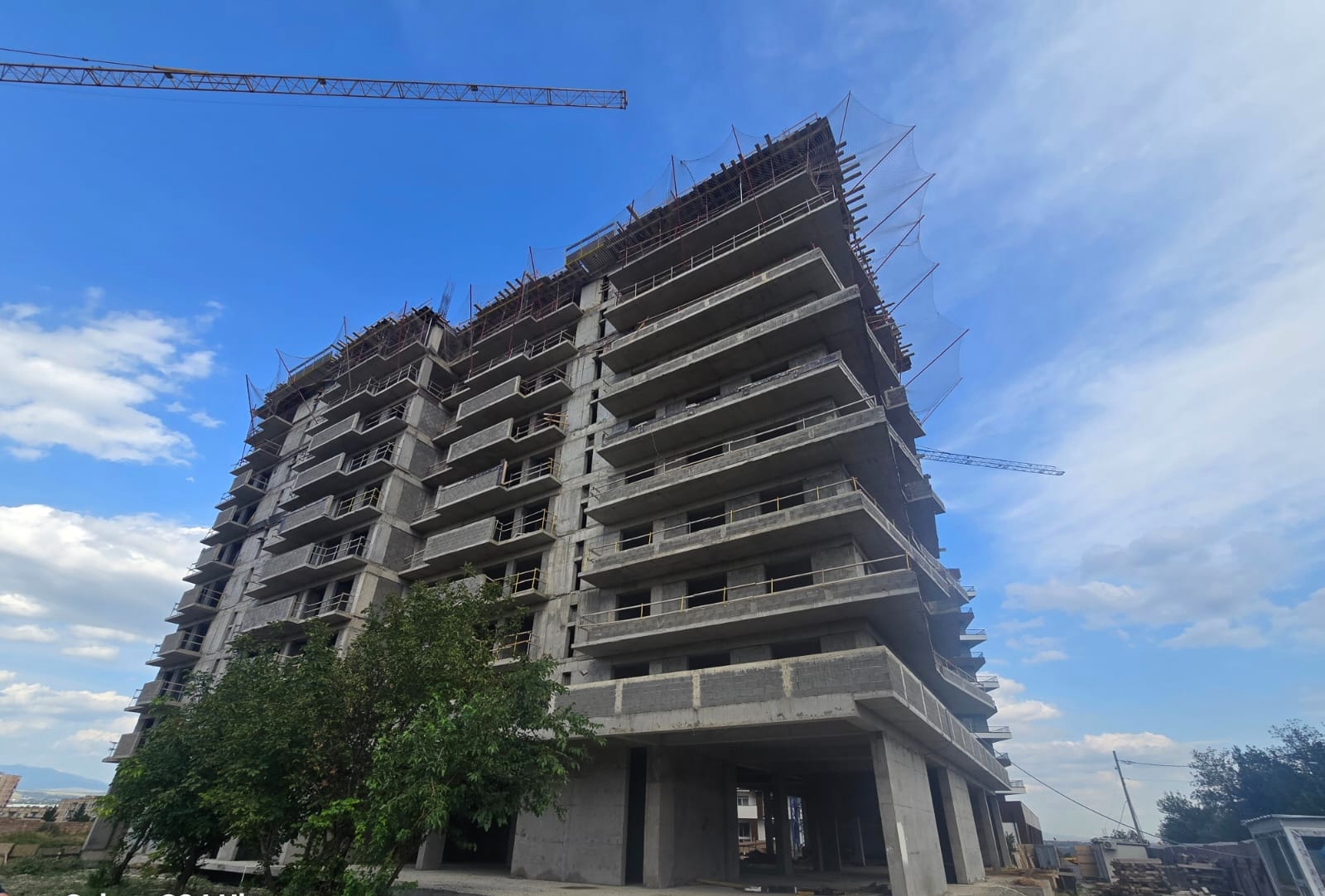

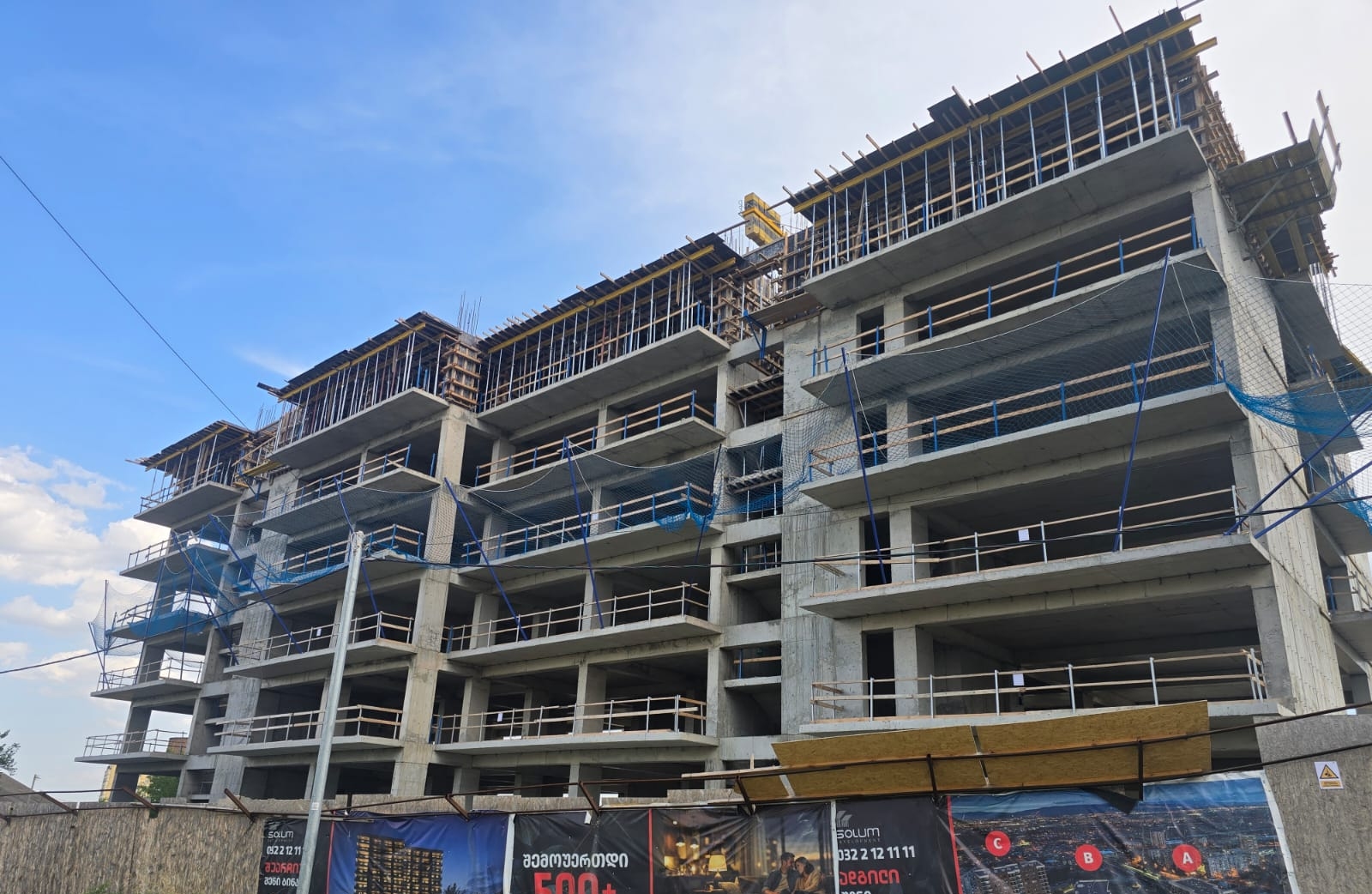

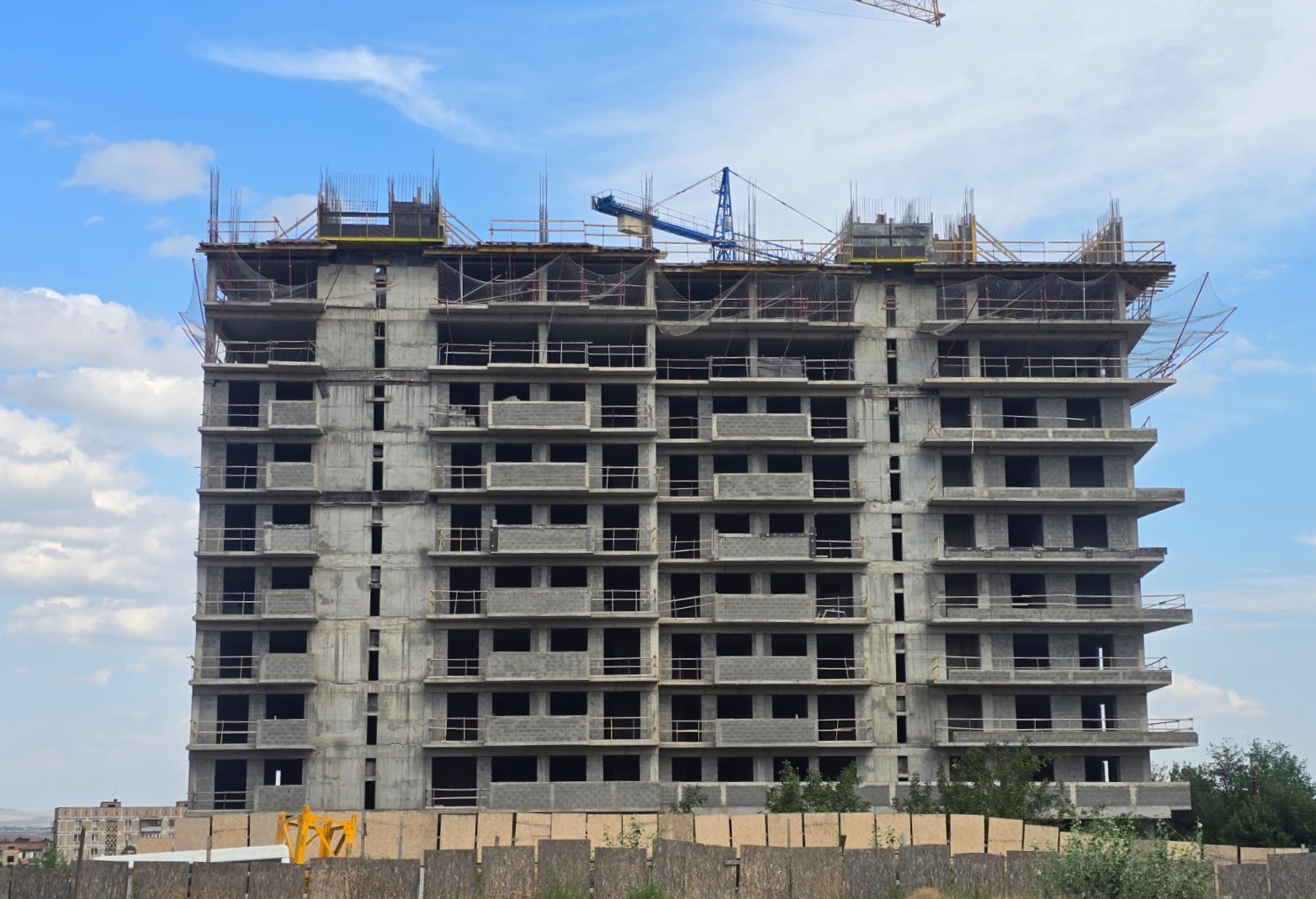

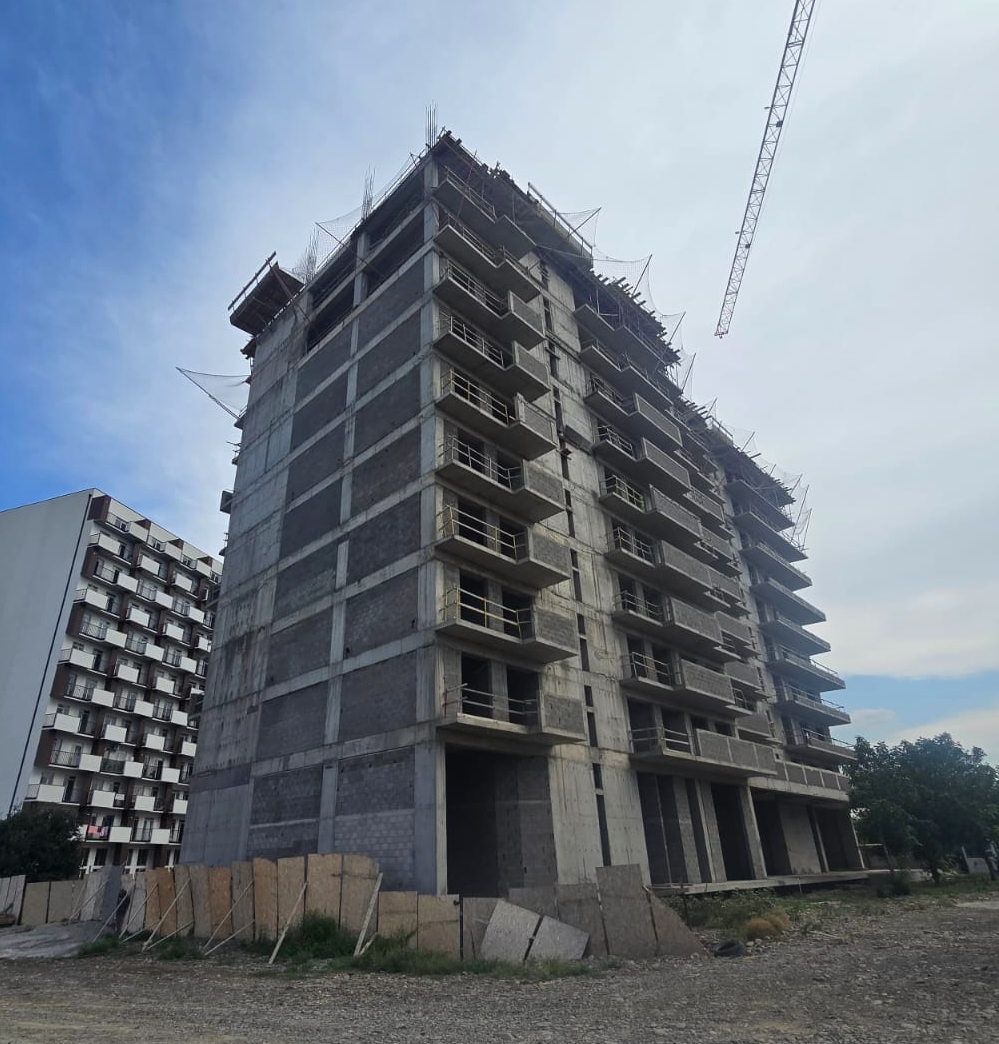

Block A -The work of laying the steps of the stairs is underway. At the same time, gas is being introduced into the apartments;

Block B - Work is underway to remove the columns and diaphragms of the 3rd floor (+8.10 mark).

3rd floor
timeline 1 timeline 1 timeline 1 timeline 1
02

06 June -2025

3rd floor

Block A -Thermal insulation has been installed on the external facade, including the 6th floor;

Block B - The 3rd floor slab (+8.10 mark) has been poured and work is underway to remove the columns.

3rd floor
timeline 2 timeline 2 timeline 2 timeline 2 timeline 2 timeline 2 timeline 2 timeline 2
03
23 May -2025

2nd floor columns

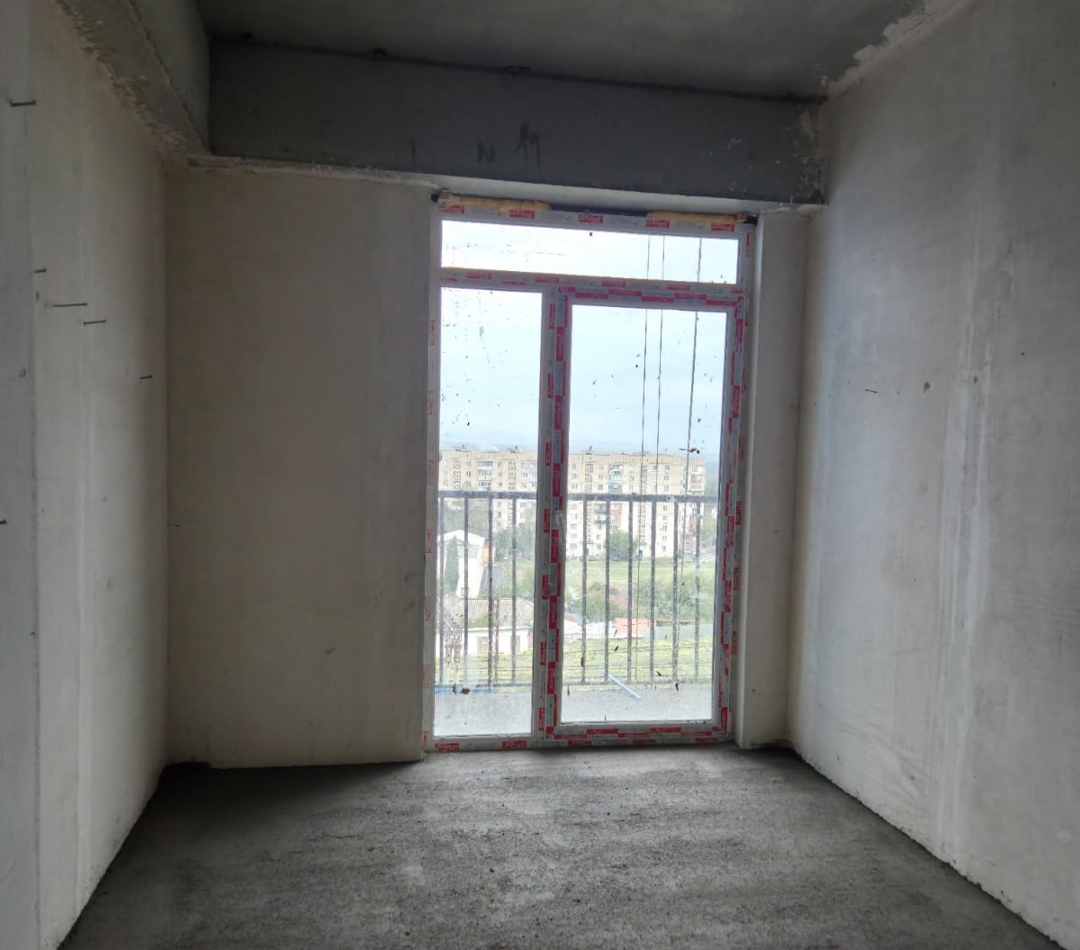

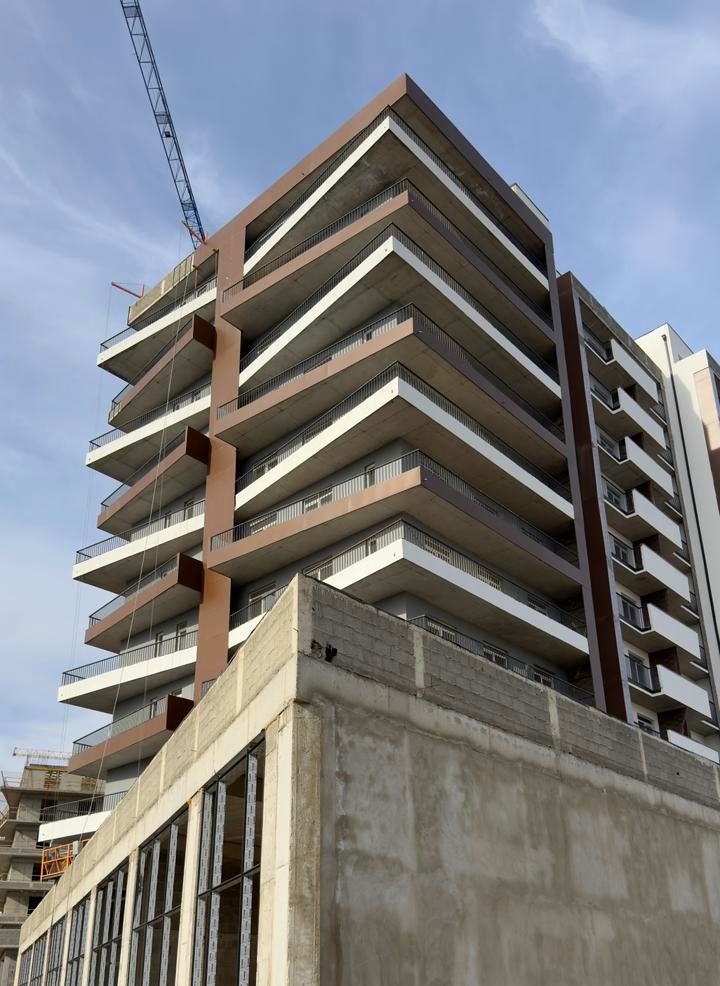

Block A - The internal plastering works of the project have been completed. At this stage, the cladding of the entrance walls is actively underway. In parallel, the installation of heat insulation materials and plastering works are being carried out on the facade;

Block B - Work is underway to remove the columns on the 2nd floor (+8.10 mark).

2nd floor columns
timeline 3 timeline 3 timeline 3 timeline 3
04
05 May -2025

2nd floor

A Block - The finishing works of the apartments and the entrance hall are underway;

B Block - The slab of the 2nd floor (+8.10 mark) is being laid.

2nd floor
timeline 4 timeline 4 timeline 4 timeline 4
05
09 April -2025

1st floor

A Block - Installation of metal-plastic doors and windows has been completed up to and including the 12th floor. At the same time, the finishing works of the apartments and the entrance hall are underway from the 3rd, 4th, 9th - 12th floors;

B Block - Installation of columns and diaphragms on the 1st floor is underway.

1st floor
timeline 5 timeline 5 timeline 5 timeline 5 timeline 5 timeline 5
06
26 March -2025

Monolith

Block A - The construction of the monolithic structure has been completed. The 4th and 9th floors have been completed, and the 3rd and 10th floors are currently being tiled.

Block B - The roofing of the 1st commercial floor has been completed (+5.00 mark) and the removal of the columns and beams of the 2nd floor is underway.

Monolith
timeline 6 timeline 6 timeline 6 timeline 6
07
07 March -2025

Internal partitions

Block A - The work of removing internal partitions has been completed. Metal-plastic doors and windows have been installed from the 2nd to the 12th floor inclusive. The apartments are being tiled on the 3rd, 4th, 8th and 9th floors;

Block B - The roofing slab of the 1st commercial floor has been poured.

Internal partitions
timeline 7 timeline 7 timeline 7
08

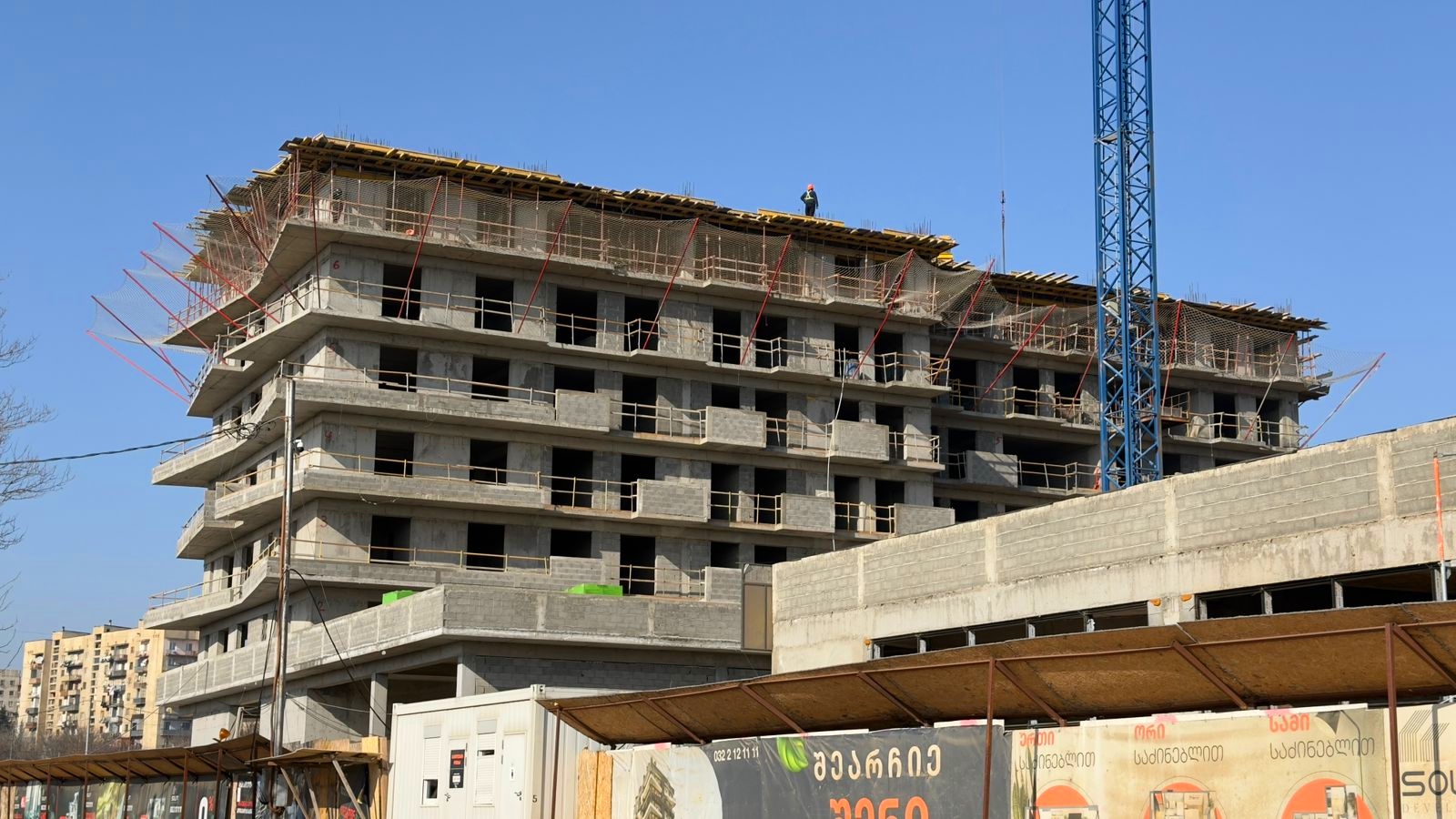

06 February -2025

12nd floor

Block A - The work of removing the internal and neighboring partitions of the 12th floor has been completed, and the installation of metal-plastic doors and windows is underway;

Block B - The diaphragm of the 1st floor is being poured.

12nd floor
timeline 8 timeline 8
09
21 January -2025

Commercial floor

Block A - Removal of internal and adjacent partitions on the 11th floor completed;

Block B - Flooring of the first commercial floor poured.

Commercial floor
timeline 9 timeline 9 timeline 9 timeline 9
10
04 January -2025

11th floor

Block A - Removal of internal and adjacent partitions on the 11th floor is underway;

Block B - Concrete exterior walls on the -1st floor have been poured. The diaphragm and columns are also being poured.

11th floor
timeline 10 timeline 10 timeline 10
11
20 December -2024

11th floor

Block A - Removal of internal partitions on the 11th floor;

Block B - Removal of columns and pouring of concrete on the -1st floor is underway.

11th floor
timeline 11 timeline 11 timeline 11 timeline 11 timeline 11
12
04 December -2024

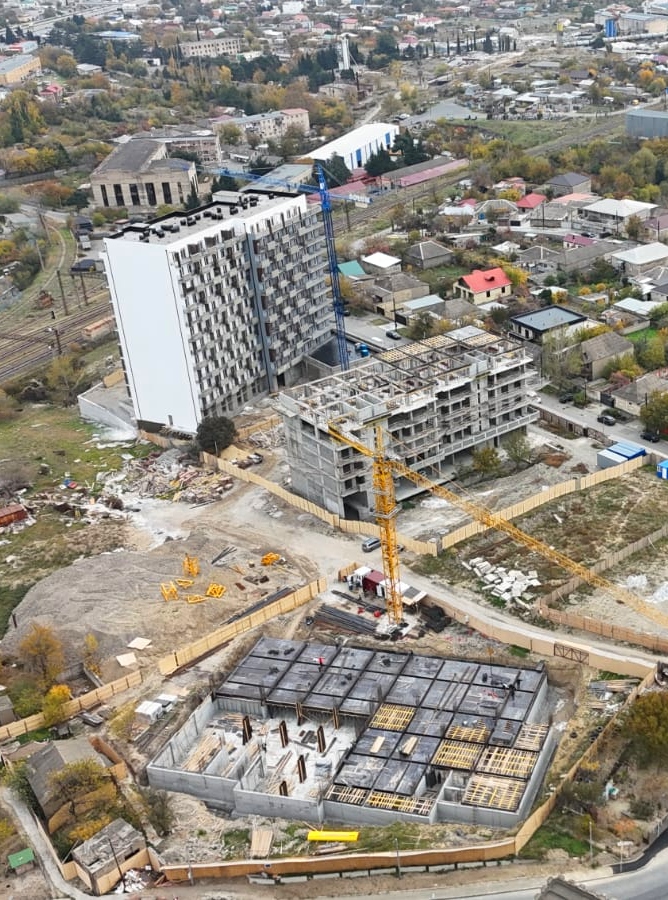

-1st floor tile

Block A - The removal of internal and adjacent partitions on the 10th floor is underway. Installation of metal-plastic doors and windows has been completed up to and including the 5th floor;

Block B - The slab of the 1st floor (1250 cubic meters of concrete) has been poured and floor leveling works are underway.

-1st floor tile
timeline 12 timeline 12 timeline 12 timeline 12 timeline 12
13
22 November -2024

10th floor

Block A - Removal of internal and adjacent partitions on the 10th floor;

Block B - Second layer of reinforcement is being installed to begin pouring concrete into the foundation.

10th floor
timeline 13 timeline 13 timeline 13 timeline 13
14
05 November -2024

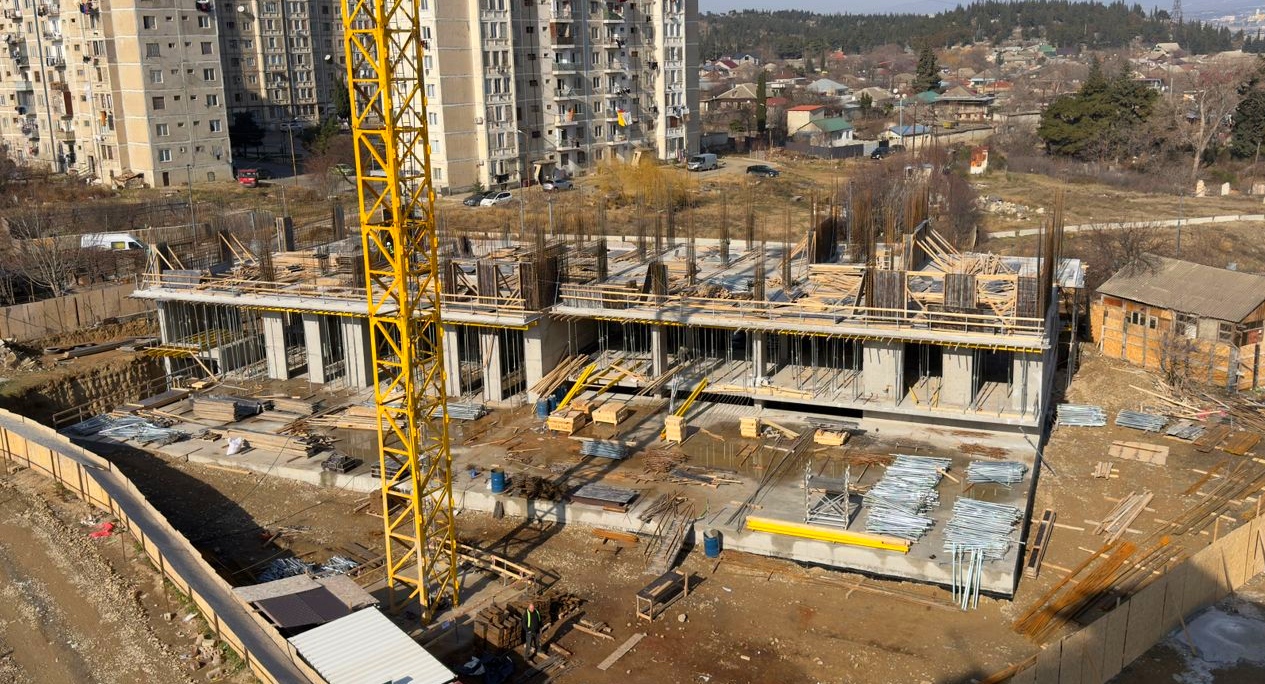

The first layer of the foundation

Block A - removal of internal and neighboring partitions on the 8th and 9th floors is in progress;

Block B - the foundation was placed on a rock mass, which is distinguished by its exceptional strength and seismic resistance. The first layer of the foundation has been poured, the reinforcement is being tied to pour the 2nd slab of the foundation.

The first layer of the foundation
timeline 14 timeline 14
15
23 October -2024

9th floor

Block A - the construction of the block on the 9th floor is in progress;

Block B - ground cutting works are being completed.

9th floor
timeline 15 timeline 15 timeline 15 timeline 15
16
09 October -2024

8th and 9th floor

ะ แƒ‘แƒšแƒแƒ™แƒ˜ - แƒ›แƒ˜แƒ›แƒ“แƒ˜แƒœแƒแƒ แƒ”แƒแƒ‘แƒก แƒ›แƒ”-8 แƒ“แƒ แƒ›แƒ”-9 แƒกแƒแƒ แƒ—แƒฃแƒšแƒ˜แƒก แƒกแƒแƒ›แƒ”แƒ–แƒแƒ‘แƒšแƒ แƒขแƒ˜แƒฎแƒ แƒ”แƒ‘แƒ˜แƒก แƒแƒ›แƒแƒงแƒ•แƒแƒœแƒ˜แƒก แƒกแƒแƒ›แƒฃแƒจแƒแƒแƒ”แƒ‘แƒ˜;

B แƒ‘แƒšแƒแƒ™แƒ˜ - แƒ›แƒ˜แƒ›แƒ“แƒ˜แƒœแƒแƒ แƒ”แƒแƒ‘แƒก แƒ™แƒแƒขแƒšแƒแƒ•แƒแƒœแƒ˜แƒก แƒแƒ›แƒแƒฆแƒ”แƒ‘แƒ˜แƒก แƒกแƒแƒ›แƒฃแƒจแƒแƒแƒ”แƒ‘แƒ˜.

8th and 9th floor
timeline 16 timeline 16 timeline 16
17
22 September -2024

B block

Land preparation works are underway in Block B.

B block
timeline 17 timeline 17 timeline 17
18
09 September -2024

Partitions of the 7th floor

In block A, the work of removing the neighborhood partitions of the 7th floor is in progress.

Partitions of the 7th floor
timeline 18 timeline 18 timeline 18
19
23 August -2024

7th floor

In block ะ, the work of removing the neighborhood partitions of the 6th and 7th floors is in progress.

7th floor
timeline 19 timeline 19 timeline 19 timeline 19 timeline 19
20
19 July -2024

Internal works

In Block ะ, the internal partitions on the 6th floor were completed and on the 7th floor, block piling of neighborhood walls is underway.

Internal works
timeline 20 timeline 20 timeline 20
21
01 July -2024

12th floor

The roof tile of the 12th floor was completed. Block piling works for the facade and neighborhood walls are underway.

12th floor
timeline 21 timeline 21 timeline 21
22
10 June -2024

The roof of the 11th floor

The roof tile of the 11th floor is completed in Ponichala.

The roof of the 11th floor
timeline 22 timeline 22 timeline 22
23
24 May -2024

11th floor

The tile of the 11th floor is completed in Ponichala.

11th floor
timeline 23
24
20 May -2024

10th floor

The columns of the 10th floor have been built, and preparatory works for covering the roof are underway. At the same time, the work of assembling the inner walls of the apartments on the 4th floor is going on.

10th floor
timeline 24 timeline 24
25
07 May -2024

The roof of the 9th floor

The roof tile of the 9th floor is completed in Ponichala. At the same time, the works of piling the interior of the apartments from the 2nd to the 4th floor inclusive are going on.

The roof of the 9th floor
timeline 25 timeline 25 timeline 25 timeline 25 timeline 25
26
22 April -2024

9th Floor

The arrangement of diaphragms for the column of the 9th floor has been completed, concrete will be poured today. At the same time, the works of assembling the facade radish on the inner and outer perimeter of the apartments on the 2-4 floors are going on.

9th Floor
timeline 26 timeline 26 timeline 26 timeline 26 timeline 26 timeline 26
27
01 April -2024

8th floor

The work of arranging the roof tile of the 8th floor is being completed. Also, on the second residential floor, the partition walls separating the outer facade and the inner apartments are being constructed.

8th floor
timeline 27
28
18 January -2024

5th Floor

The 5th floor tile was poured on the ongoing construction in Ponichala.

5th Floor
timeline 28
29
24 December -2023

4th Floor

The 4th floor has been covered and the columns of the 5th floor are being built.

4th Floor
timeline 29 timeline 29 timeline 29
30
05 December -2023

4th Floor

The fourth floor columns and diaphragm arrangement works are underway.

4th Floor
timeline 30 timeline 30
31
03 November -2023

3rd Floor

Preparation works for the third floor columns have started in Ponichala.

3rd Floor
timeline 31 timeline 31 timeline 31
32
10 October -2023

2nd Floor

In Ponichala, the laying of the 2nd floor slab has been completed. We are waiting for it to dry.

2nd Floor
timeline 32 timeline 32
33
13 September -2023

Pouring concrete

Concrete works of commercial floor columns and diaphragms are underway in Ponichala.

Pouring concrete
timeline 33 timeline 33 timeline 33 timeline 33
34
31 August -2023

Commercial Floor

A commercial floor tile was poured in Ponichala during the construction of Solum Development.

Commercial Floor
timeline 34 timeline 34
35
08 August -2023

Overlapping

In Ponichala Roofing slabs for the parking floor are being arranged

Overlapping
timeline 35 timeline 35
36
12 July -2023

Concrete pouring

1400 cubic meters of concrete were poured in Ponichala.

Concrete pouring
timeline 36
37
29 June -2023

arrangement of fittings

The slab reinforcement of the object is being arranged. 152 tons of reinforcement were purchased.

arrangement of fittings
timeline 37
38
03 June -2023

Perometer mold

In Ponichala, the works of arranging the base of the foundation slab and the external perometer mold have been completed.

Perometer mold
timeline 38
39
06 May -2023

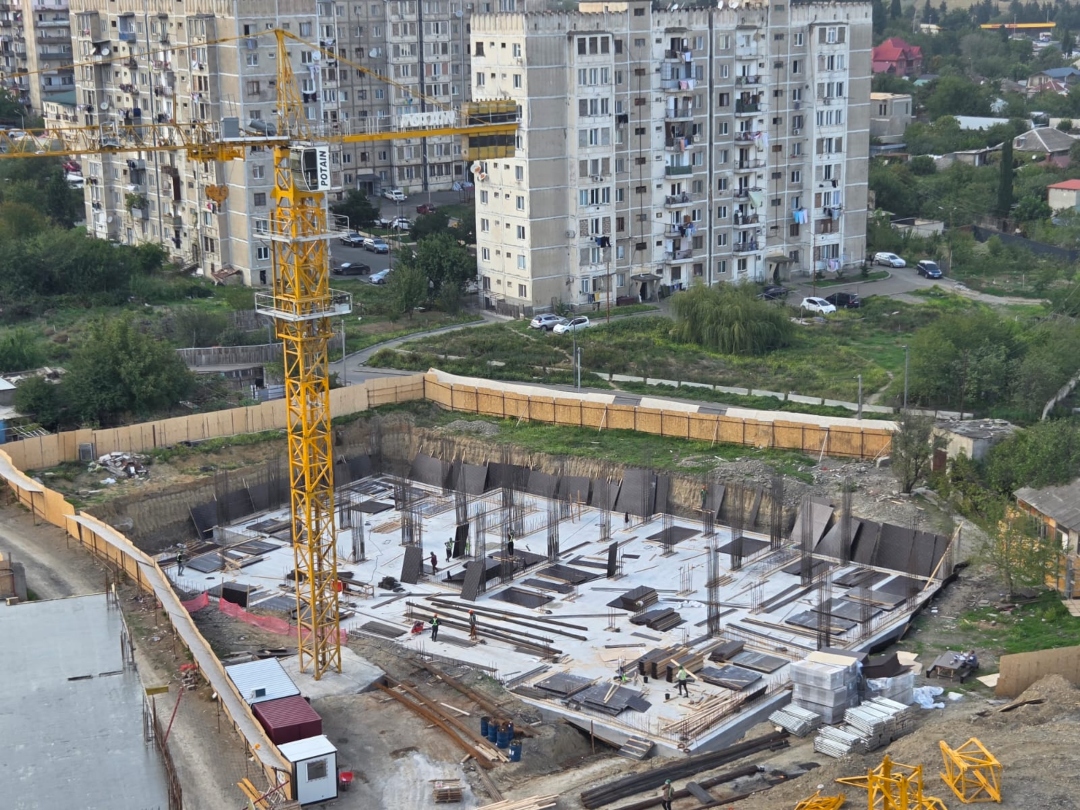

Foundation

In Ponichal project, the preparatory concrete layer works for the foundation have been completed. 100m3 of concrete was used.

Foundation
timeline 39 timeline 39 timeline 39
40
04 April -2023

Land works

The construction of the new project of Solum Development has started in Ponichala. Earth removal works are in progress.

Land works
